Skip to main content
2024 Q3

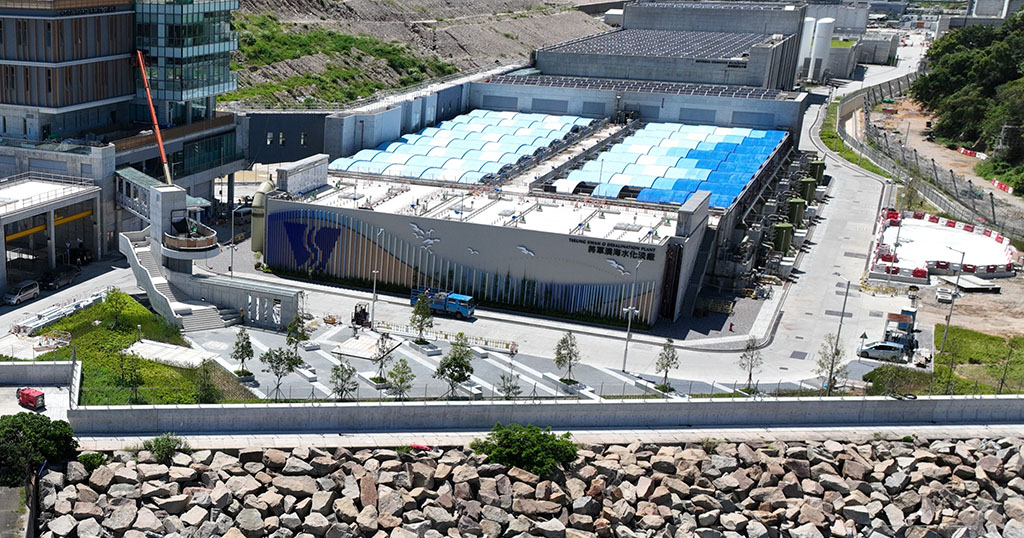

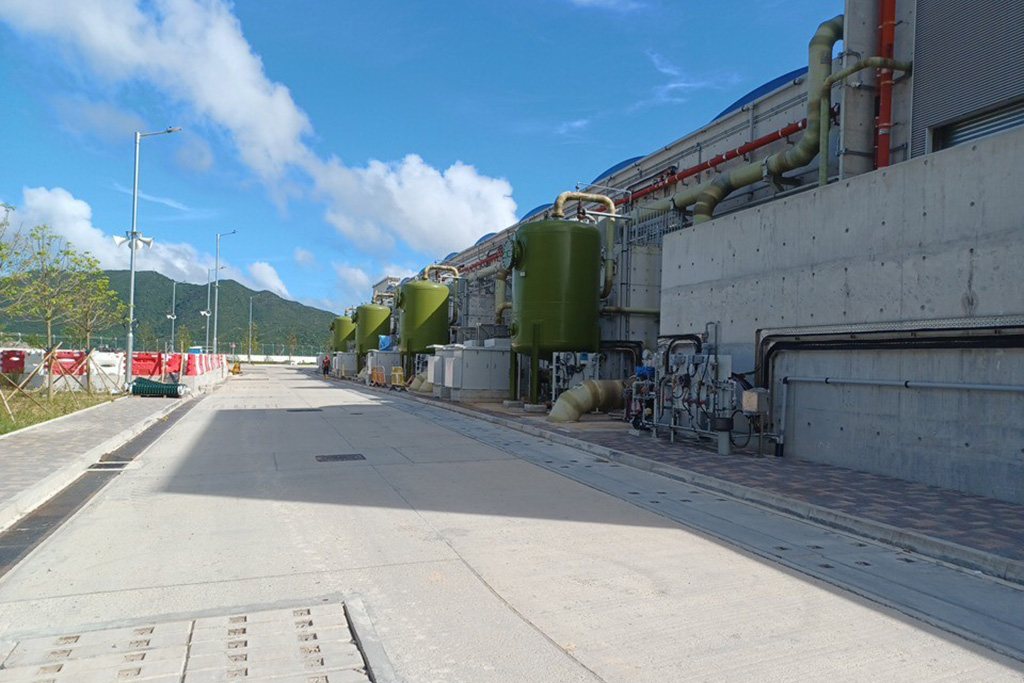

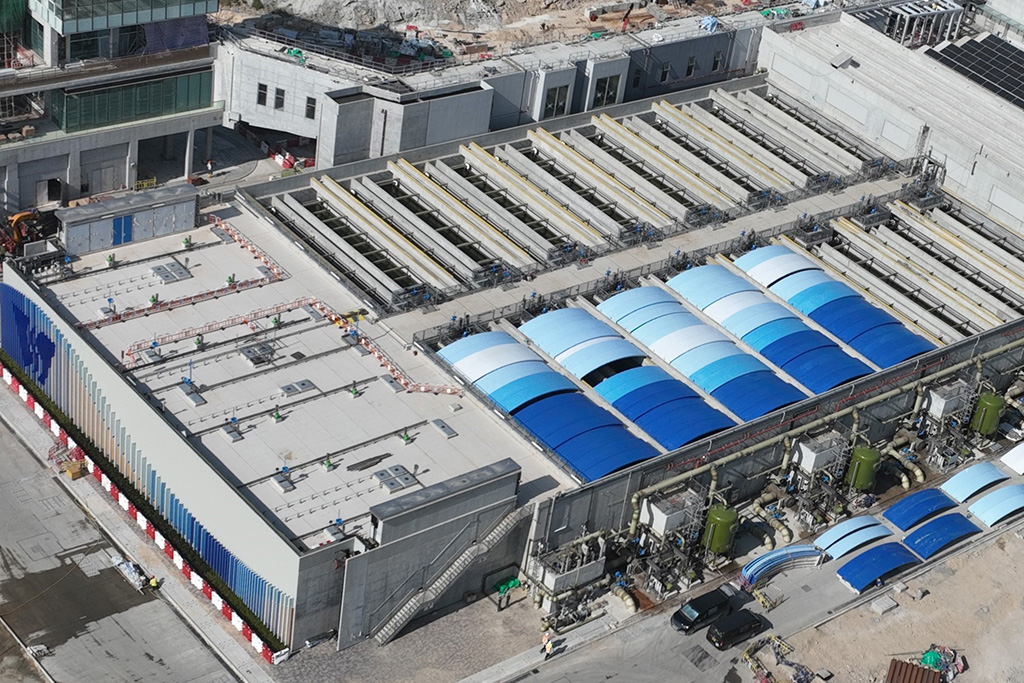

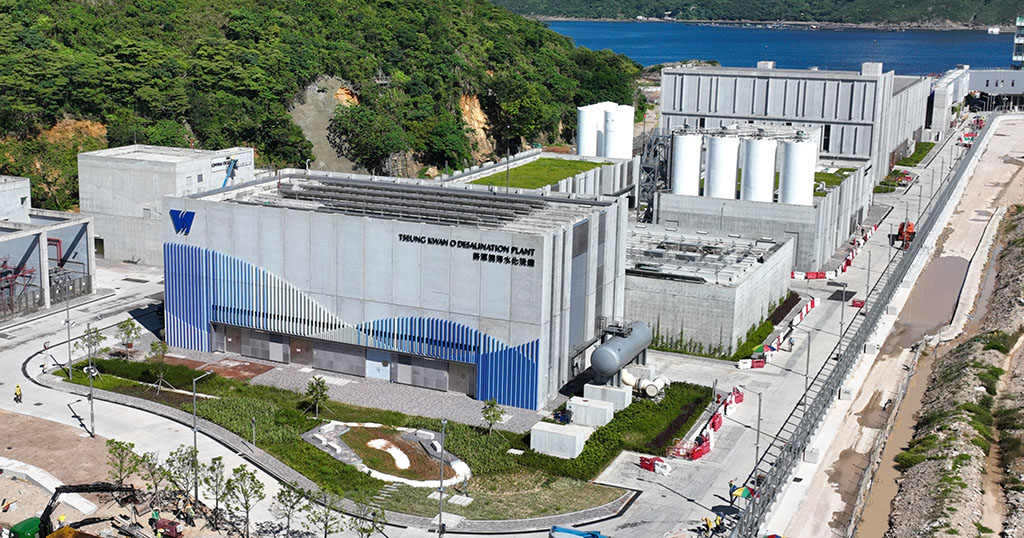

  • Commencement of Operation Stage

2024 Q2
  • Installation of road lighting

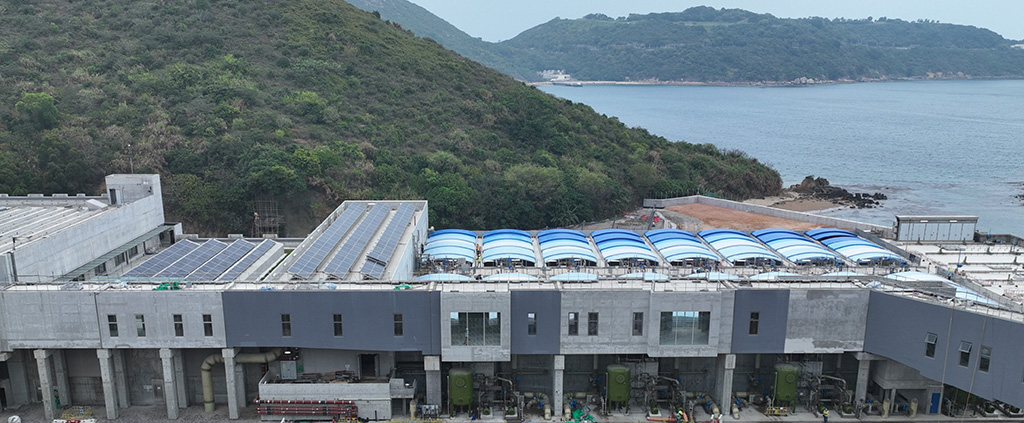

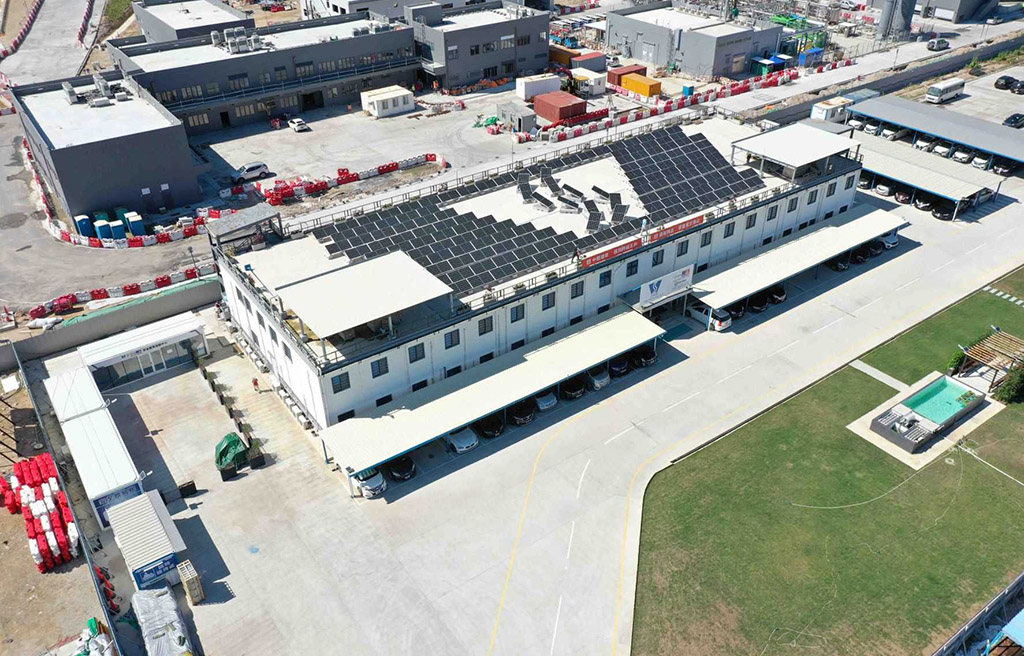

  • Installation of site-wide PV panels
  • Installation of outdoor signage

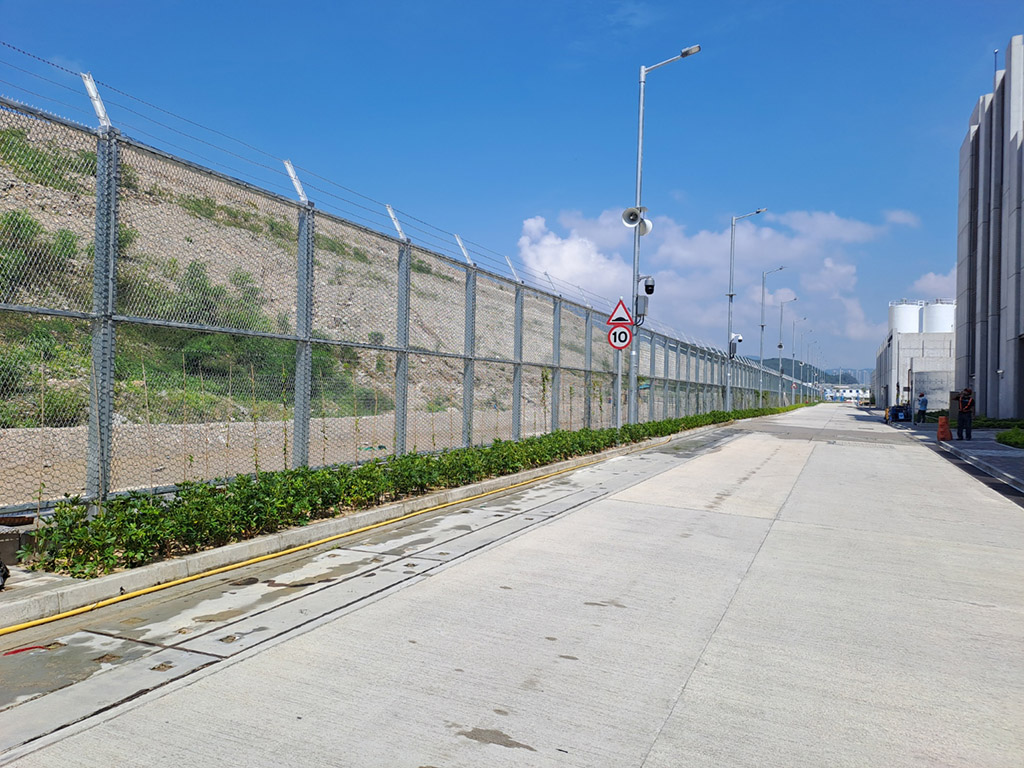

  • Construction of site-wide security fencing

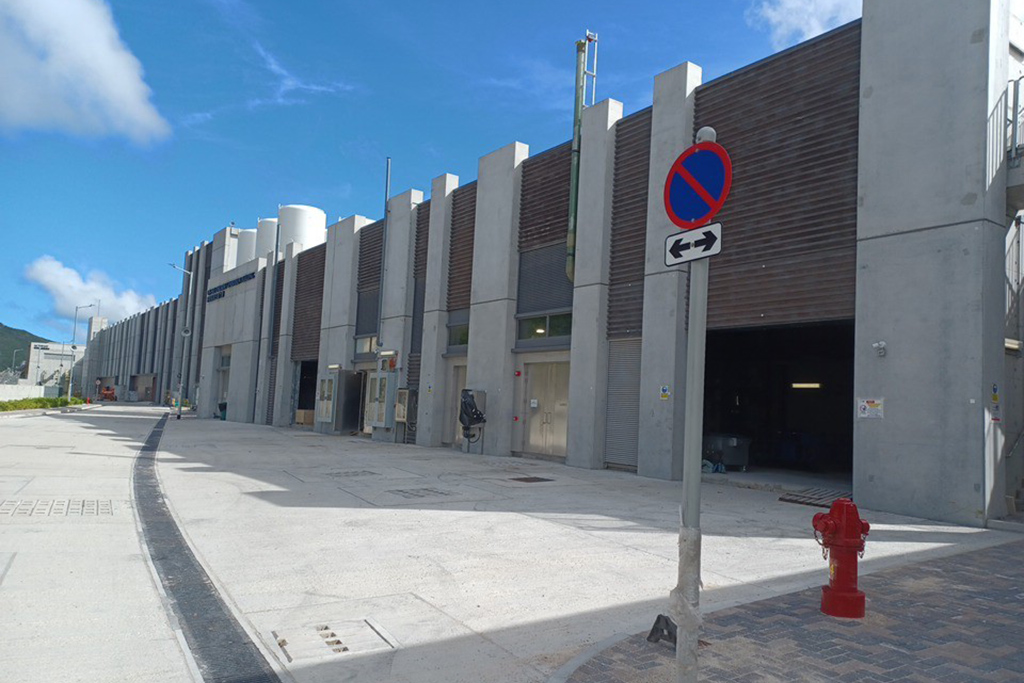

  • Construction of site-wide landscaping works

2024 Q1

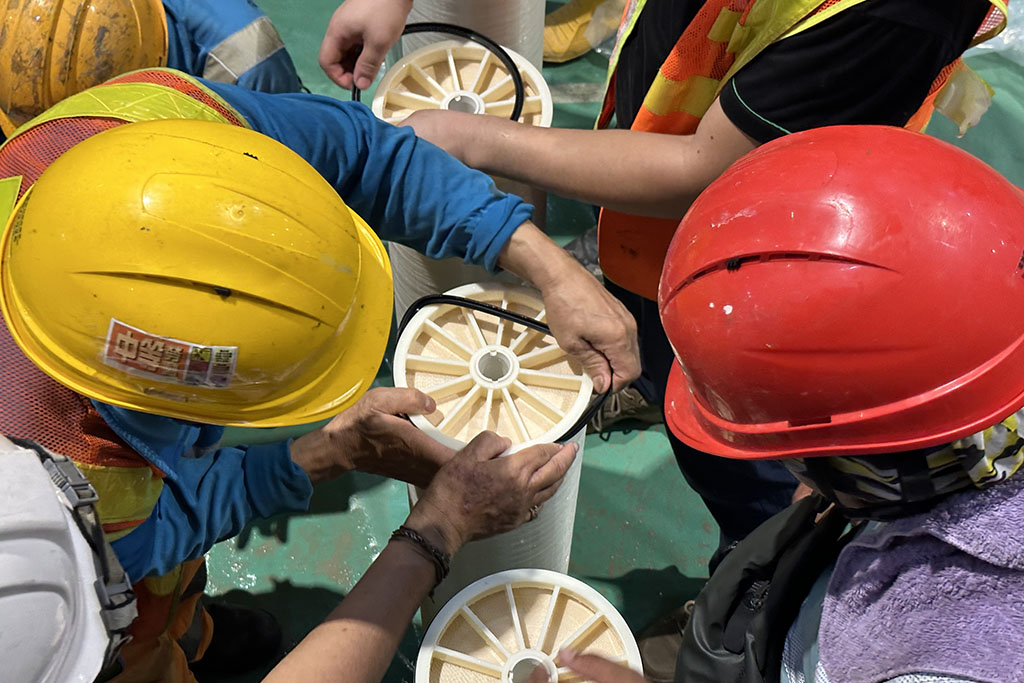

  • Completion of FRP Covers for ActiDAFF Roof
  • Landscaping works
  • Installation of solar panel
  • Construction of Road Pavement

2023 Q4

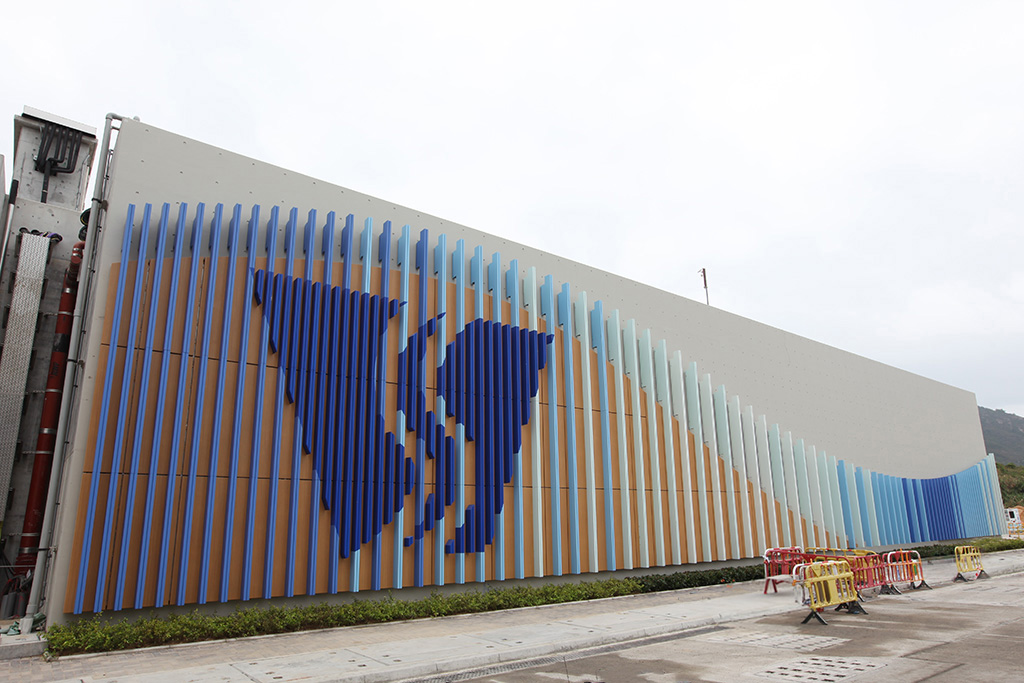

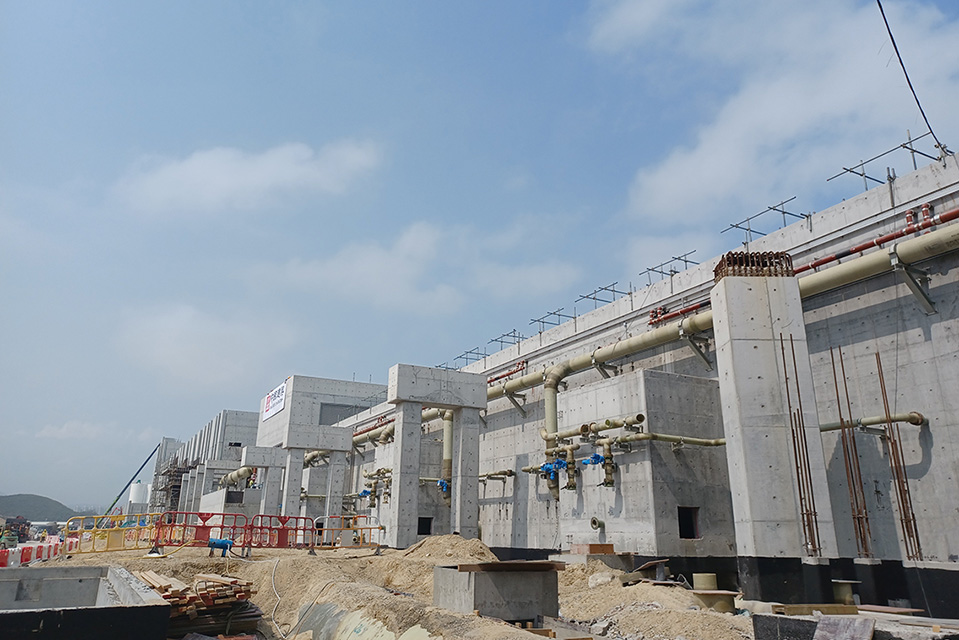

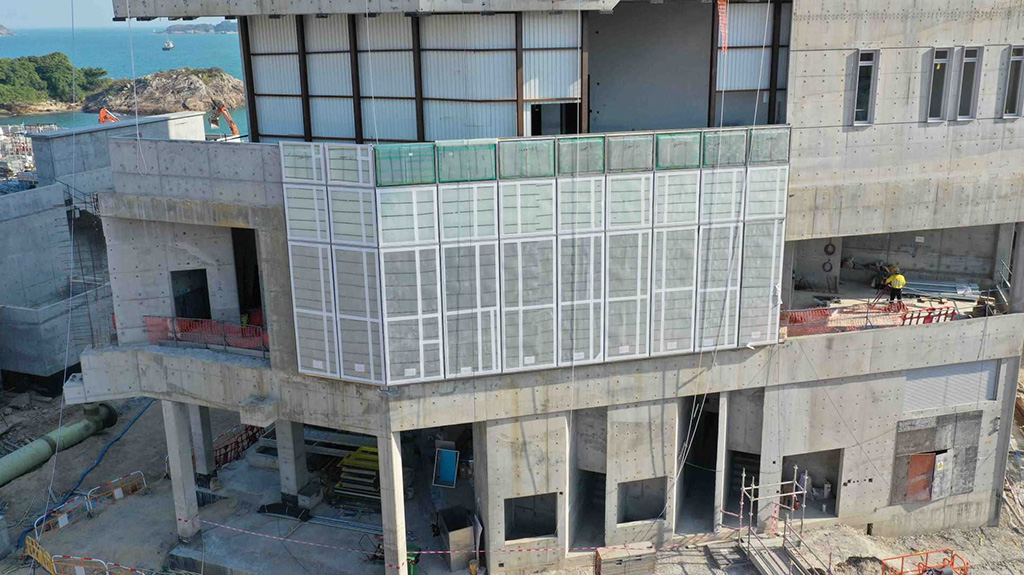

  • Completion of ActiDAFF Architectural Wall and Finishes

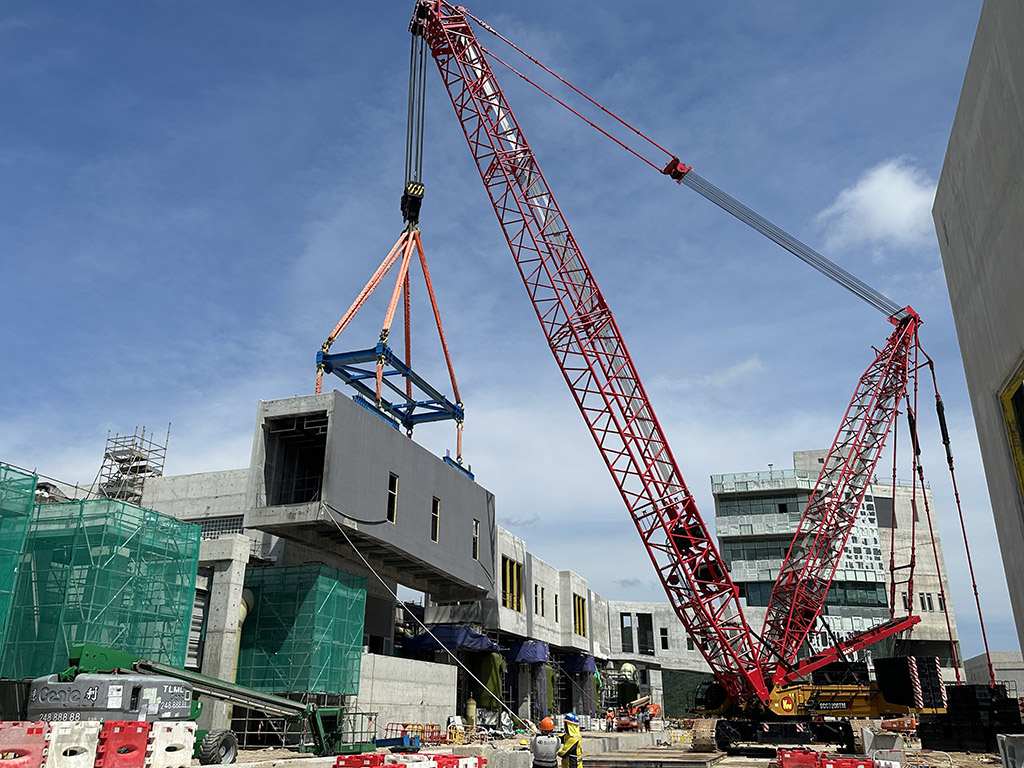

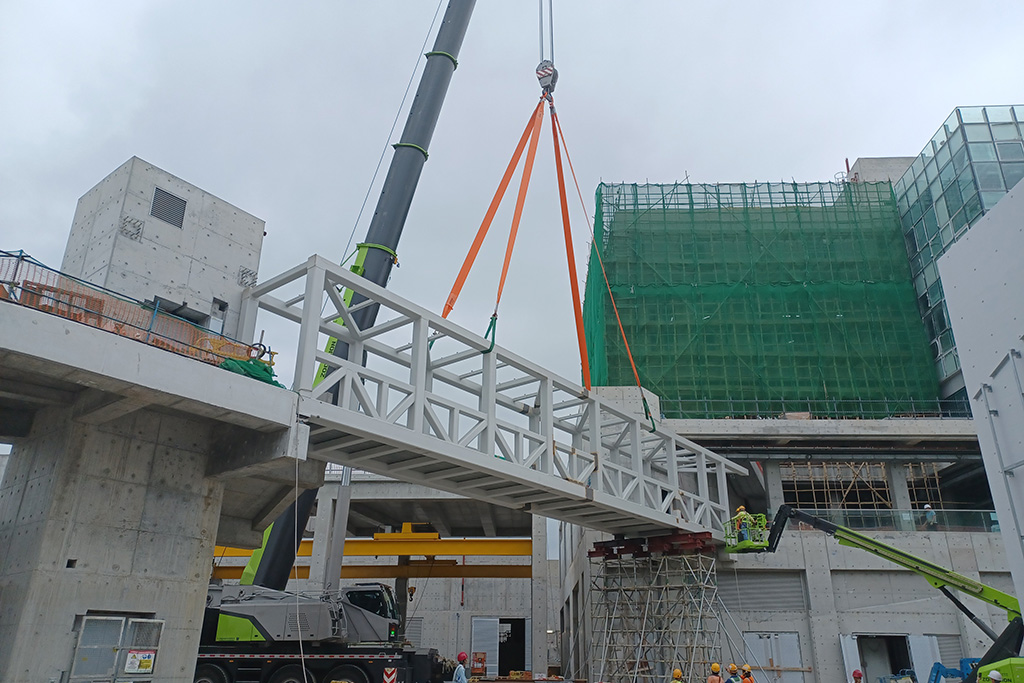

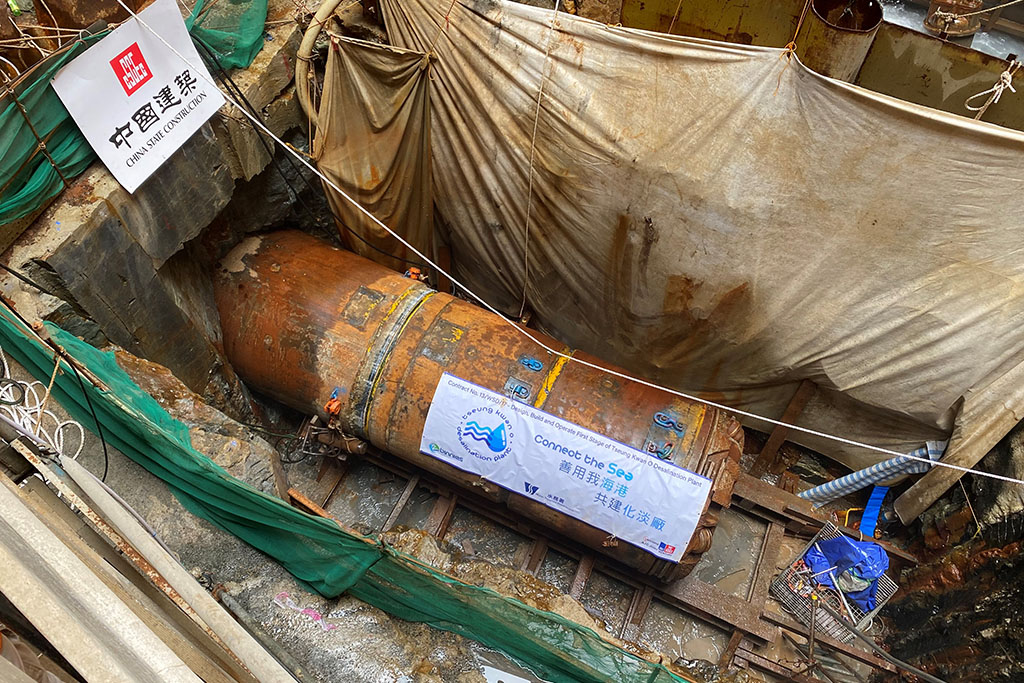

  • Delivery and Installation of Steel Bridge
  • Commissioning for water supply

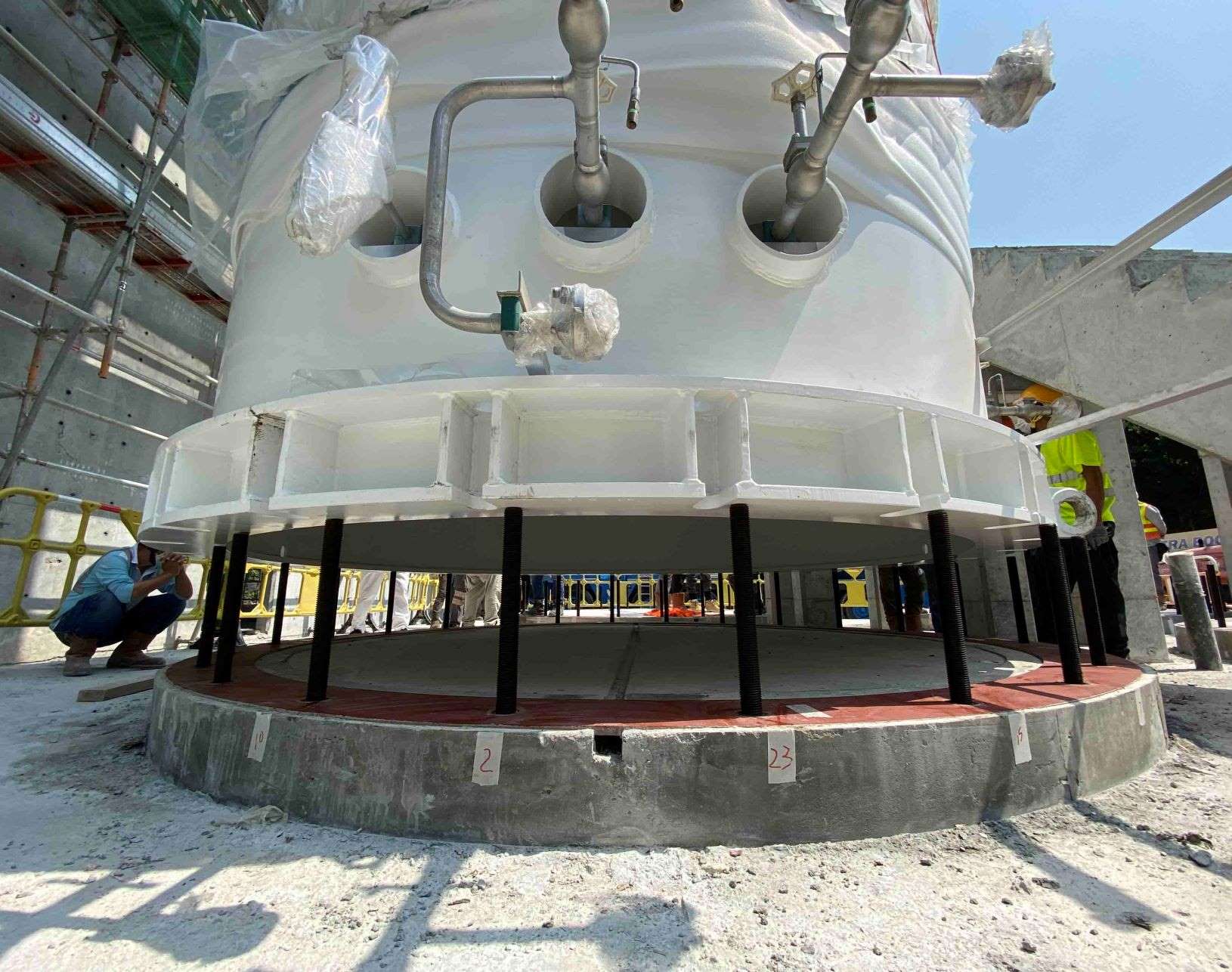

  • Installation of FRP Covers for ActiDAFF Roof
  • Commencement of Landscaping works

2023 Q3
  • Completion of Surge Vessel Installation
  • Completion of Flexible Barrier installation

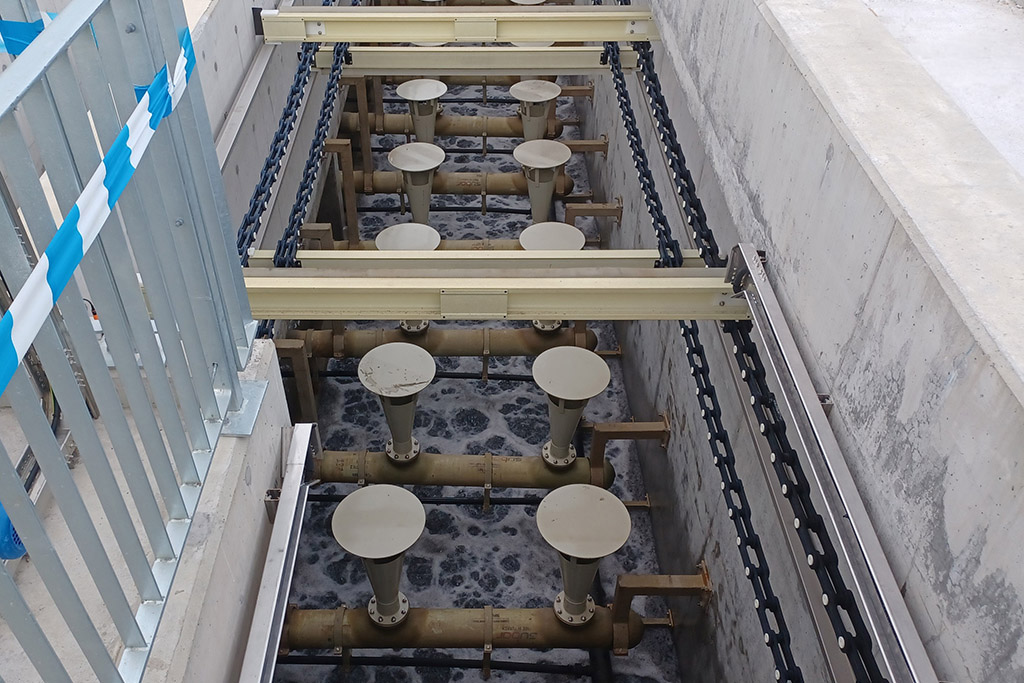

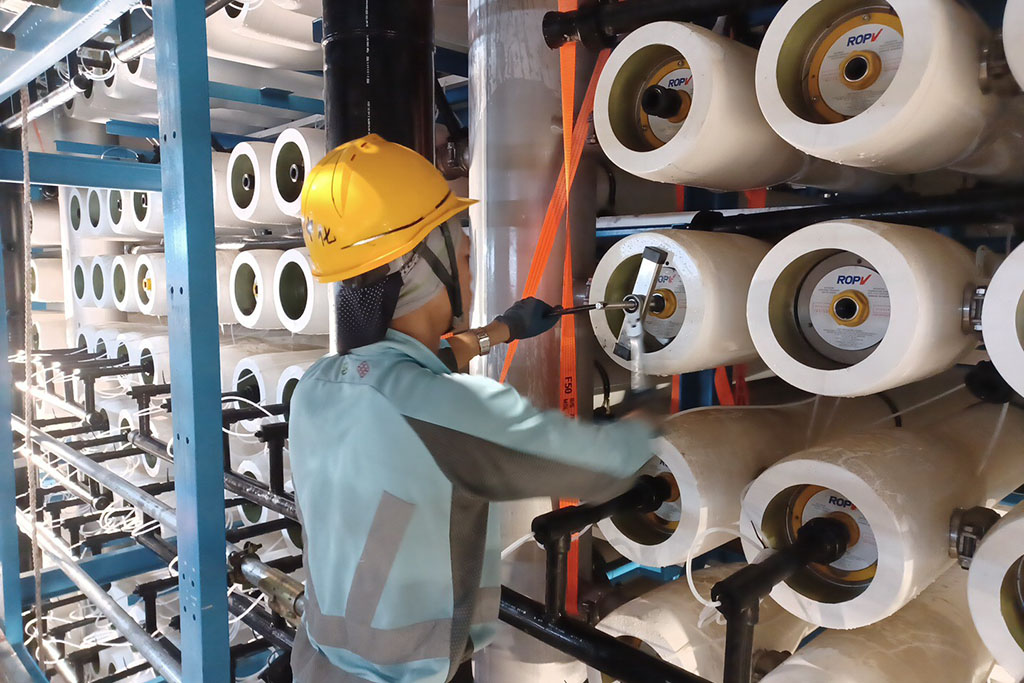

  • Commencement of Reverse Osmosis Membrane Loading Installation
  • Testing and Commissioning Works

2023 Q2
  • Completion of MiC Inspection Corridor Segment Lifting

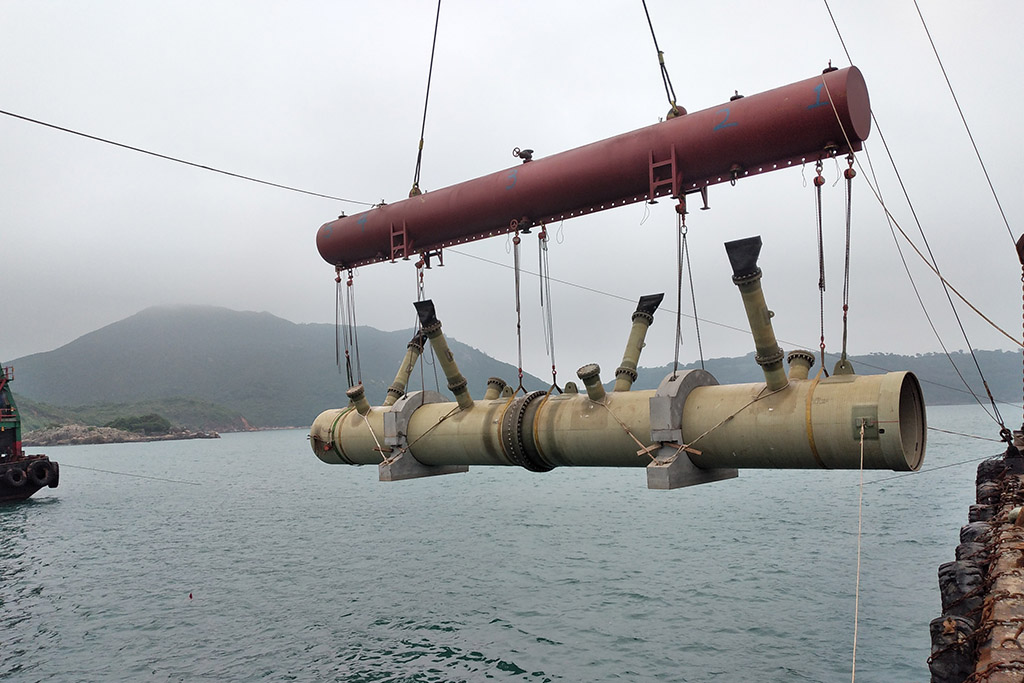

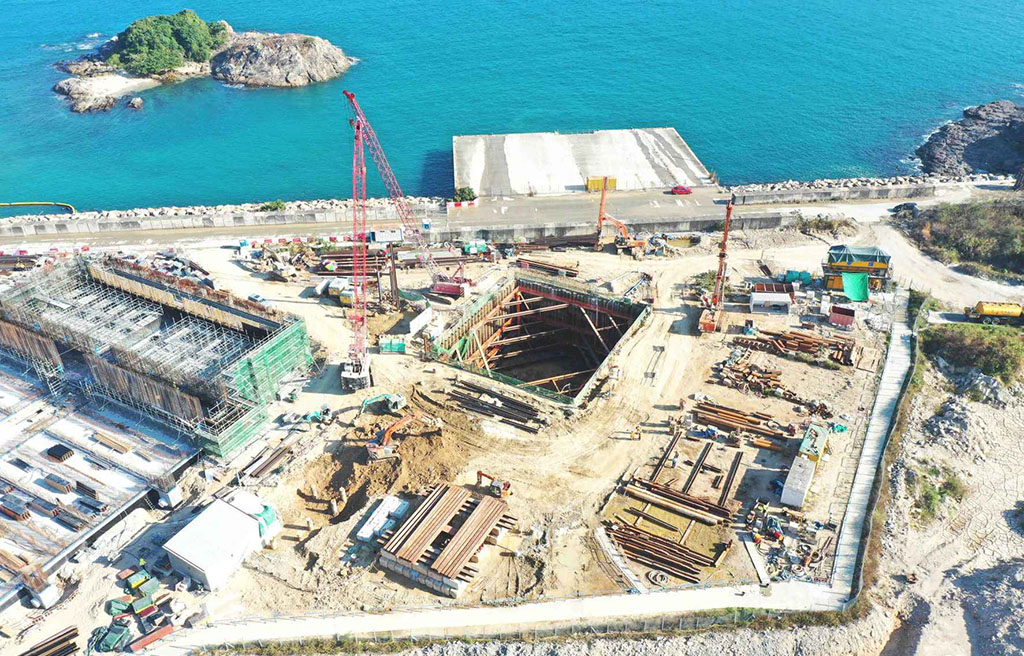

  • Completion of diffuser pipe installation at Outfall
  • Commencement of Testing and Commissioning Works
  • Wood Waste Upcycling to produce rest bench to public

2023 Q1

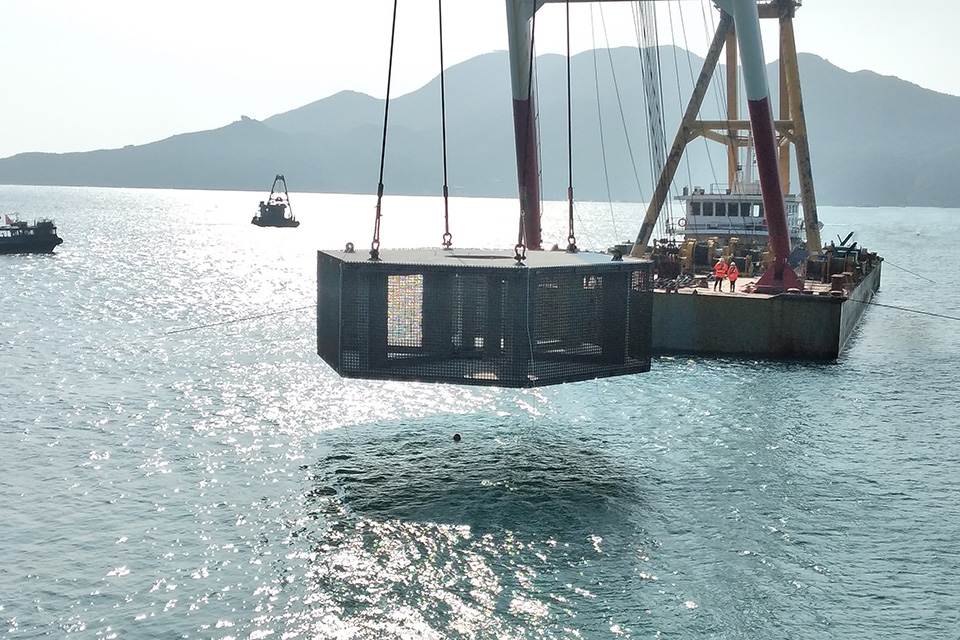

  • Completion of velocity cap installation at Intake Shaft
  • Commencement of MiC Inspection Corridor Prefabrication

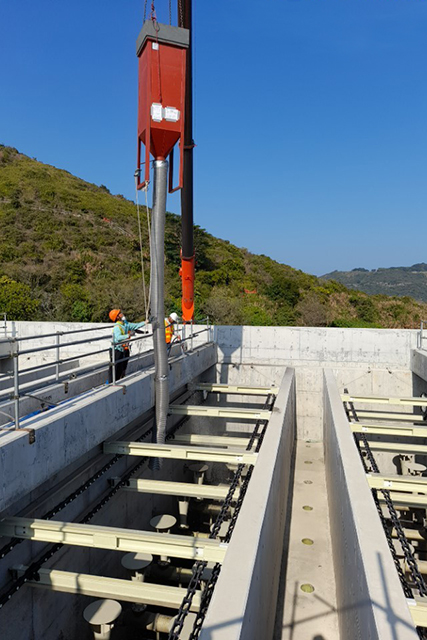

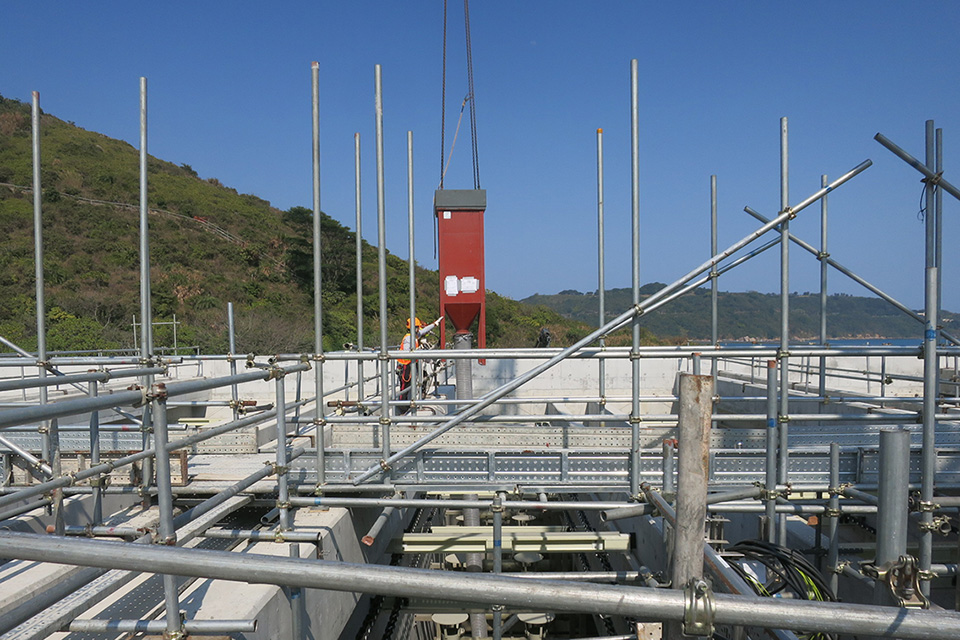

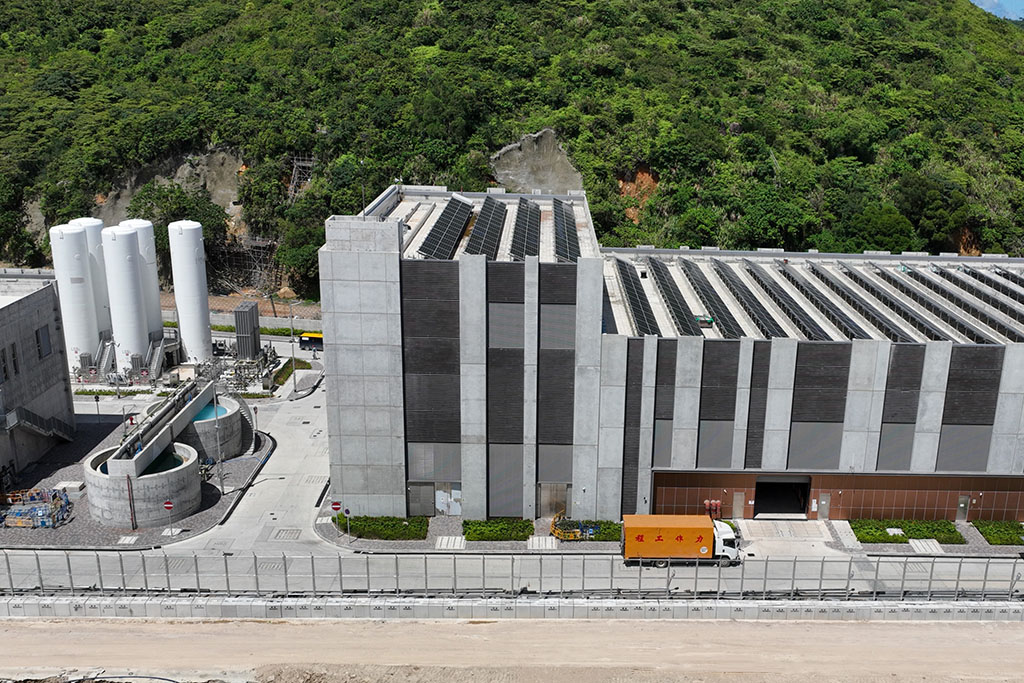

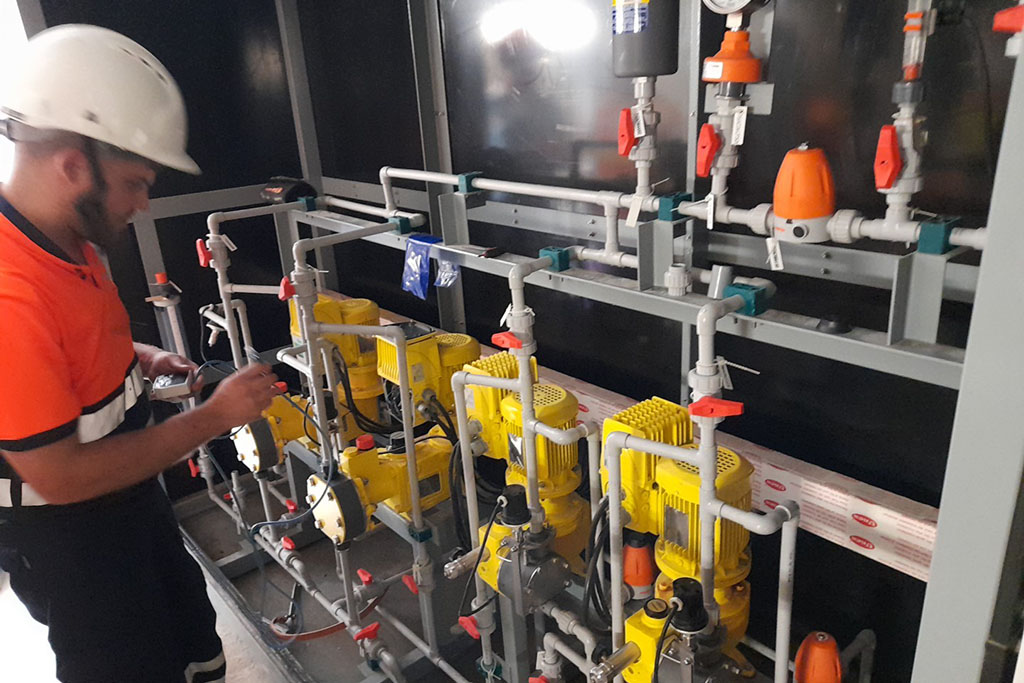

  • Commencement of ActiDAFF media charging

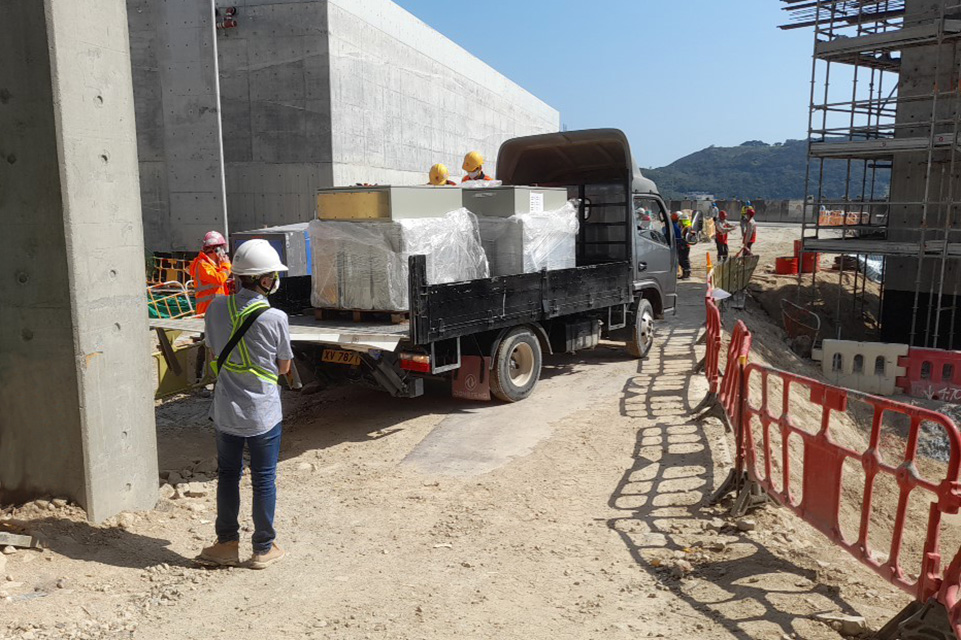

  • Delivery and Installation of LV switchboard for Administration Building

2022 Q4

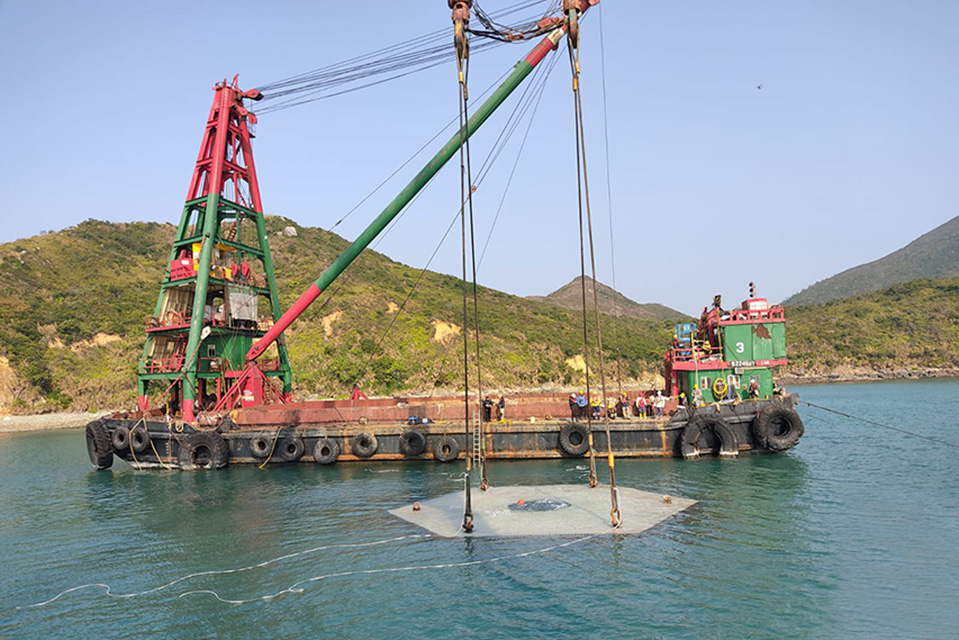

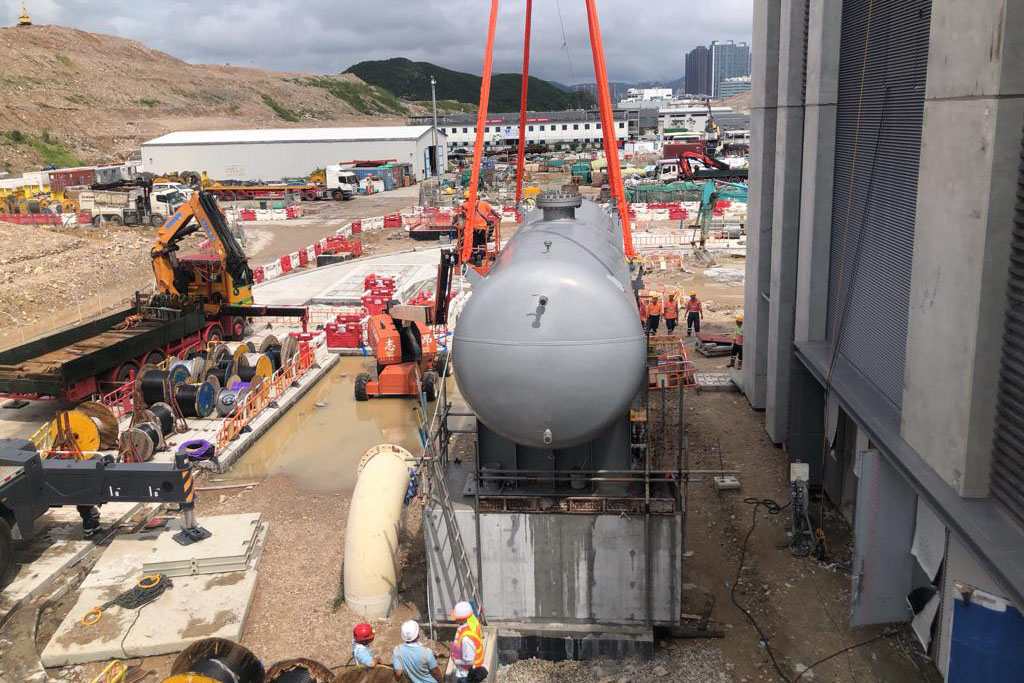

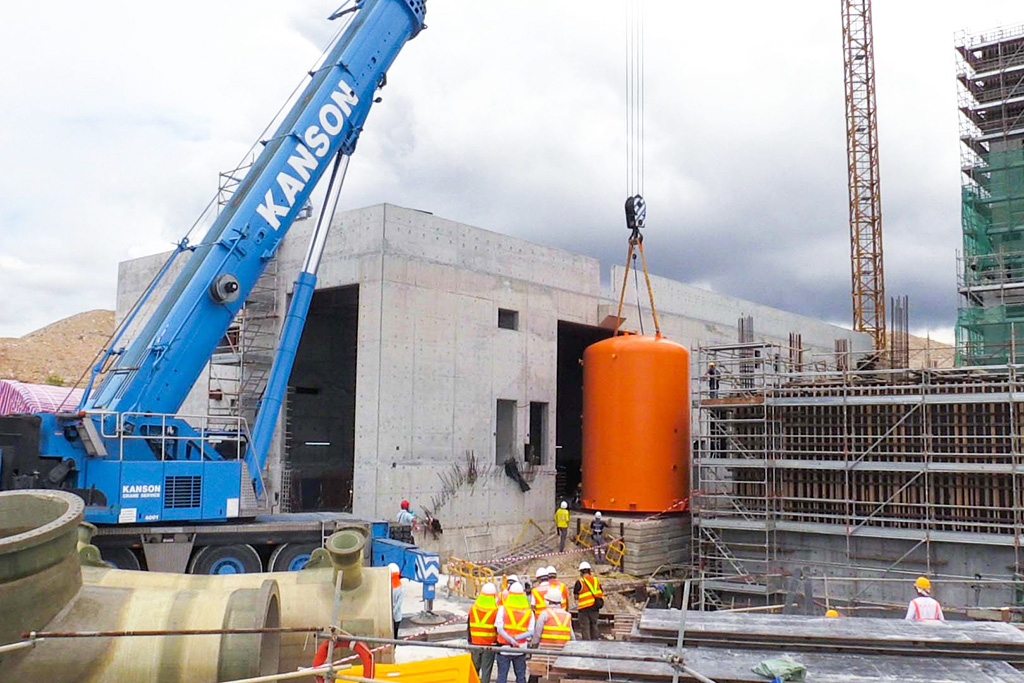

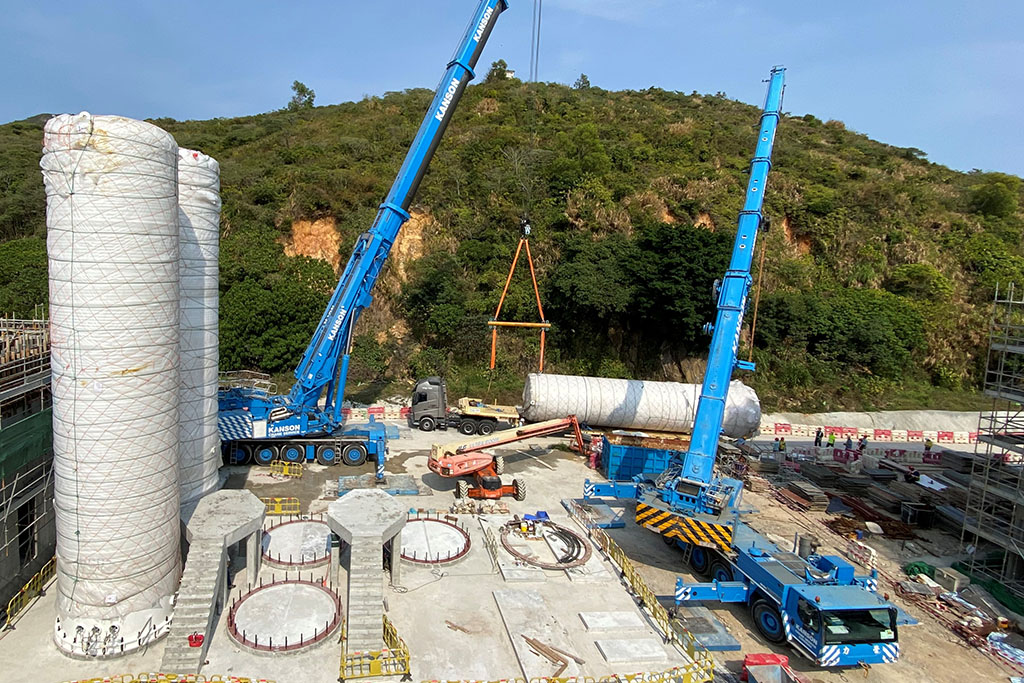

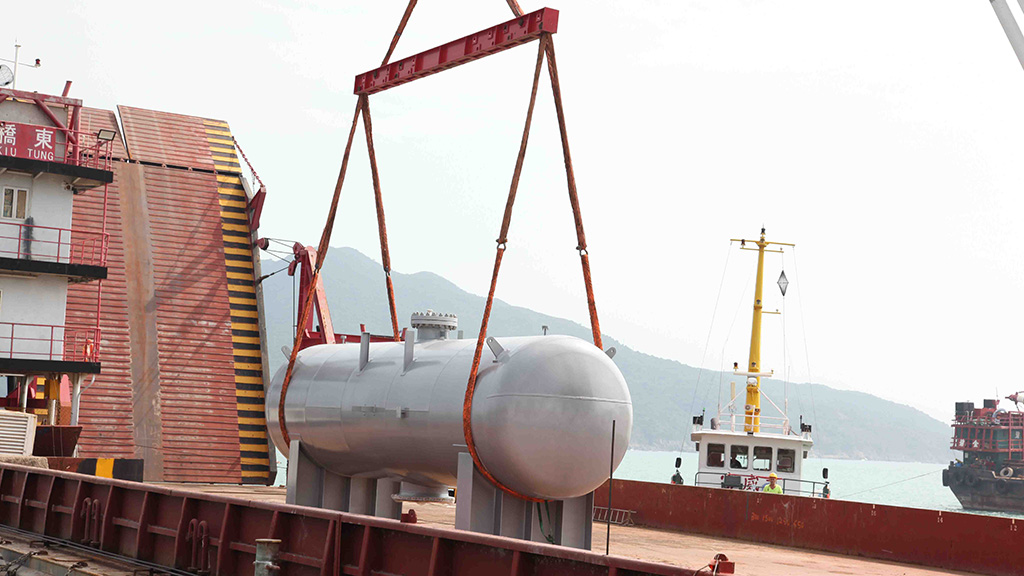

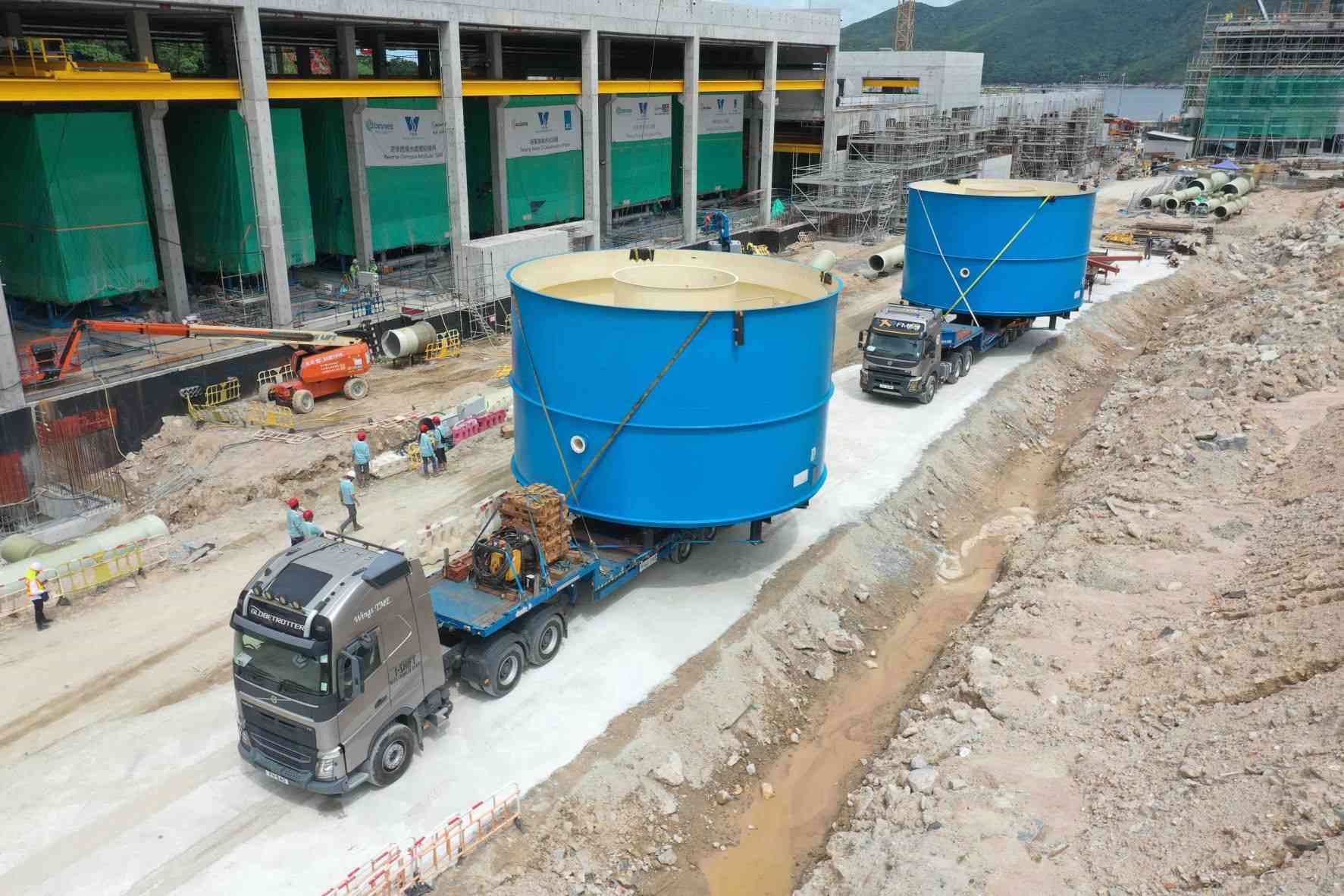

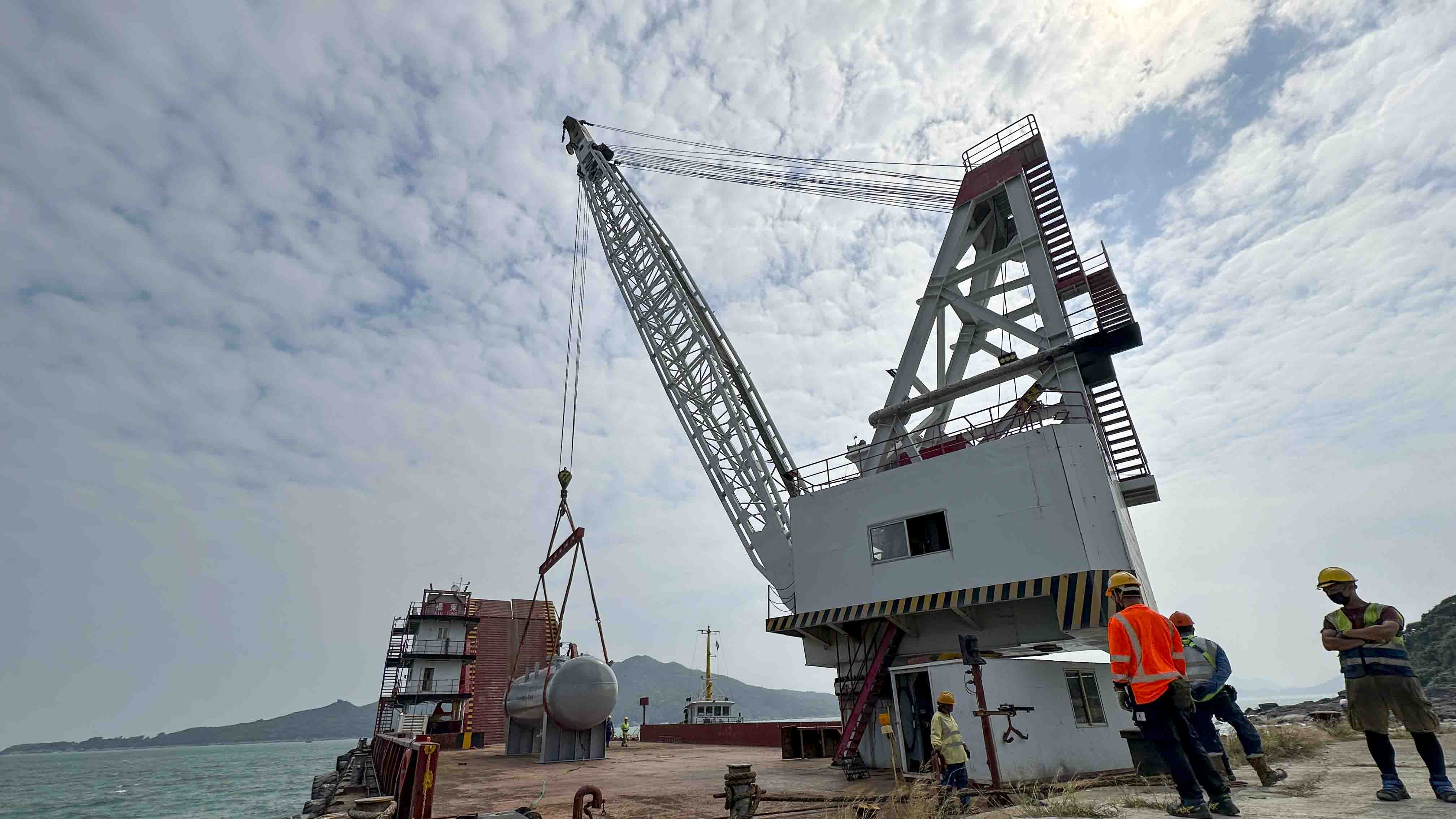

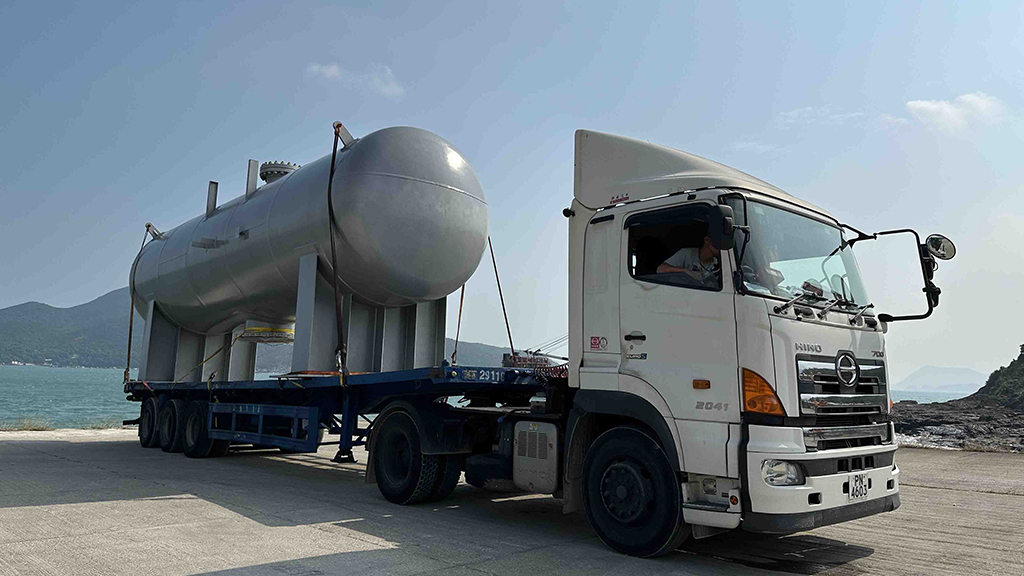

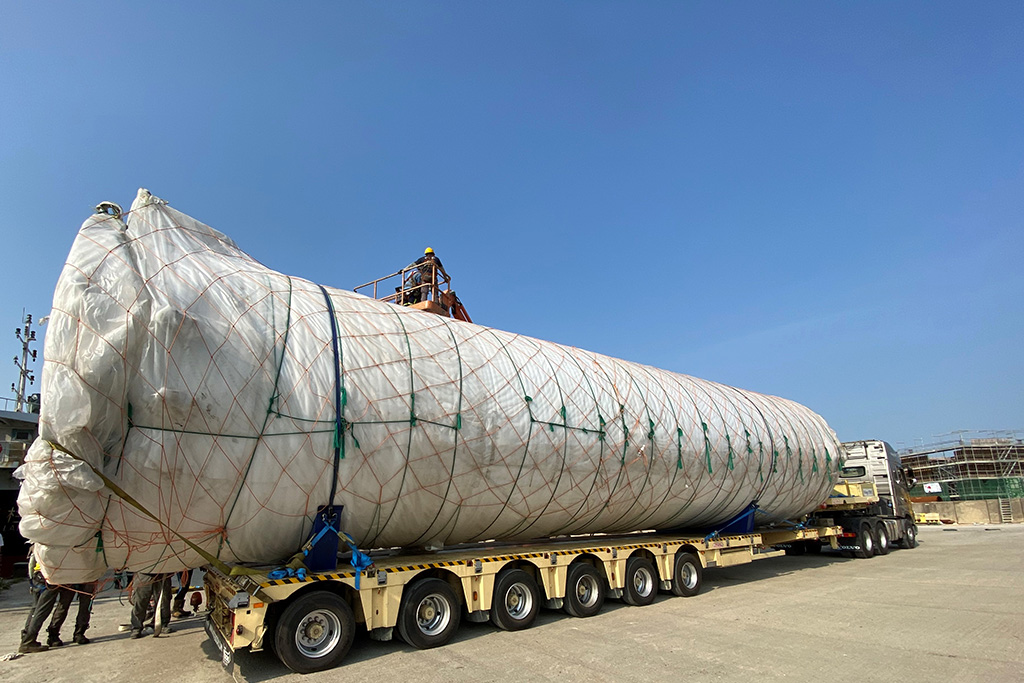

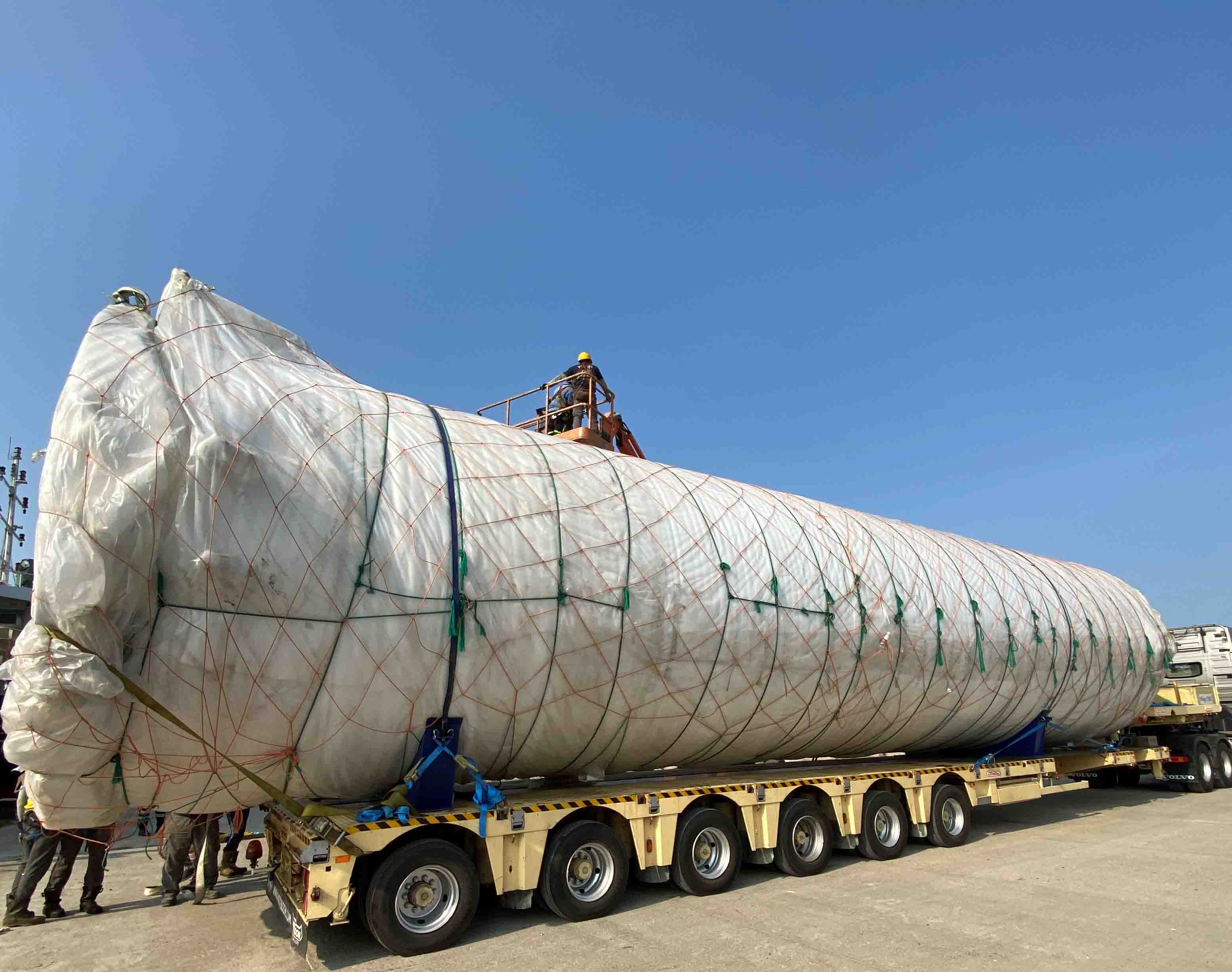

  • Delivery of Surge Vessel and Installation

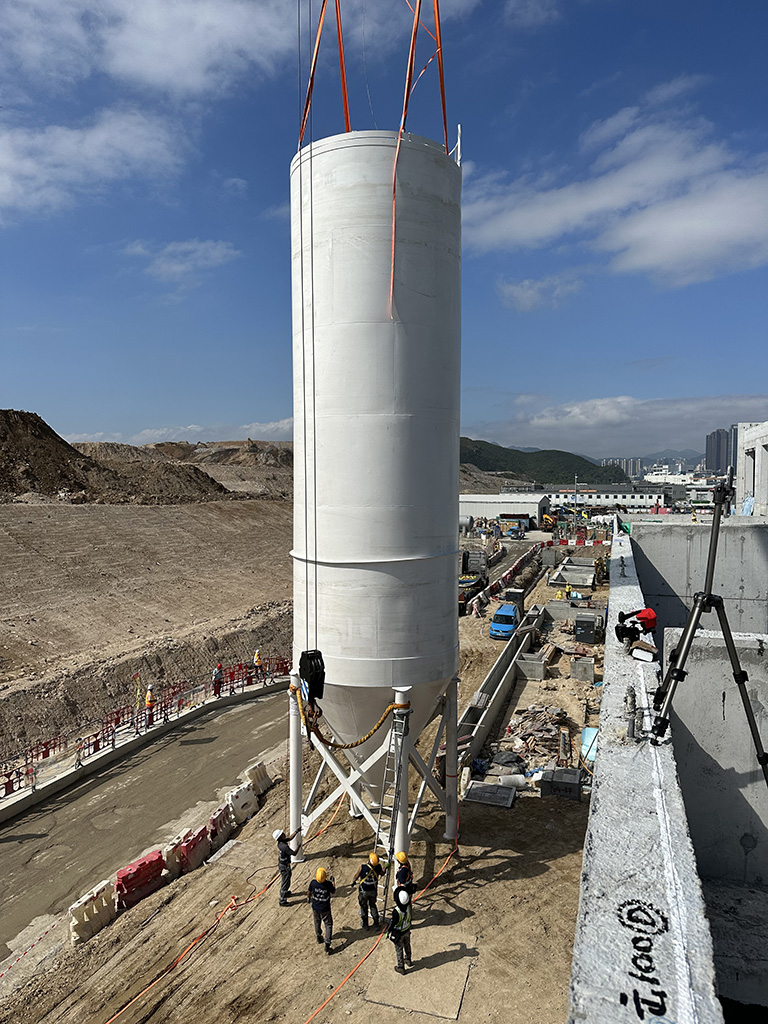

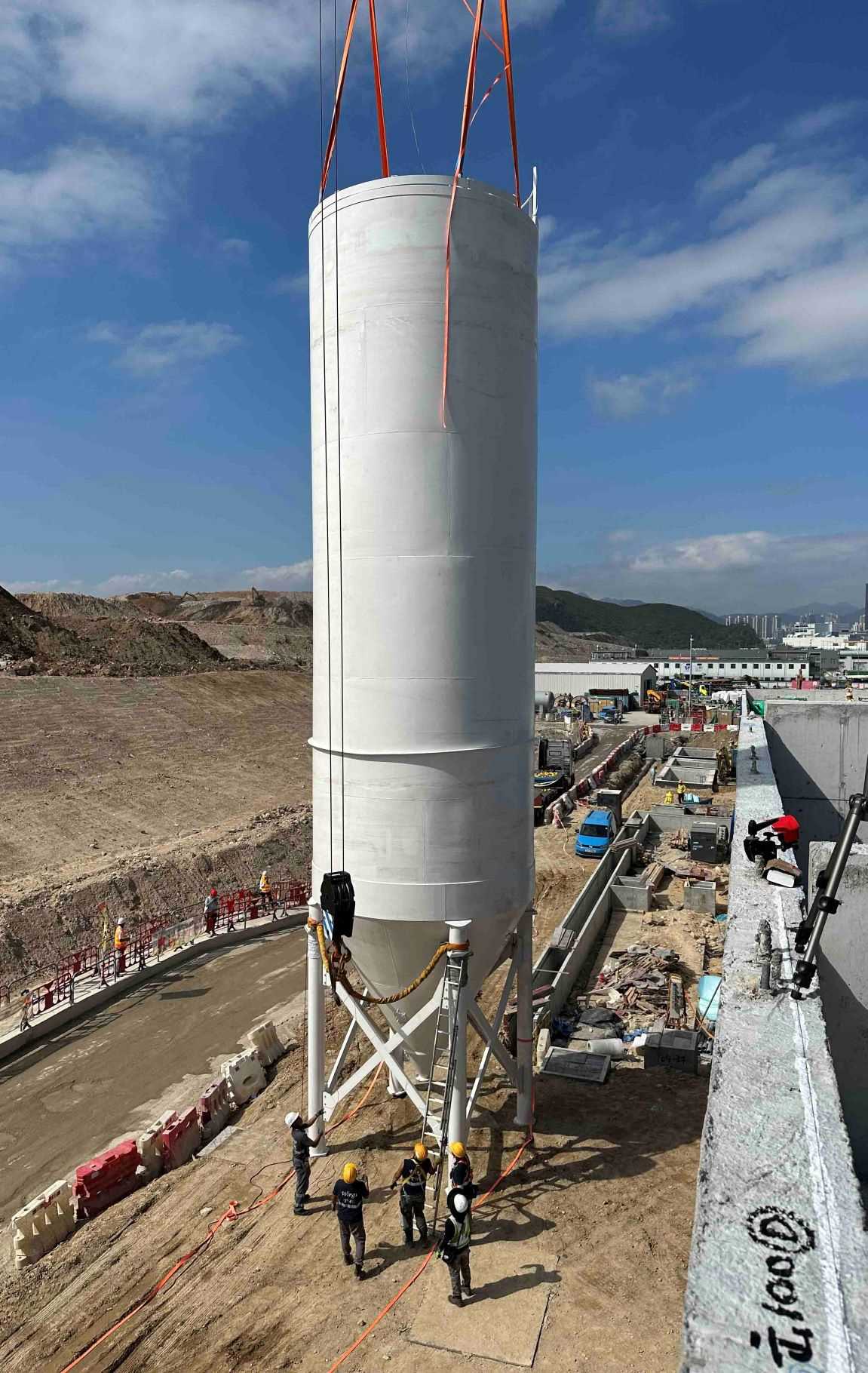

  • Delivery of Lime Silo and Installation

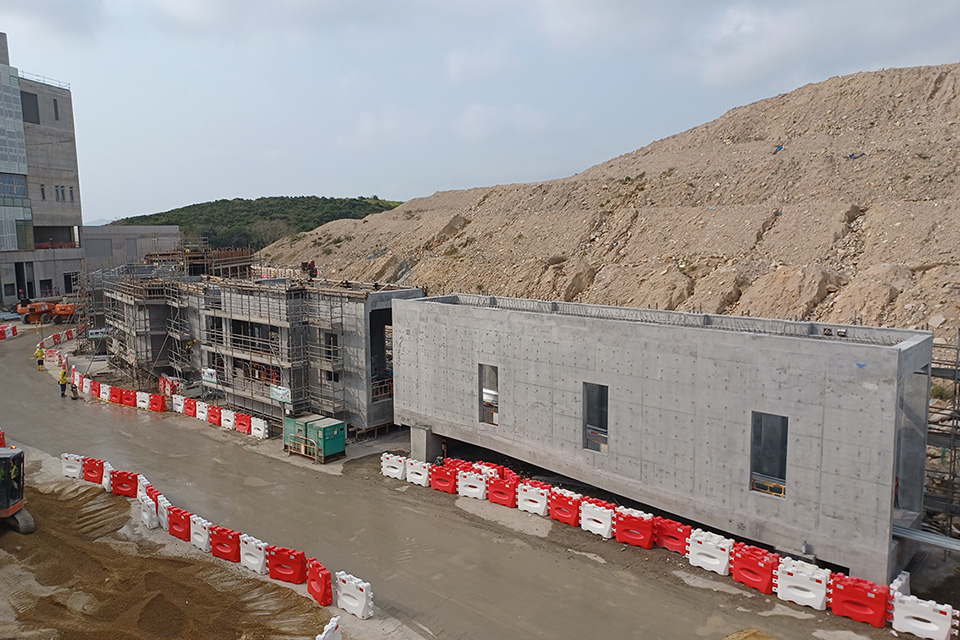

  • Commencement of Curtain Wall Installation
  • Delivery of Velocity Cap and Installation

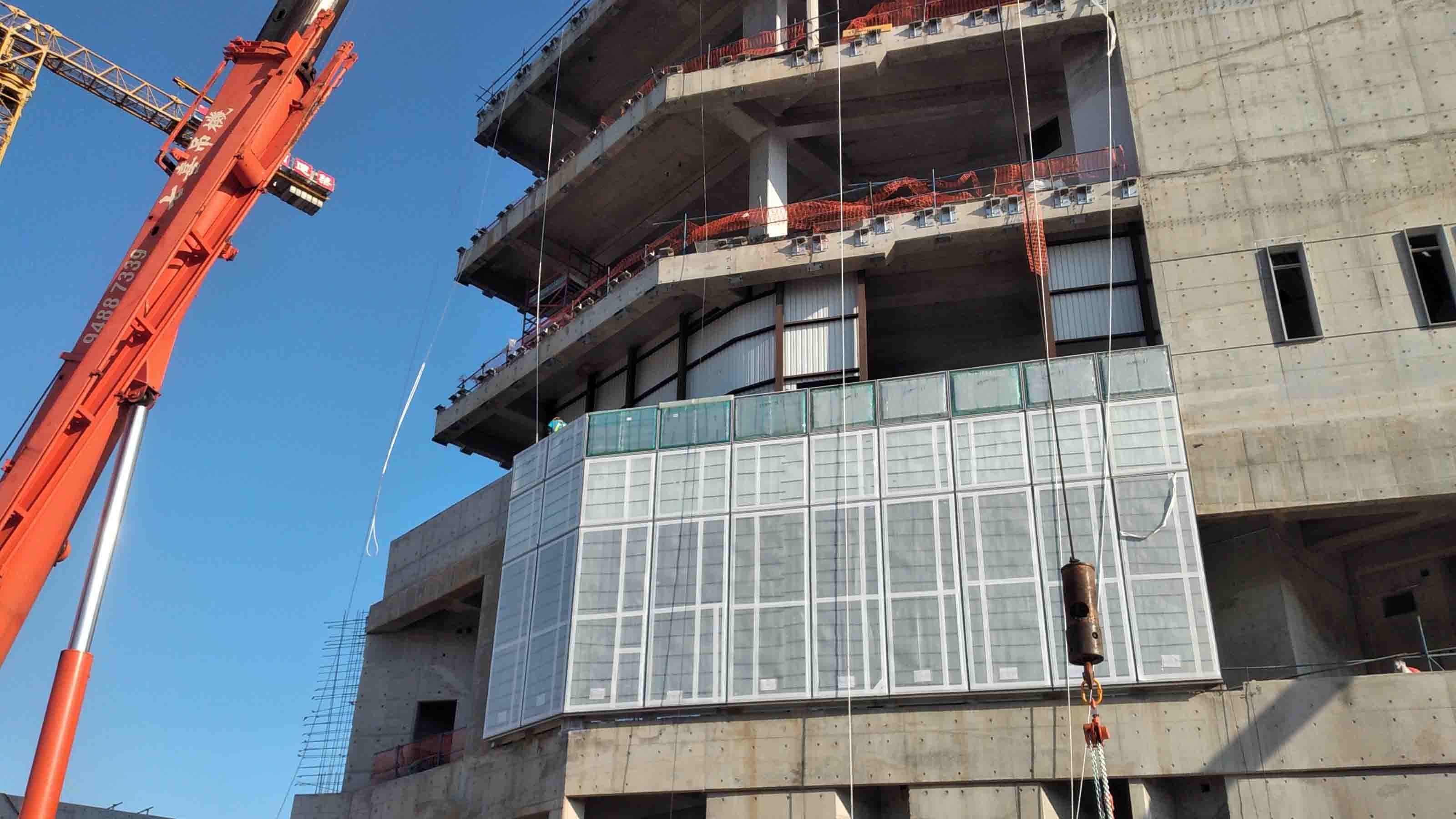

  • Topping Out Ceremony
  • Completed installation of DfMA channel


2022 Q3


  • Life First 2022 Award
  • 28th CCSAS Construction Safety Week
  • Installation of Elbow and Riser Marine structures at Intake and outfall Shaft respectively
  • Delivery of DfMA Lime Saturators from Jiangsu, China and Installation

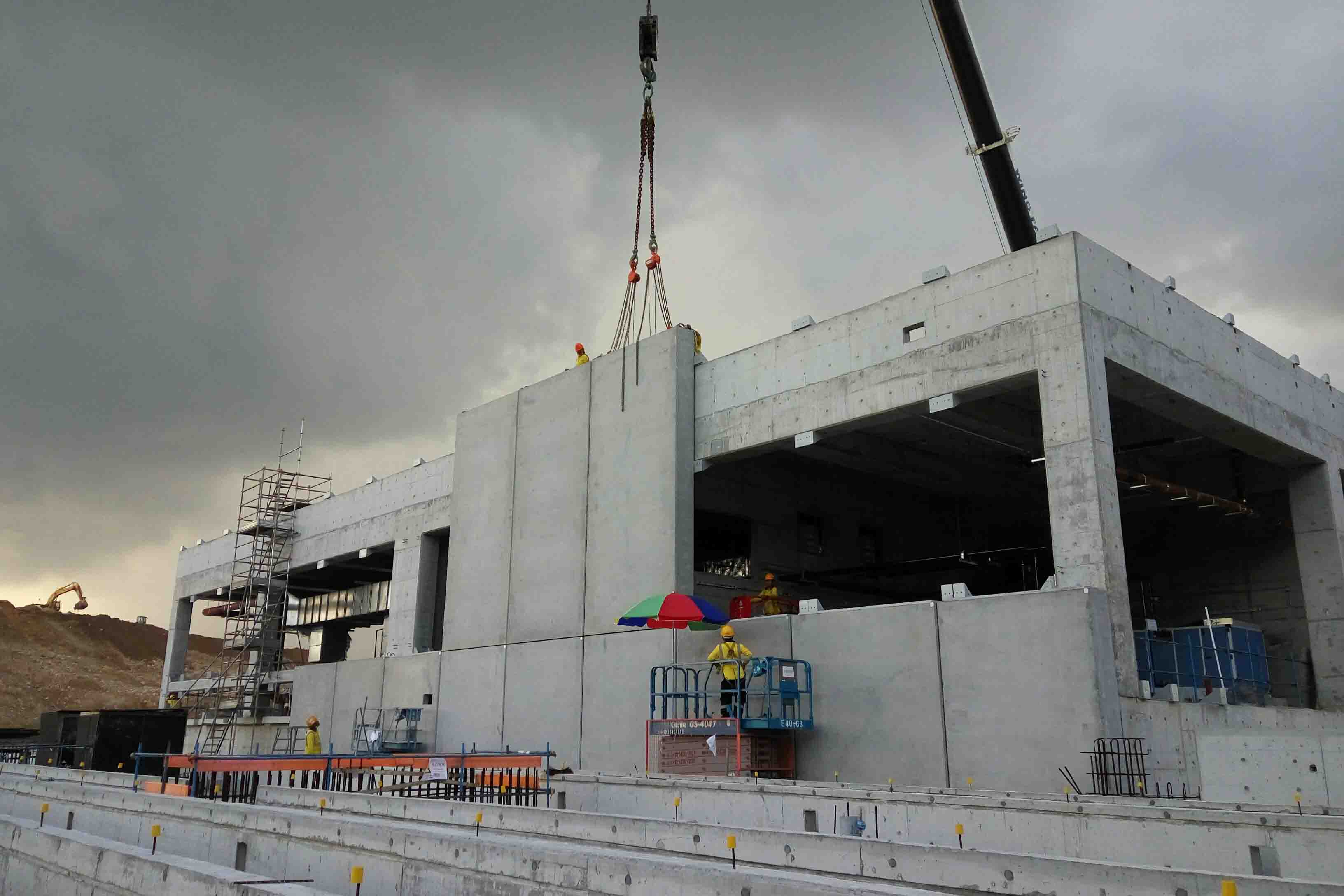

  • Commencement of DfMA Precast Wall Panel Installation



2022 Q2
  • Commencement of DfMA Open Channel Installation

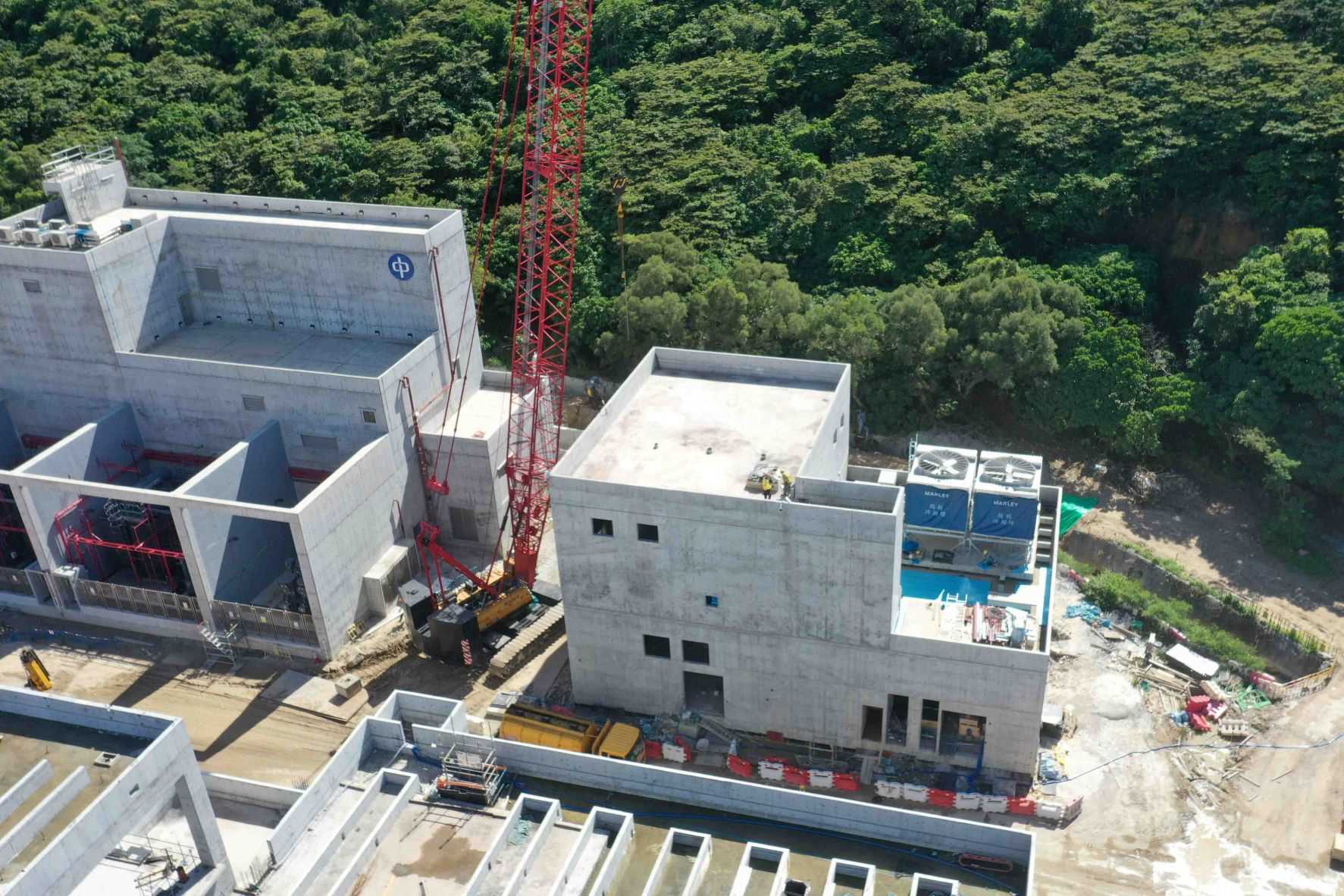

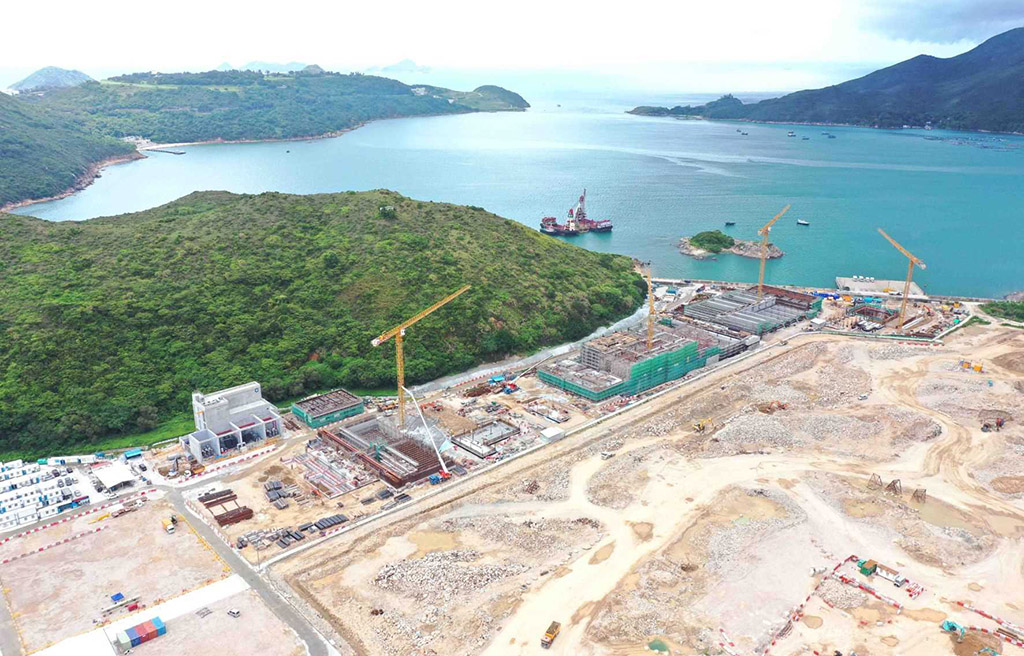

  • Completion of the Structure of MECCP Building for E&M Installation

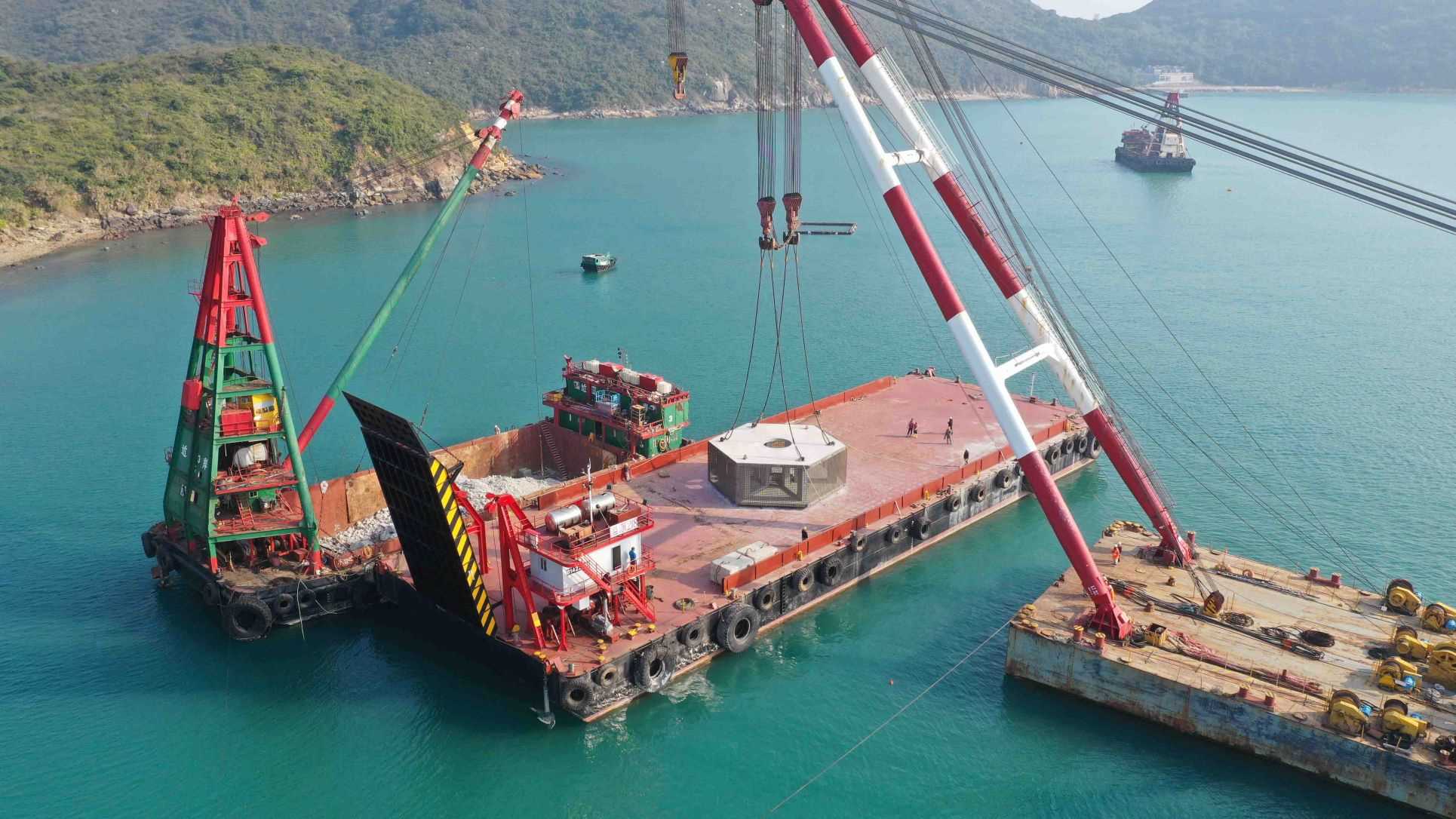

  • Retrieval of TBM from a Temporary Intake Shaft by Crane Barge
  • The 3rd Cascade Workshop for the Champion and the Pioneer Groups
  • CIC Life First Event 2022

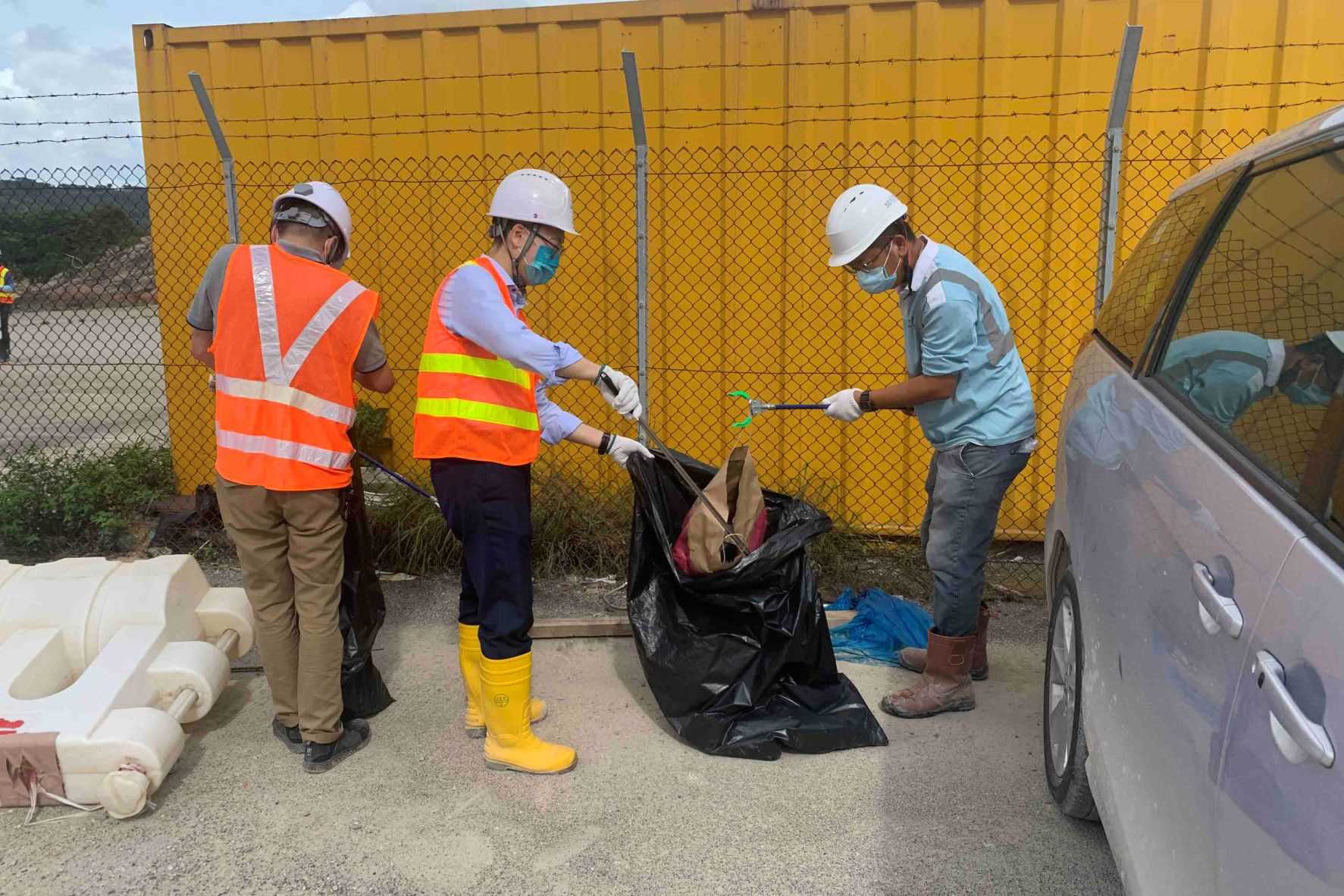

  • Site Cleanup Day
2022 Q1
  • Delivery and assembly of CO2 tanks from Jiangsu, China

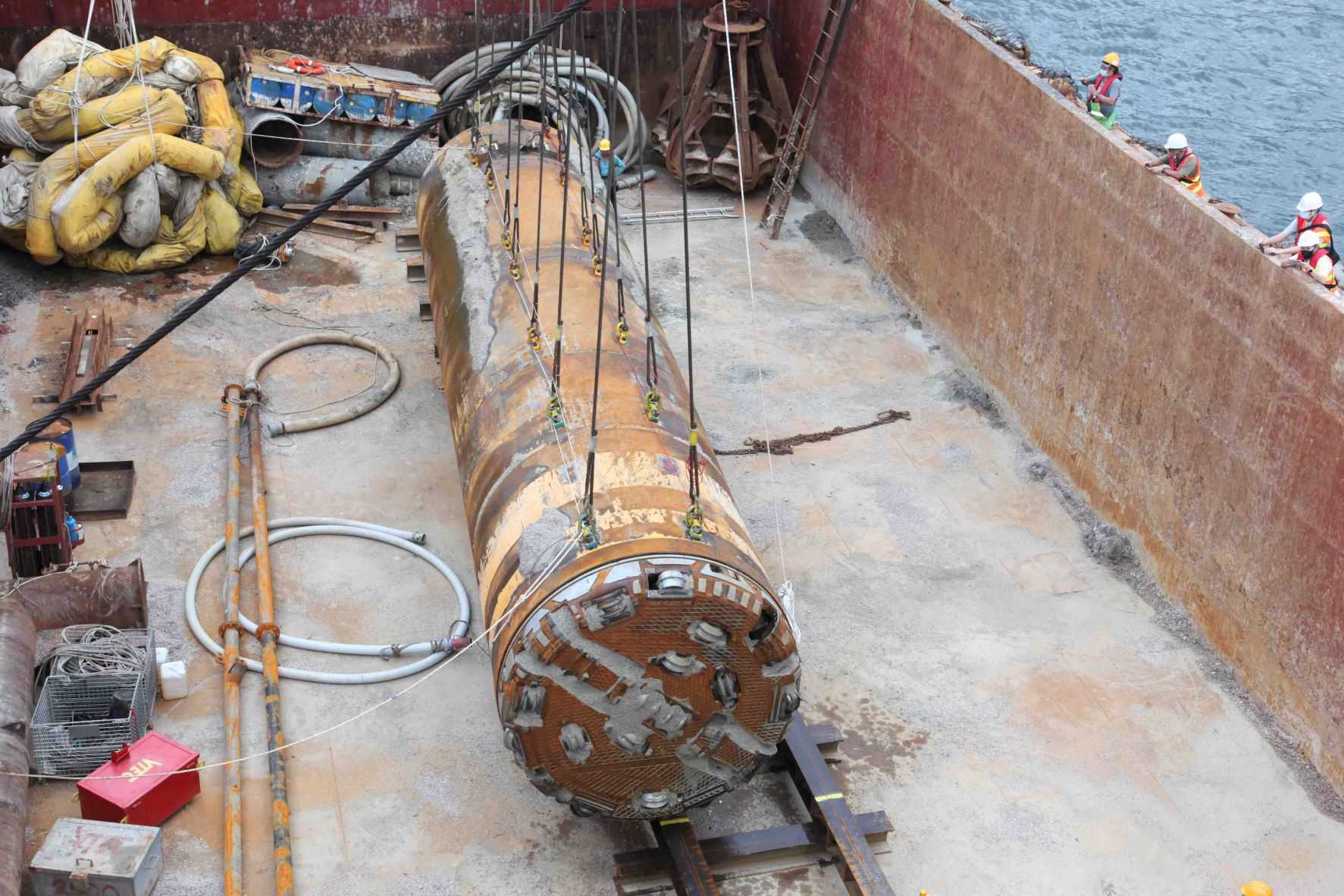

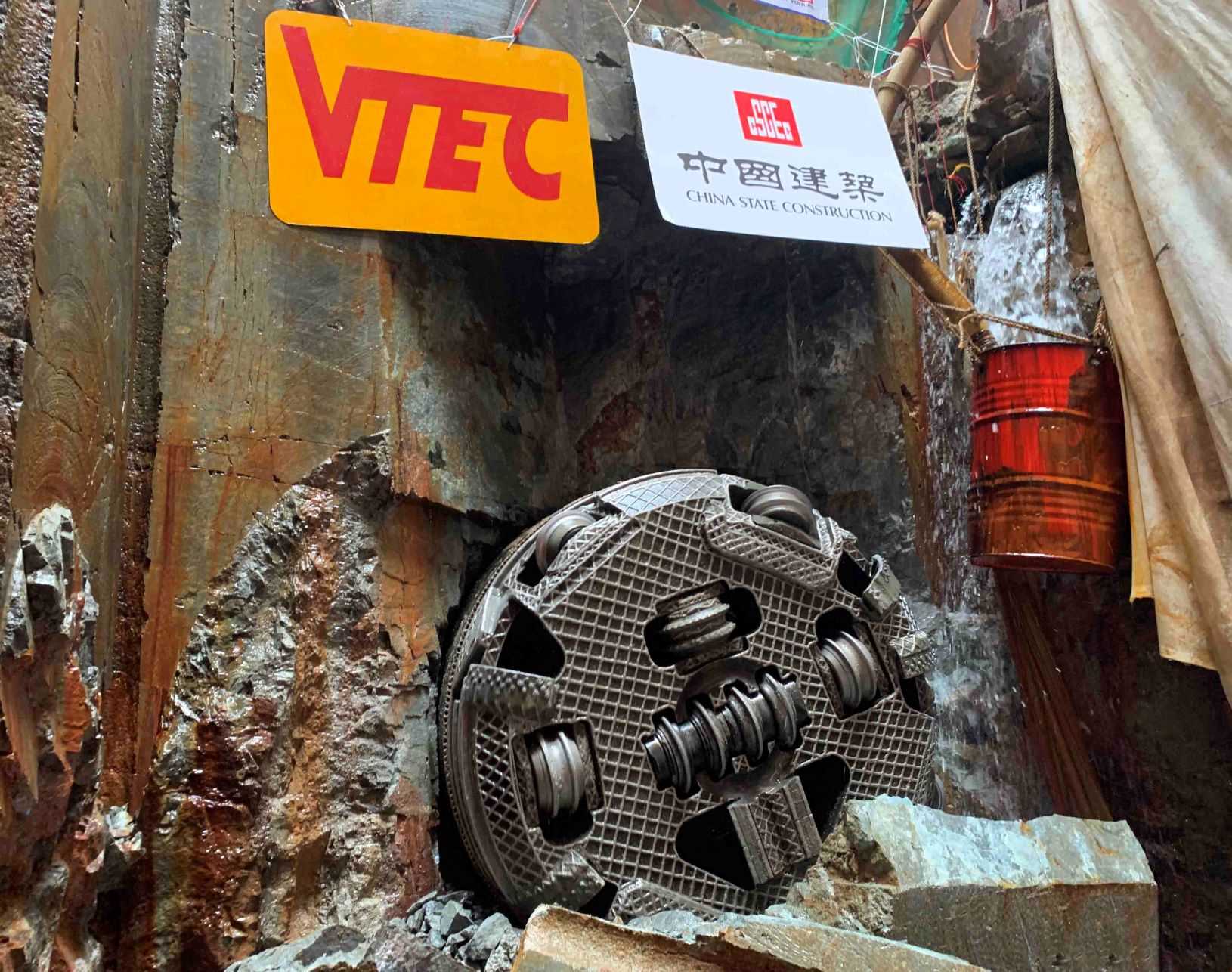

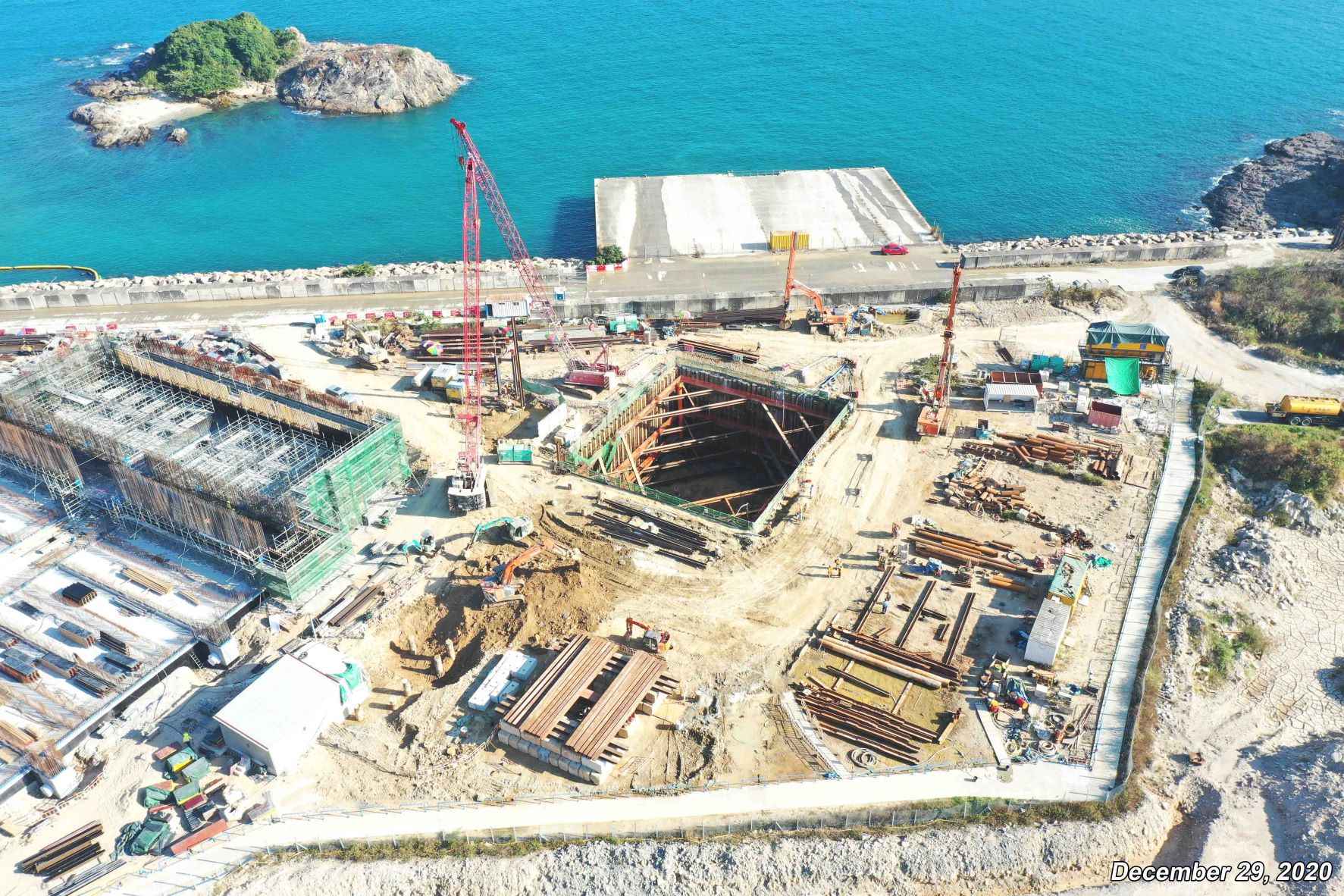

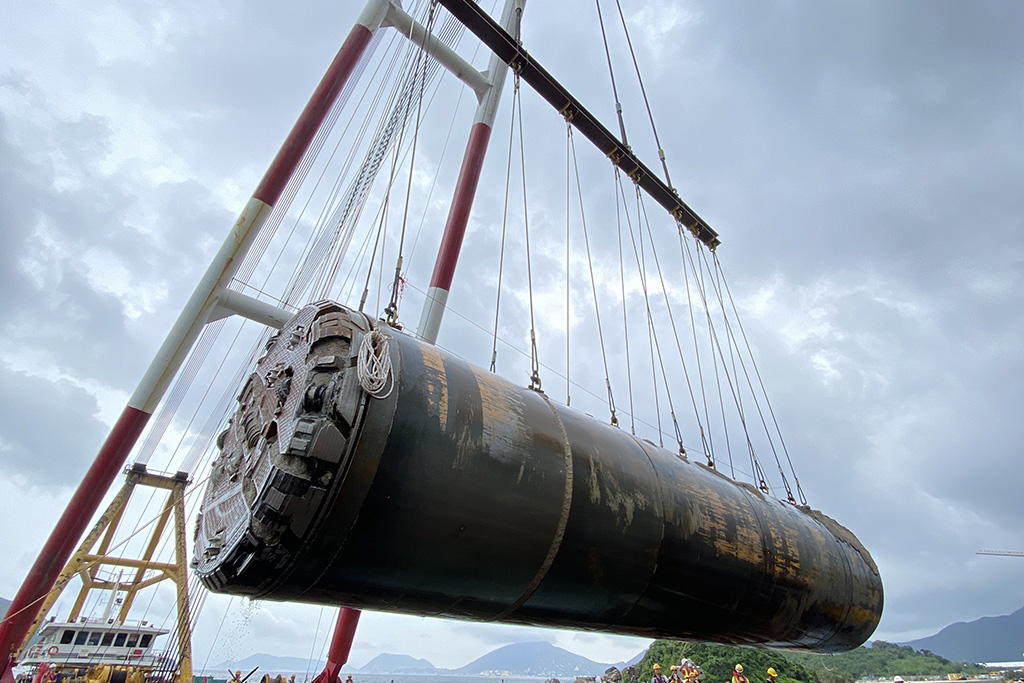

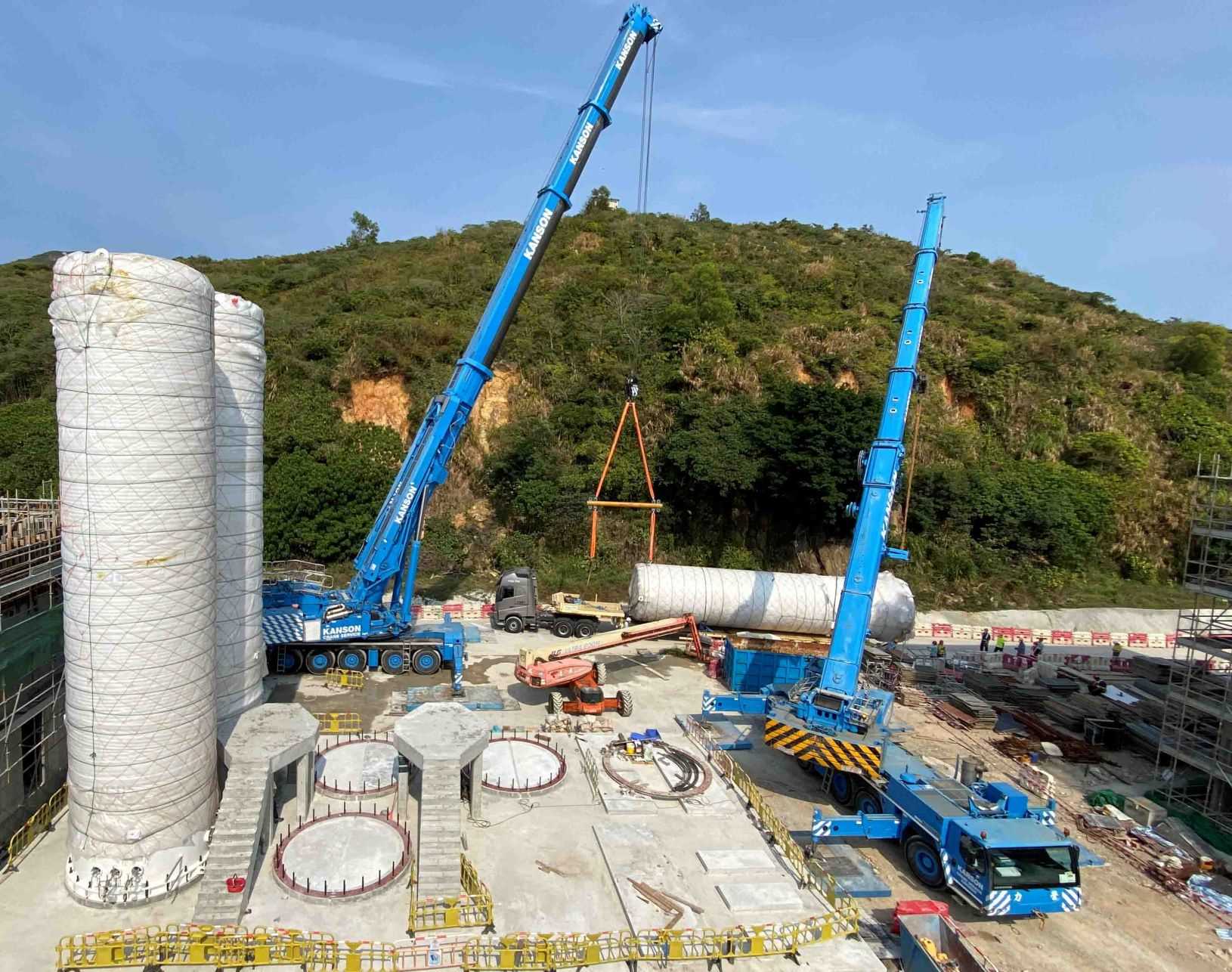

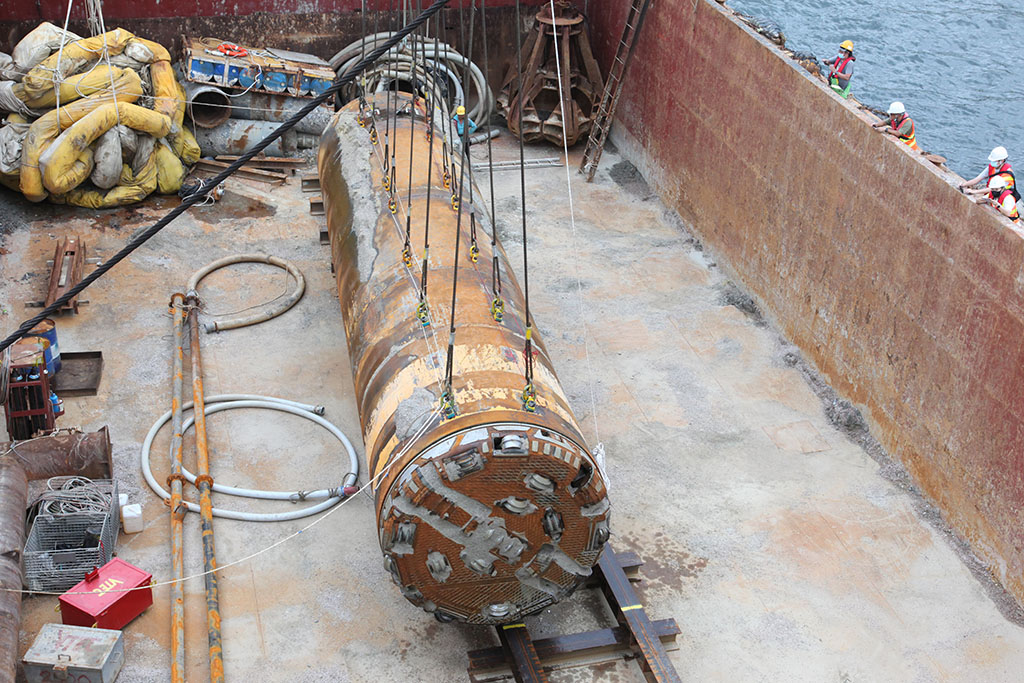

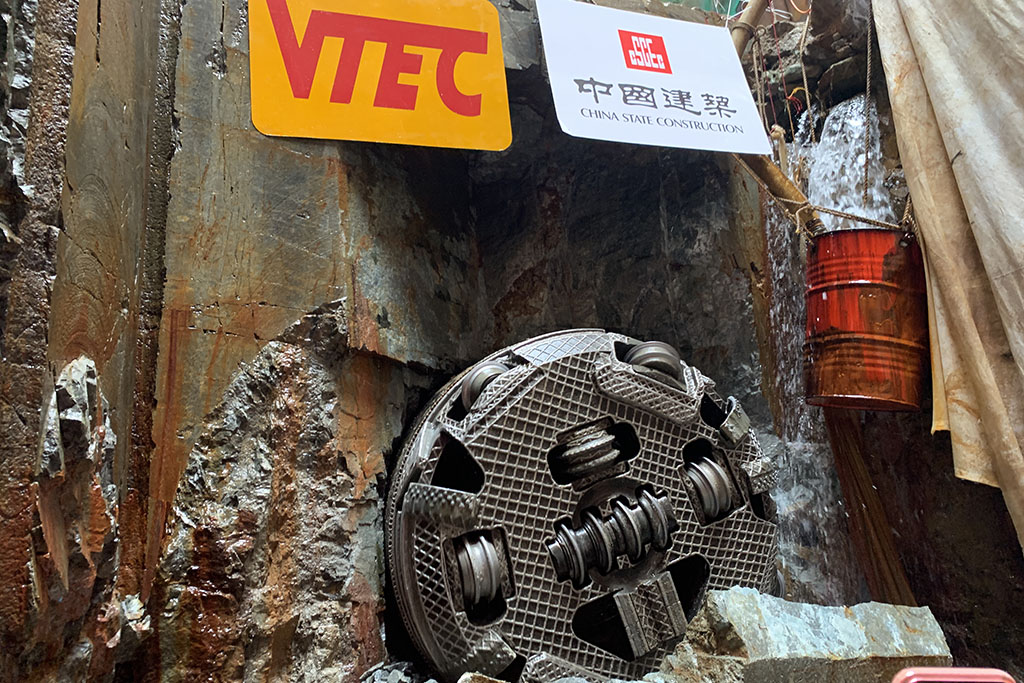

  • Breakthrough of 1.65m diameter TBM for Outfall pipe construction

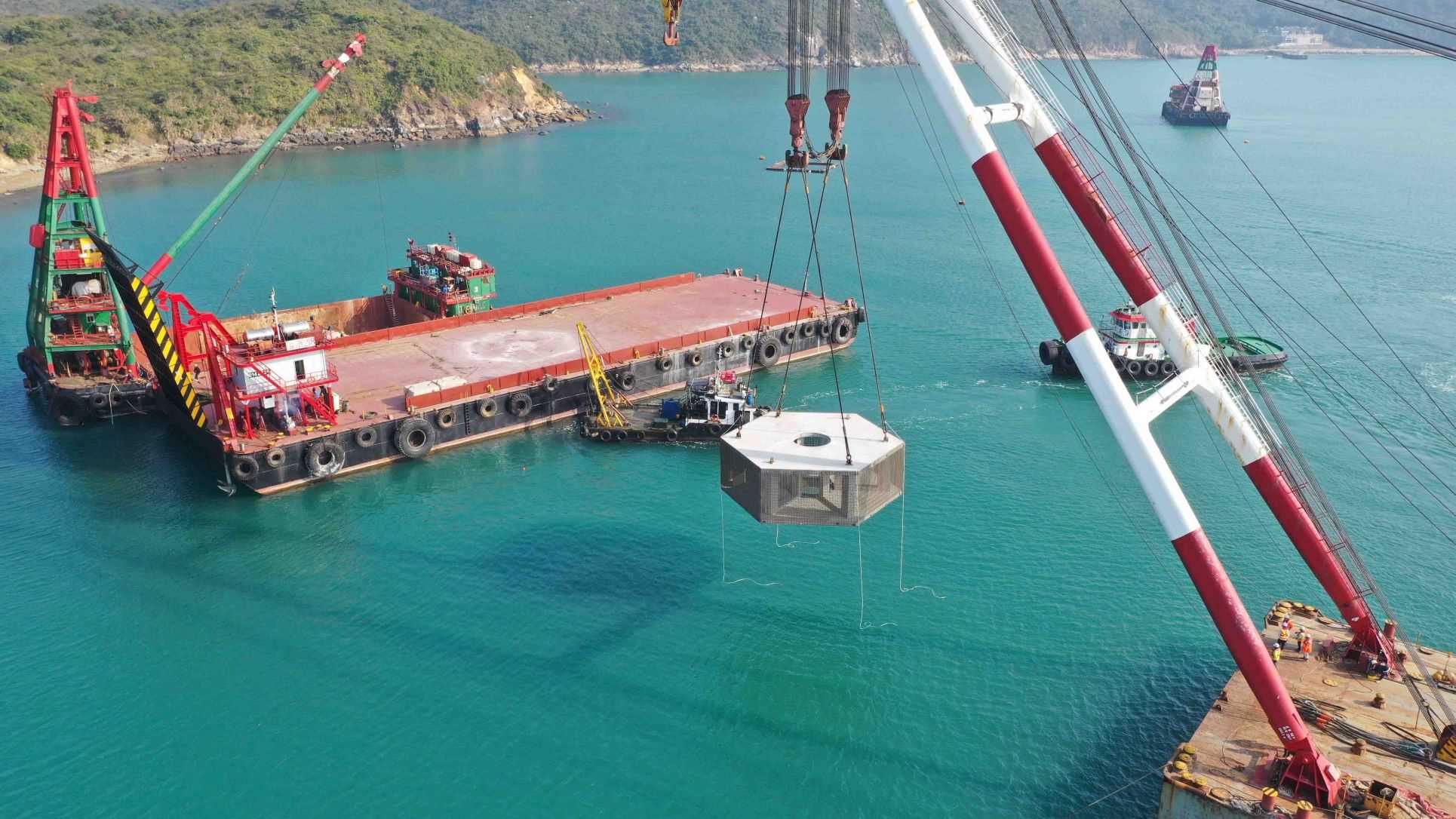

  • Lifting of TBM from temporary Outfall Shaft
  • Installation of energy recovery device (ERD) at the Reverse Osmosis Building



2021 Q4

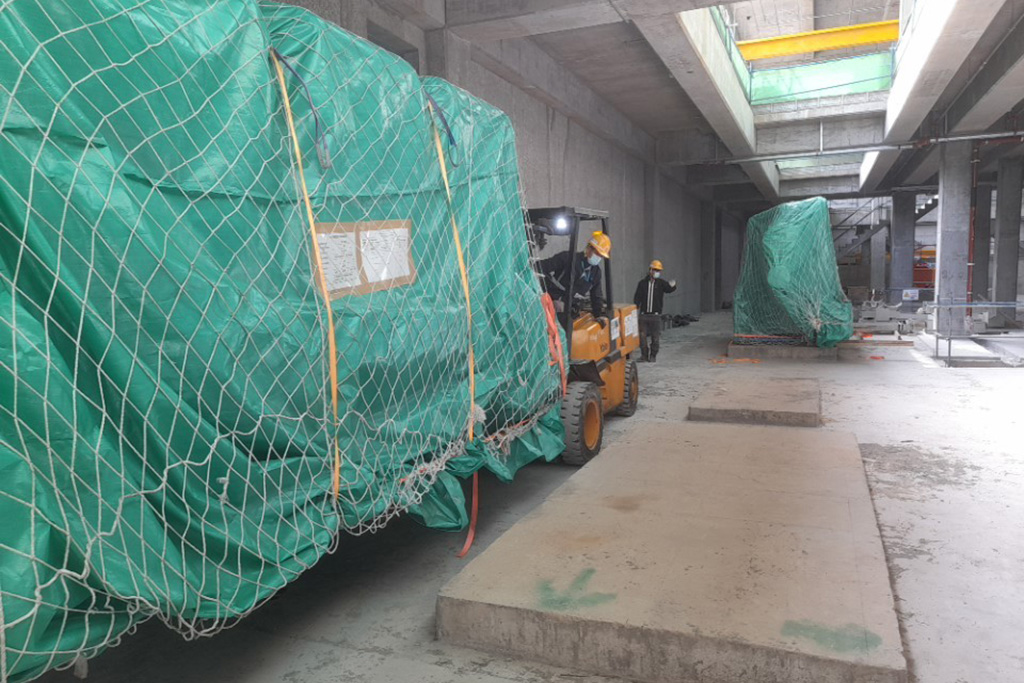

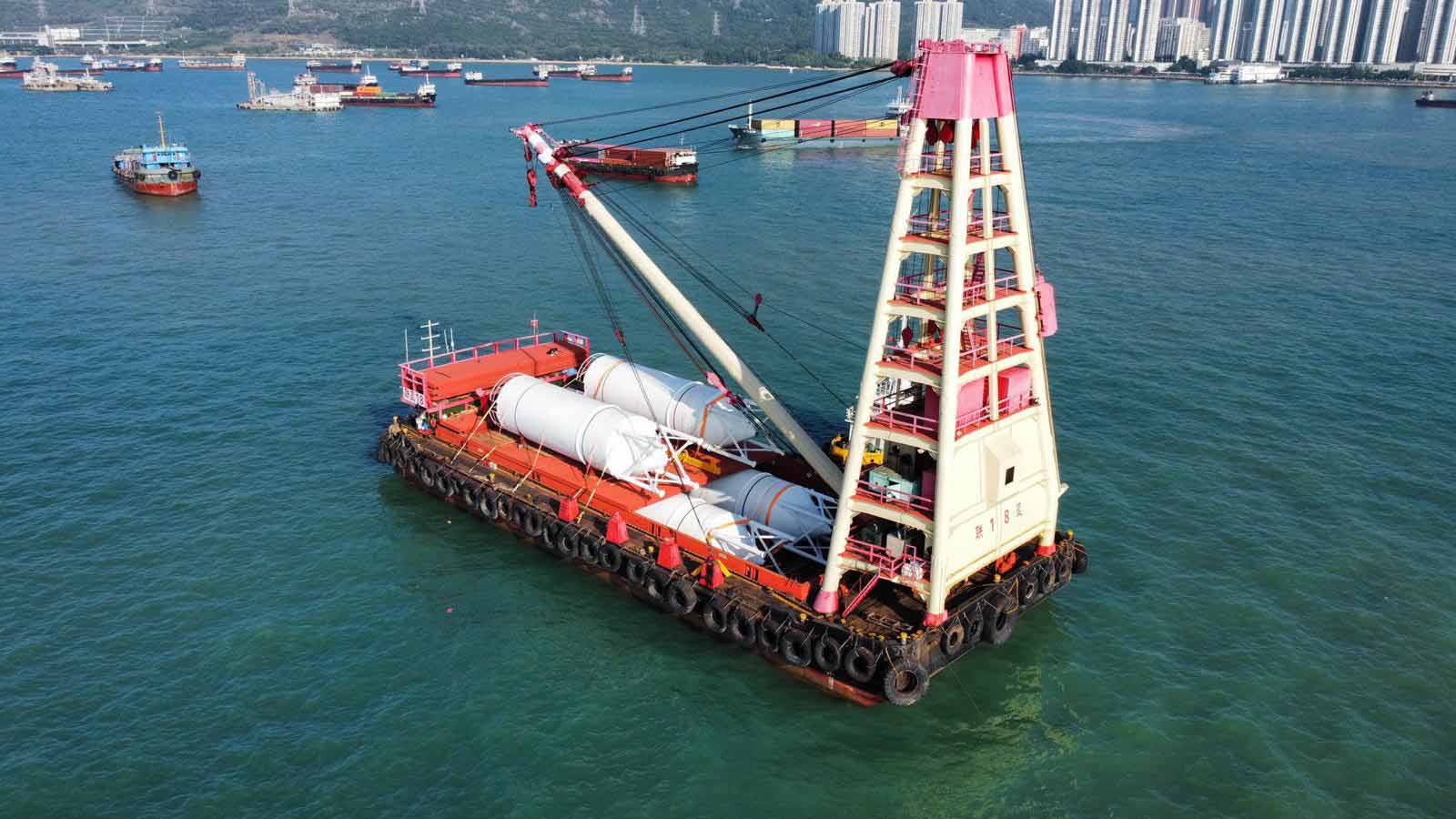

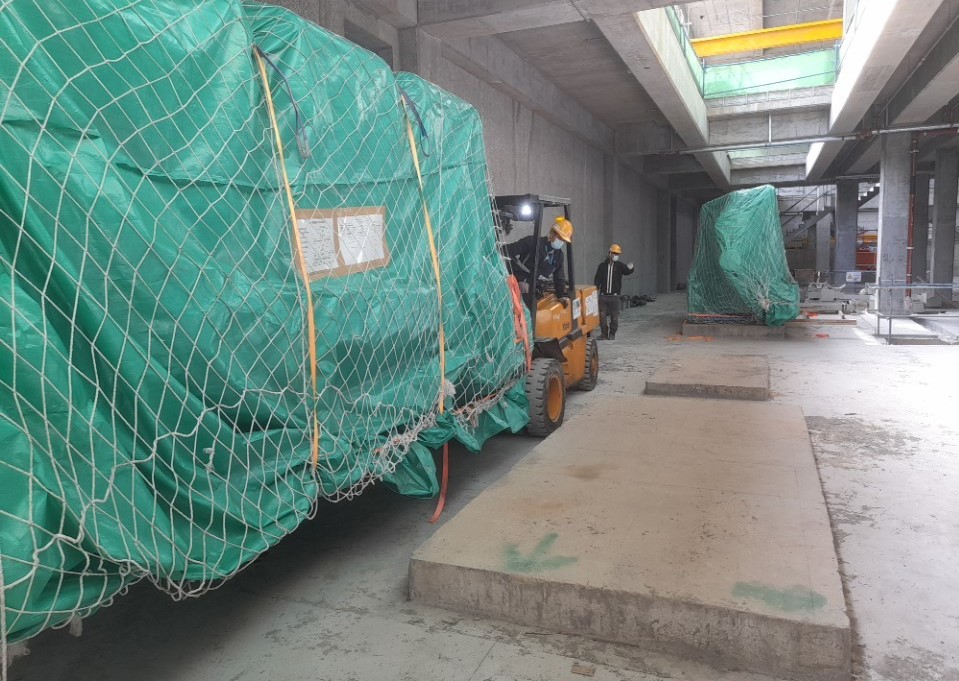

  • Delivery of DfMA Reverse Osmosis Racks from Jiangsu, China
  • 22nd Construction Safety Award Forum and Award Presentation

2021 Q3

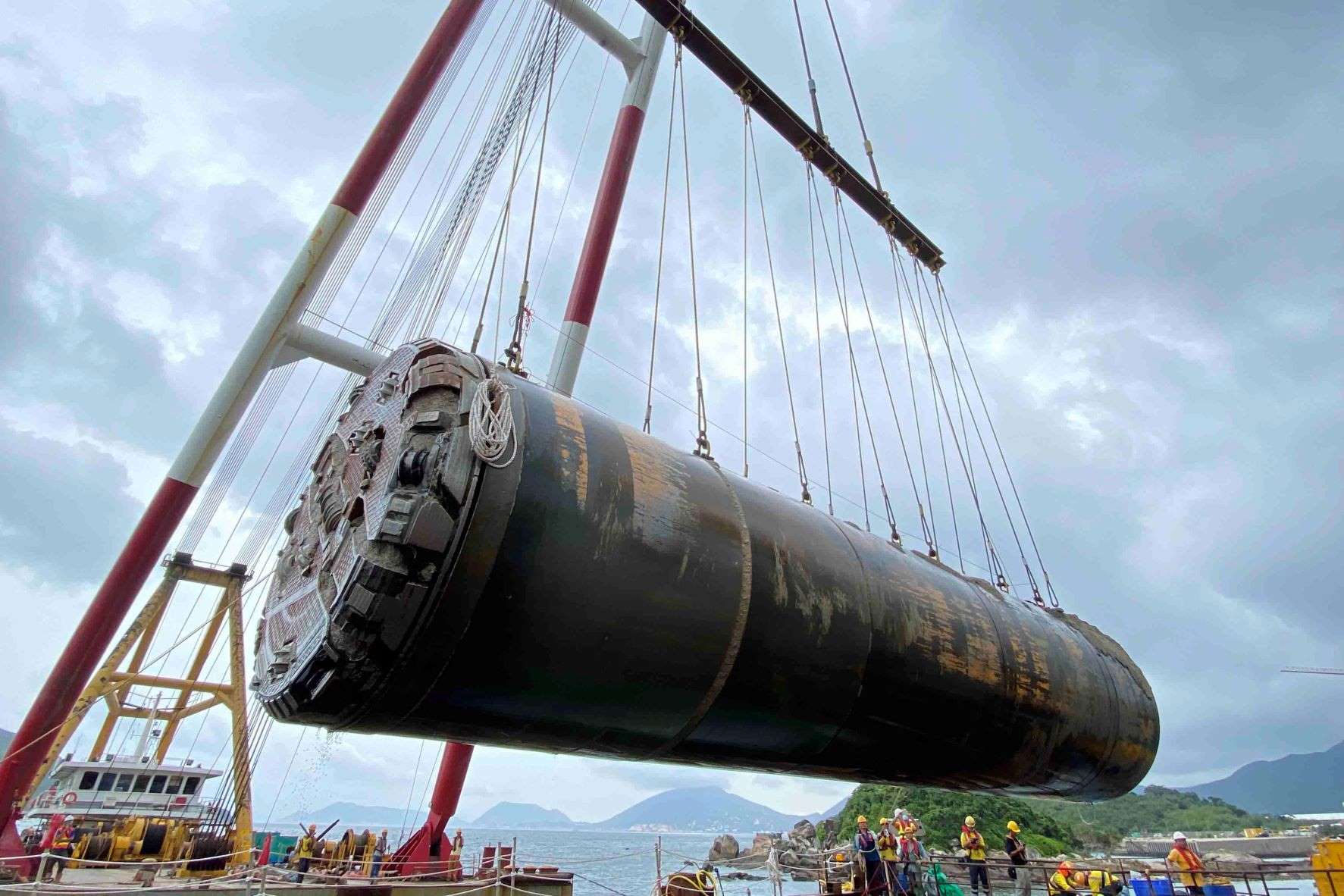

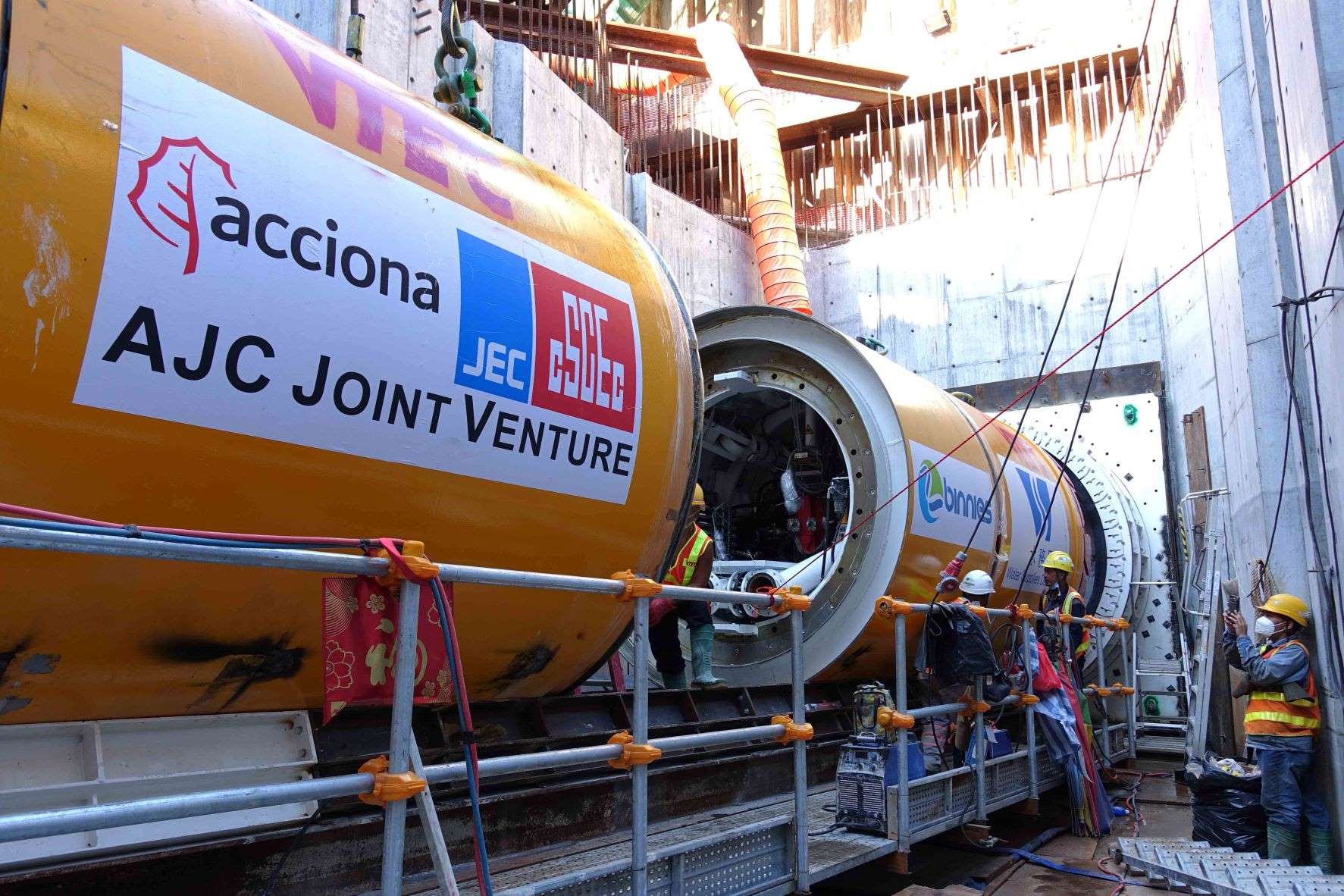

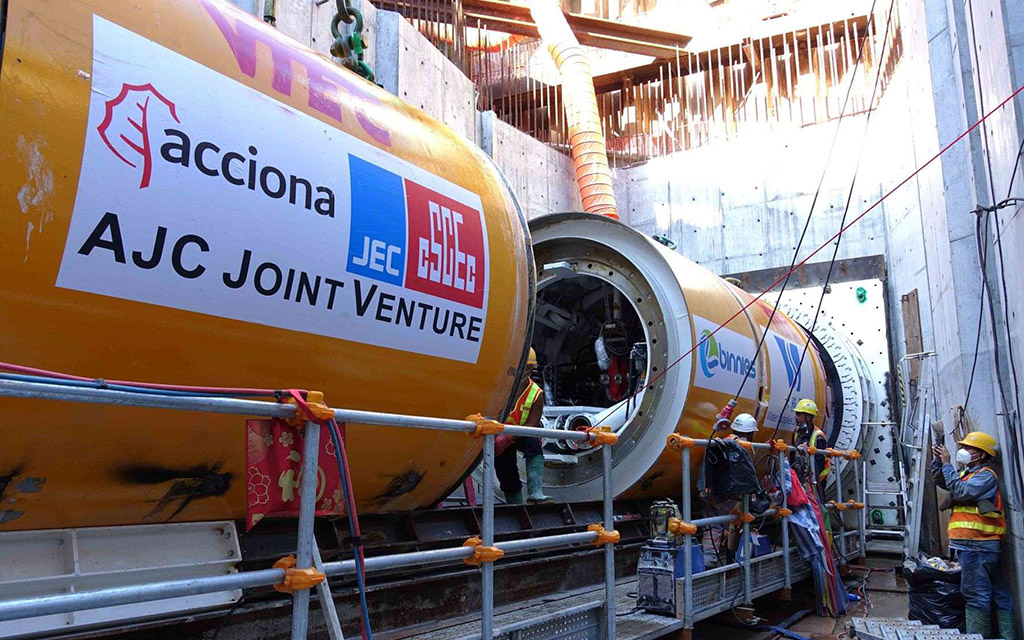

  • Launching of Tunnel Boring Machine (TBM) for Intake and Outfall Pipes
  • 27th Considerate Contractors Site Award Scheme Award Presentation Ceremony
  • Construction Safety Week 2021 “Safety X Smart Site”

2021 Q2

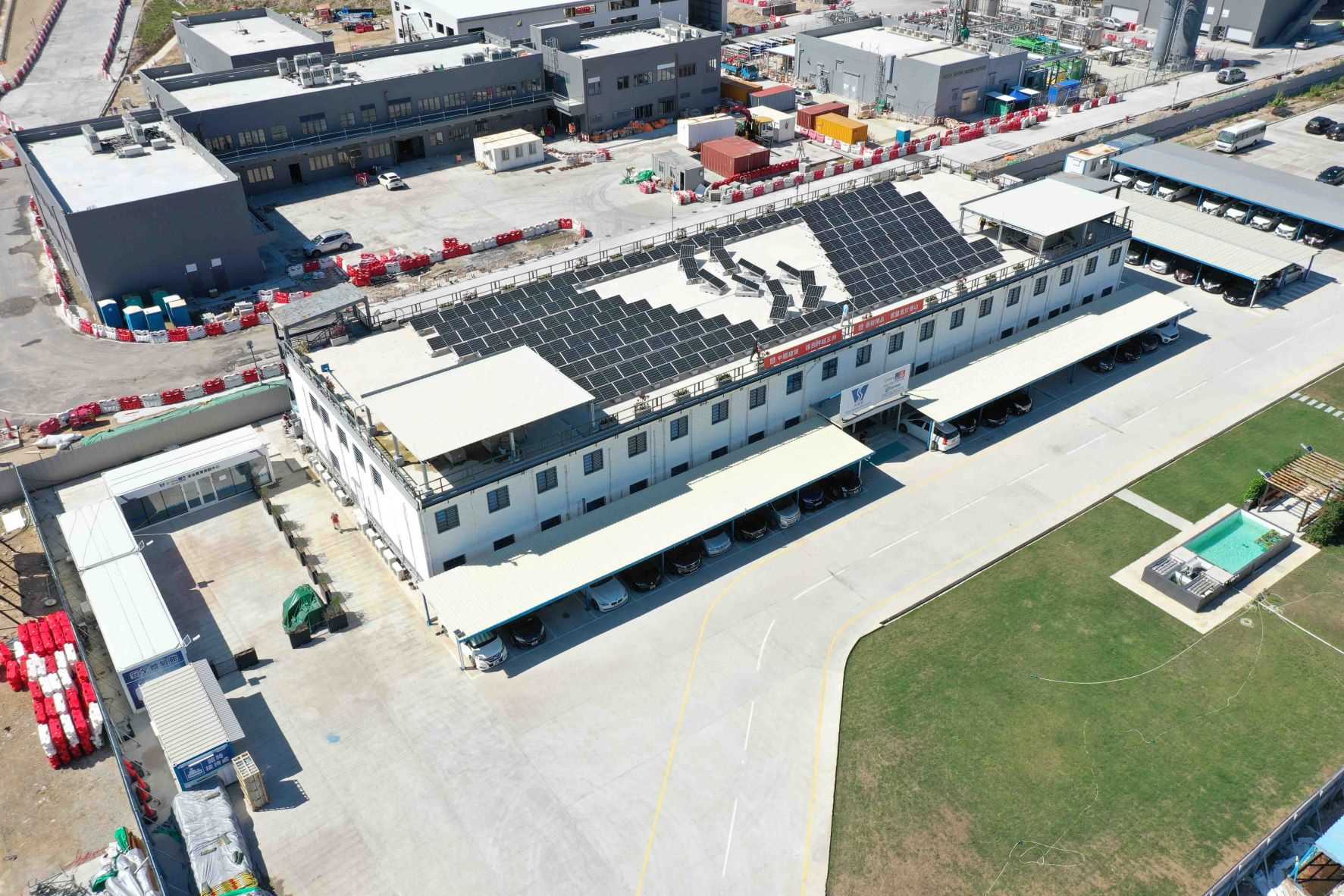

  • Installation of Solar Panels on MiC Site Office
  • Commencement of Yard Piping Works
  • Life First Event Industry-wide Construction Safety Campaign

2021 Q1

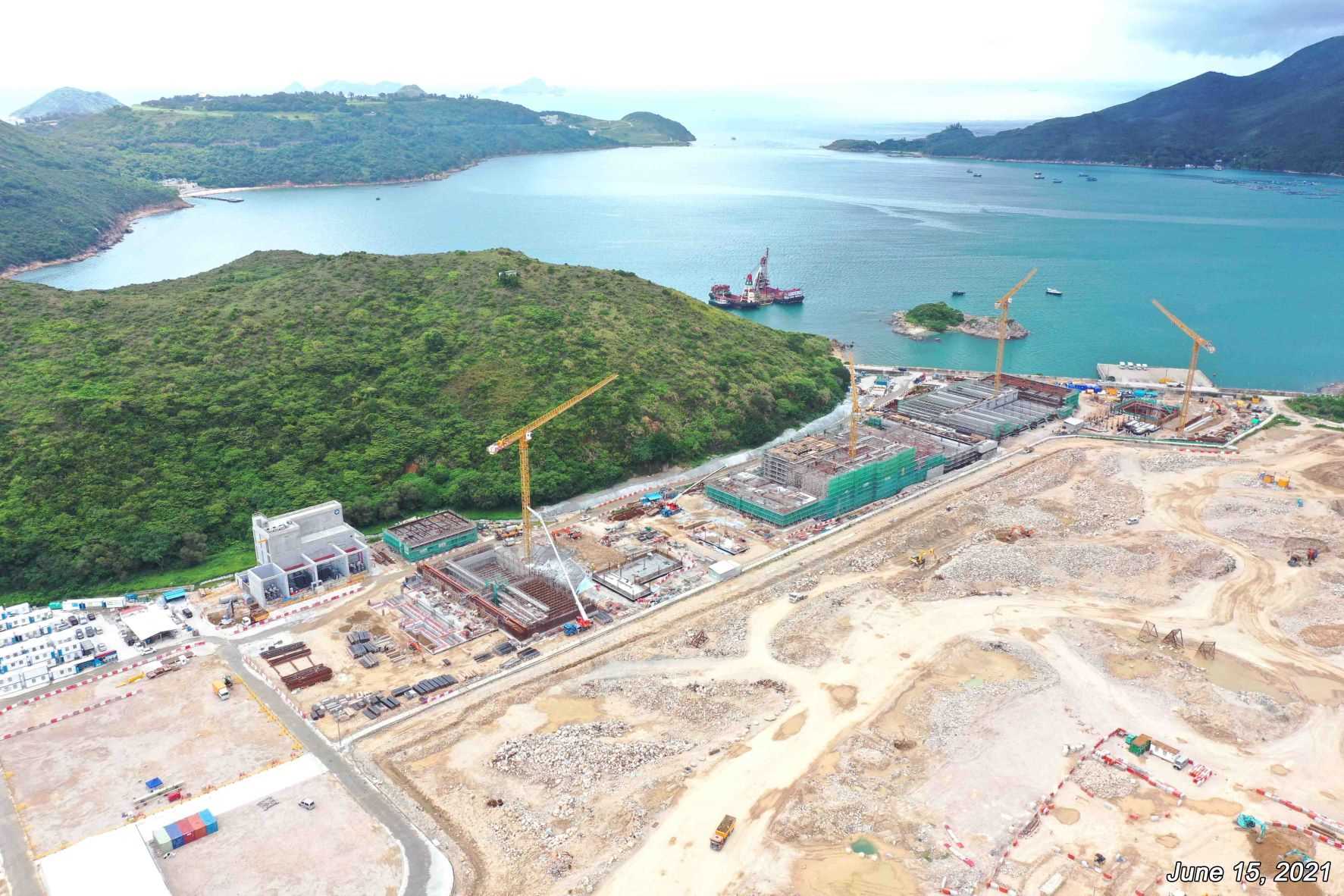

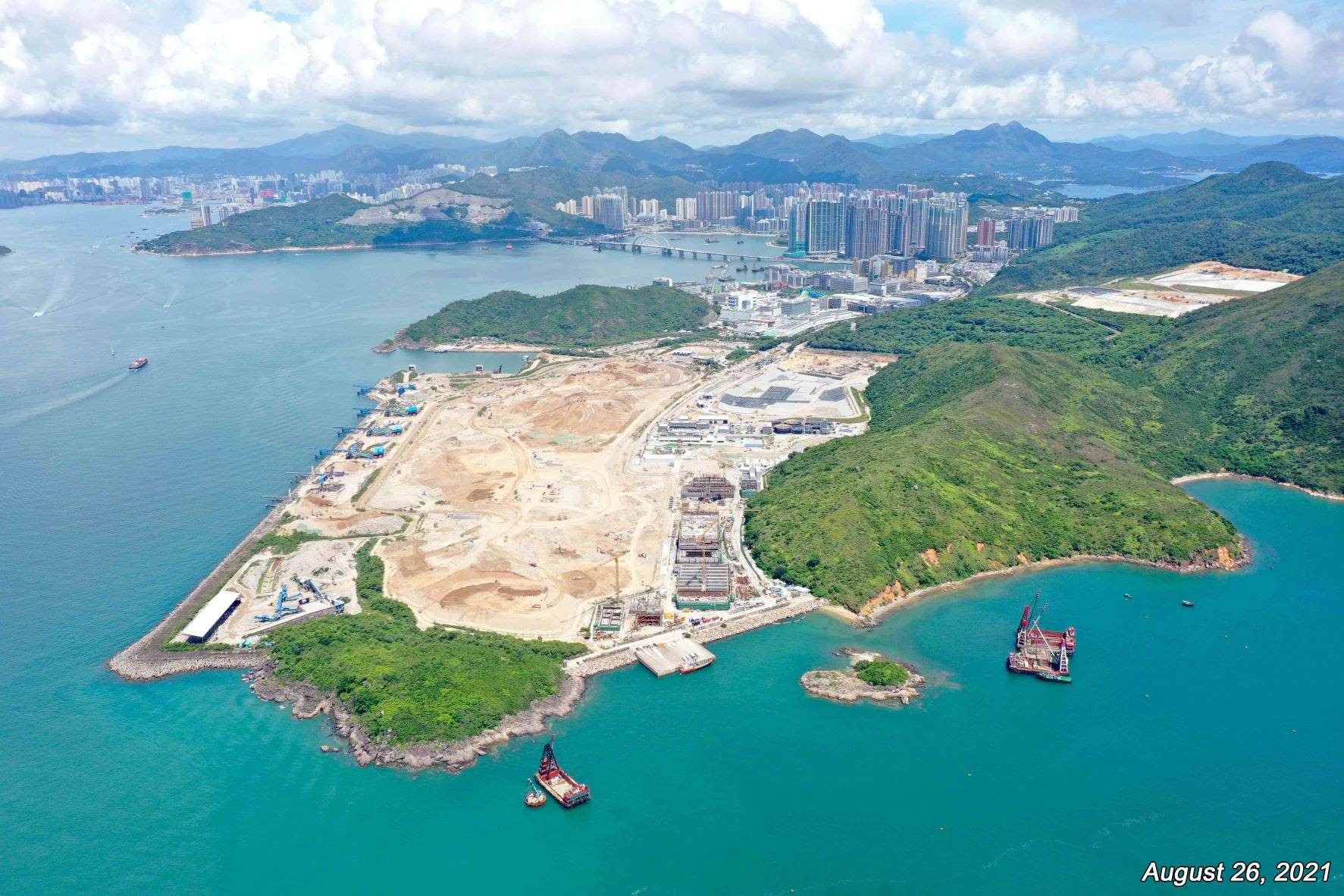

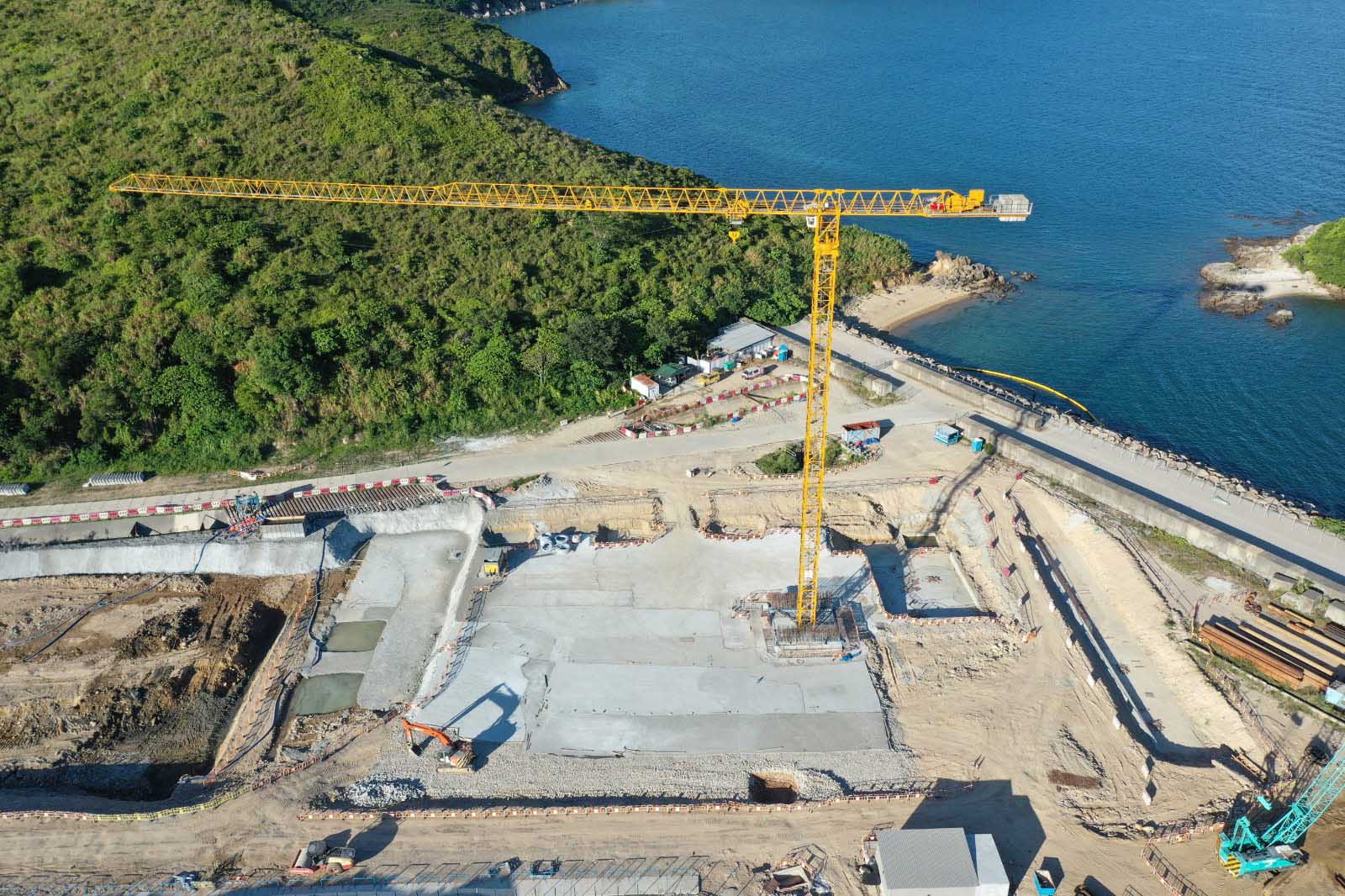

  • Commencement of Marine Works
  • Handover of 132kV Substation to CLP
  • Establishment of Centralized Management Platform
  • On-site COVID-19 Testing for workers

2020

  • Completed major detailed design of civil and structure works
  • Completed most excavation and foundation of building works
  • Establishment of MiC Site Office
  • Establishment of VR Safety Training Centre
