Revision History
Rev. |
Description of Modification |
Date |
1. |
Awaiting for comments |
07/11/2024 |
2. |
Revised according to the comments |
11/11/2024 |
CONTENTS
9. Summary of Exceedance, Complaints, Notification of Summons and Prosecutions.............. 36
Appendix A |
Master
Programme |
Appendix B |
Overview of Desalination Plant
in Tseung Kwan
O |
Appendix C |
Summary of Implementation Status
of Environmental Mitigation |
Appendix D |
Event/Action
Plan |
Appendix E |
Landfill Gas
Equipment Calibration Certificate |
Appendix F |
Landfill Gas Monitoring Data |
Appendix G |
Waste Flow
Table |
Appendix H |
Site Inspection Proforma |
Appendix I |
Complaint Log |
Appendix J |
Exceedance Report |
Introduction
A1. The Project, Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (TKODP), is a Designated Project under the Environmental Impact Assessment Ordinance (Cap. 499) (EIAO) and is currently governed by a Further Environmental Permit (EP No. FEP - 01/503/2015/B) for the construction and operation of the Contract.
A2. In accordance with the Environmental Monitoring and Audit (EM&A) Manual for the Contract, EM&A works for marine water quality, noise, waste management and ecology should be carried out by Environmental Team (ET), Acuity Sustainability Consulting Limited (ASCL), during the construction phase of the Contract.
A3. This is the 56th Monthly EM&A Report, prepared by ASCL, for the Contract summarizing the monitoring results and audit findings of the EM&A programme at and around Tseung Kwan O Area 137 (TKO 137) during the reporting period from 1 October to 31 October 2024.
A4. The EM&A programme for this contract has covered environmental monitoring on construction noise level at selected NSRs and Contractor¡¦s environmental performance auditing in the aspects of construction dust, construction noise, water quality, waste management, Landscape and Visual and Ecology.
Summary of Main Works Undertaken & Key Mitigation Measures Implemented
A5. Key activities carried out in this reporting period for the Contract included the followings:
All Area -
Security Fence
footing construction work -
Footpath Construction -
Landscape Construction -
Irrigation System
Construction -
Water Pressure Test for FS and PL system -
Landscape planting work -
Traffic signage
work -
E&M Works
and Mechanical Installation |
PWST -
Water Test in Tank A -
Waterproofing work
at Roof Slab
on Tank A -
Installation of building services, electrical switchboards and cables -
Installation of mechanical equipment, steel pipe, Pressure Test |
Administration Building -
External wall
aluminum features installation -
Finishing works
for dog house -
Minor Installation of building services, electrical switchboards &
cables, Pressure Test,
T&C |
Chemical building -
Defect rectification -
Repairing the defects inside
the dangerous store |
Combined Shaft
& Pump House -
Internal finishing, defect rectification -
Construction of hose reel
cabinet -
T&C |
ActiDAFF -
Installation of access opening covers for filtered water tank -
Carrying out finishing works
for staircase no. 3. -
Minor Installation of mechanical equipment, piping system -
Minor Installation of building services, electrical switchboards and cables, Installation of FRP Enclosure System |
Product Water
Storage Tank Building -
Minor Installation of building services, cable laying and termination, PV Panel
Installation, Testing & Commissioning |
OSCG Building -
Protective Coating for DG Rooms -
Installation of Railing on Brine Maker
Tank -
Minor Installation of building services, cables and pipe
works, T&C -
Tank surface
cleaning, T&C |
Reverse Osmosis Building -
Installation
of Signage, AP doors, sanitary
fitting, sanitary ware in toilet, tiling
work and water meter cabinets -
Minor Installation of building services, minor cable laying
and termination, Testing & Commissioning, PV Panel Installation |
Post Treatment Building -
Installation of Cat Ladders
in Water Tanks -
Placing Soil
Mix at Roof -
Curb Construction for Rescue Opening at Water Tanks -
Installation of building services, piping system, mechanical equipment and piping system, Pressure Test |
Inspection gallery -
Construction of roof tiling
works -
Installation of steel balustrade at roof -
Installation of movement joints |
-
Construction of block works -
Minor Installation of building service, T&C |
RO and
Electrical Building -
Installation of Glass House -
Minor Installation of building services, electrical switchboards and cables -
Minor Installation of mechanical pipework and raised Floor, -
PV Panel
Installation, T&C Chiller plant & Main Electrical Building -
Minor Installation of building services, electrical switchboards and cables, Pressure Test, T&C Others -
Slope works -
Construction works
of extended access
road |
A6. The major environmental impacts brought by the above construction works include:
- Construction dust and noise generation from construction works and excavation works and slope works;
- Waste generation from the construction activities
A7. The key environmental mitigation measures implemented for the Contract in this reporting period associated with the above construction works include:
- Dust suppression by regular wetting and water spraying for construction works;
- Reduction of noise from equipment and machinery on-site and regular inspection to machinery and plants/vehicles on-site to ensure proper functioning;
- Deployment of silt curtain at the inshore water outflow;
- Sorting and storage of general refuse and construction waste; and
-
Deployment protective fencing
for trees
Summary of exceedance & investigation & follow-up
A8. No noise monitoring was conducted during the reporting period since there are no Contract -related construction activities undertaken within a radius of 300m from the monitoring locations. No exceedance of the action Level was recorded during the reporting period.
A9. The construction phase marine water quality programme was ceased from 1 September 2023 due to the completion of marine-related construction works.
A10. Water quality monitoring of the discharge of dechlorinated effluent in disinfection procedure is completed in December 2023. The hourly dechlorinated effluent monitoring during the discharge is finished.
A11. In this reporting period, 63 times of landfill gas monitoring were periodically conducted at TKO Area 137 (Ch1+120 - Ch1+800) until 31 October 2024. No exceedances of action level and limit level was observed.
A12. Joint site inspections of the construction work by ET and IEC were carried out on 28 October 2024 to audit the mitigation measures implementation status.
Complaint Handling and Prosecution
A13. No environmental complaint, notification of summons and prosecution was received in the reporting period.
Reporting Change
A14. According to the contractor¡¦s information, the TKODP commenced operation phase on 1 July 2024. The outstanding construction works were being carried out during this reporting period.
Summary of Upcoming
Key Issues and Key Mitigation Measures
A15. Key activities anticipated in the next reporting period for the Contract will include the followings:
All Area -
Security Fence
footing construction work -
Footpath Construction -
Landscape Construction -
Irrigation System
Construction -
Water Pressure Test for FS and PL system -
Landscape planting work -
Traffic signage
work -
E&M Works
and Mechanical Installation |
PWST -
Water Test in Tank A -
Waterproofing work
at Roof Slab
on Tank A -
Installation of building services, electrical switchboards and cables -
Installation of mechanical equipment, steel pipe, Pressure Test |
Administration Building -
External wall
aluminum features installation -
Finishing works
for dog house -
Minor Installation of building services, electrical switchboards &
cables, Pressure Test,
T&C |
Chemical building -
Defect rectification -
Repairing the defects inside
the dangerous store |
Combined Shaft
& Pump House -
Internal finishing, defect rectification -
Construction of hose reel
cabinet -
T&C |
ActiDAFF -
Installation of access opening covers for filtered water tank -
Carrying out finishing works
for staircase no. 3. -
Minor Installation of mechanical equipment, piping system -
Minor Installation of building services, electrical switchboards and cables, Installation of FRP Enclosure System |
Product Water
Storage Tank Building -
Minor Installation of building services, cable laying and termination, PV Panel
Installation, Testing & Commissioning |
OSCG Building -
Protective Coating for DG Rooms -
Installation of Railing on Brine Maker
Tank -
Minor Installation of building services, cables and pipe
works, T&C -
Tank surface
cleaning, T&C |
Reverse Osmosis Building -
Installation
of Signage, AP doors, sanitary
fitting, sanitary ware in toilet, tiling
work and water meter cabinets -
Minor Installation of building services, minor cable laying
and termination, Testing & Commissioning, PV Panel Installation |
Post Treatment Building -
Installation of Cat Ladders
in Water Tanks -
Placing Soil
Mix at Roof -
Curb Construction for Rescue Opening at Water Tanks -
Installation of building services, piping system, mechanical equipment and piping system, Pressure Test |
Inspection gallery -
Construction of roof tiling
works -
Installation of steel balustrade at roof -
Installation of movement joints -
Construction of block works -
Minor Installation of building service, T&C |
RO and
Electrical Building -
Installation of Glass House -
Minor Installation of building services, electrical switchboards and cables -
Minor Installation of mechanical pipework and raised Floor, -
PV Panel
Installation, T&C |
Chiller plant
& Main Electrical Building -
Minor Installation of building services, electrical switchboards and cables, Pressure Test, T&C Others -
Construction works
of extended access
road |
A16. The major environmental impacts brought by the above construction works will include:
- Construction dust and noise generation from excavation and construction works;
- Waste generation from construction activities.
A17. The key environmental mitigation measures for the Contract in the coming reporting period associated with the above construction works will include:
- Reduction of noise from equipment and machinery on-site;
- Dust suppression by regular wetting and water spraying for construction works and at main haul road;
- Sorting and storage of general refuse and construction waste;
- Deployment of silt curtain at the inshore water outflow;
-
Deployment protective fencing
for trees.
Background
1.1. The Acciona Agua, S.A. Trading, Jardine Engineering Corporation, Limited and China State Construction Engineering (Hong Kong) Limited as AJC Joint Venture (AJCJV) is contracted to carry out the Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (DPTKO) under Contract No. 13/WSD/17 (the Contract).
1.2. Acuity Sustainability Consulting Limited (ASCL) is commissioned by AJCJV to undertake the Environmental Team (ET) services as required and/or implied, both explicitly and implicitly, in the Environmental Permit (EP), Environmental Impact Assessment Report (EIA Report) (Register No. AEIAR-192/2015) and Environmental Monitoring and Audit Manual (EM&A Manual) for the Contract; and to carry out the Environmental Monitoring and Audit (EM&A) programme in fulfillment of the EIA Report¡¦s EM&A requirements and Contract No. 13/WSD/17 Specification requirements.
1.3. Pursuant to the Environmental Impact Assessment Ordinance (EIAO), the Director of Environmental Protection granted the Environmental Permit (No. EP-503/2015/B) to Water Supplies Department (WSD); and granted the Further Environmental Permit (No. FEP-01/503/2015/B) to AJCJV for the Contract.
1.4. According to the contractor¡¦s information, the TKODP commenced operation phase on 1 July 2024. The outstanding construction works were being carried out during this reporting period.
The Reporting Scope
1.5. This is the 56th Monthly EM&A Report for the Contract which summarizes the key findings of the EM&A programme during the reporting period from 1 October to 31 October 2024.
Contract Organization
1.6. The Contract Organization structure for Construction Phase is presented in Figure 1.1.
Figure 1.1 Contract Organization Chart
1.7. Contact details of the key personnel are presented in Table 1.1 below:
Table 1.1 Contact Details of Key Personnel
Party |
Position |
Name |
Telephone no. |
Contract Proponent (Water Supplies Department) |
SE/CM2 |
Milton Law |
2634-3573 |
Supervising
Officer (Binnies
Hong Kong Limited) |
Project Manager |
Augustine Li |
2608-7671 |
Chief Resident Engineer |
David Wong |
5229-8638 |
|
The
Jardine Engineering Corporation, Limited, China
State Construction Engineering (Hong Kong) Limited and Acciona Agua, S.A. Trading |
Project Manager |
Stephen
Yeung |
2807-4665 |
Environmental Monitoring Manager |
Brian Kam |
9456-9541 |
|
Operation
Manager |
Arnes
Parra, Victor |
6468-6710 |
|
Environmental Monitoring Manager |
Tommy Law |
6468-1782 |
|
Acuity Sustainability Consulting Limited |
Environmental
Team Leader |
Toby Wan |
9719-5422 |
Lam Environmental Services Limited |
Independent Environmental Checker (IEC) |
Serena Shek |
6149-6683 |
Summary of Construction Works
1.8. Details of the major construction activities undertaken in this reporting period are shown below. The master programme is presented in Appendix A.
1.9. Key activities carried out in this reporting period for the Contract included the followings:
All Area -
Security Fence
footing construction work -
Footpath Construction -
Landscape Construction -
Irrigation System
Construction -
Water Pressure Test for FS and PL system -
Landscape planting work -
Traffic signage
work |
|
-
E&M Works
and Mechanical Installation |
||
|
PWST -
Water Test in Tank A -
Waterproofing work
at Roof Slab
on Tank A -
Installation of building services, electrical switchboards and cables -
Installation of mechanical equipment, steel pipe, Pressure Test |
||
|
Administration Building -
External wall
aluminum features installation -
Finishing works
for dog house -
Minor Installation of building services, electrical switchboards &
cables, Pressure Test, T&C |
||
|
Chemical building -
Defect rectification -
Repairing the defects inside
the dangerous store |
||
|
Combined Shaft
& Pump House -
Internal finishing, defect rectification -
Construction of hose reel
cabinet -
T&C |
||
|
ActiDAFF -
Installation of access opening covers for filtered water tank -
Carrying out finishing works
for staircase no. 3. -
Minor Installation of mechanical equipment, piping system -
Minor Installation of building services, electrical switchboards and cables, Installation of FRP Enclosure System |
||
|
Product Water
Storage Tank Building -
Minor Installation of building services, cable laying and termination, PV Panel
Installation, Testing & Commissioning |
||
|
OSCG Building -
Protective Coating for DG Rooms -
Installation of Railing on Brine Maker
Tank -
Minor Installation of building services, cables and pipe
works, T&C -
Tank surface
cleaning, T&C |
||
|
Reverse Osmosis Building -
Installation
of Signage, AP doors, sanitary
fitting, sanitary ware in toilet, tiling
work and water meter cabinets -
Minor Installation of building services, minor cable laying
and termination, Testing & Commissioning, PV Panel Installation |
||
|
Post Treatment Building -
Installation of Cat Ladders
in Water Tanks -
Placing Soil
Mix at Roof |
||
|
-
Curb Construction for Rescue Opening at Water Tanks -
Installation of building services, piping system, mechanical equipment and piping system, Pressure Test |
|
|
Inspection gallery -
Construction of roof tiling
works -
Installation of steel balustrade at roof -
Installation of movement joints -
Construction of block works -
Minor Installation of building service, T&C |
|
||
RO and
Electrical Building -
Installation of Glass House -
Minor Installation of building services, electrical switchboards and cables -
Minor Installation of mechanical pipework and raised Floor, -
PV Panel
Installation, T&C Chiller plant & Main Electrical Building -
Minor Installation of building services, electrical switchboards and cables, Pressure Test, T&C Others -
Slope works -
Construction works
of extended access
road |
|
||
1.10. A summary of the valid
permits, licences, and/or notifications on environmental |
|
||
protection for this Contract is presented in Table 1.2.
Table 1.2 Summary of the Status of Valid Environmental Licence, Notification, Permit and Documentations
Permit/ Licences |
Valid Period |
Status |
Remark |
|
From |
To |
|||
Environmental Permit |
||||
EP-503/2015/B |
Throughout the Contract |
Valid |
-Issued on 3 April 2024 |
|
FEP - 01/503/2015/B |
Throughout the Contract |
Valid |
-Issued on 3 April 2024 |
|
Notification of Construction Works under the Air Pollution Control (Construction
Dust) Regulation (Form NA) |
||||
451539 |
Throughout the Contract |
Valid |
- |
|
Billing Account for Disposal of Construction Waste |
||||
7036276 |
Throughout the Contract |
Valid |
- |
|
Sludge (Special Waste)
Disposal (Admission Ticket) |
||||
17913 |
01/07/2024 |
31/12/2024 |
Valid |
- |
17372 |
12/06/2024 |
31/12/2024 |
Valid |
- |
Chemical Waste Producer Registration |
||||
5213-839-A2987- 01 |
Throughout the Contract |
Valid |
- |
|
Wastewater Discharge Licence (Land
and Marine works) |
||||
WT00035775-2020 |
23/08/2021 |
31/07/2025 |
Valid |
- |
WT00044188-2023 |
16/06/2023 |
30/06/2028 |
Valid |
- For Plant T&C and operation. - Variation sampling point S.P.1
is approved by the EPD on
25 June 2024 (EPD ref.: EP640/W3/D1358/46
2874). - The variation of application
of discharge license was submitted on 9 September 2024
and pending for EPD approval |
Construction Noise Permit |
||||
GW-RE0667-24 |
22/06/2024 |
20/12/2024 |
Valid |
- |
1.11. The status for all environmental aspects is presented in Table 1.3.
Table 1.3 Summary of Status for Key Environmental Aspects under the EM&A Manual
Parameters |
Status |
||
Water Quality |
|||
Baseline Monitoring Manual |
under |
EM&A |
The baseline water quality monitoring was conducted between 12 May 2020
to 6 Jun 2020. |
Construction Phase
Impact Monitoring |
Ceased from
1 September 2023 |
||
Operation phase Monitoring |
Marine |
Impact |
On-going |
Impact Monitoring of Effluent Discharge from Main Disinfection |
Completed |
||
Noise |
|||
Baseline Monitoring |
The baseline noise monitoring result
has been reported in Baseline Monitoring Report and
submitted to EPD
under EP Condition 3.4 |
||
Impact Monitoring |
Completed |
||
Waste Management |
|||
Mitigation Measures in Waste Management Plan |
On-going |
||
Landfill Gas |
|||
Regular Monitoring when construction
works are within the 250 m Consultation Zone |
On-going |
||
Ecology (Coral) |
|||
Operation phase Regular Coral Monitoring (Monthly) |
On-going |
||
Ecology (Fishery) |
|||
Operation phase Regular Fishery Monitoring (Seasonally) |
On-going |
||
Ecology (Landscape) |
|||
Operation phase Landscape and Visual
Site Inspection |
On-going |
||
Environmental Audit |
|||
Site Inspection covering Measures of Air
Quality, Noise Impact, Water Quality, Waste, Ecological Quality, Fisheries, Landscape and Visual |
On-going |
1.12. Other than the EM&A work by ET, environmental briefings, trainings, and regular environmental management meetings were conducted, in order to enhance environmental awareness and closely monitor the environmental performance of the contractors.
1.13. The EM&A programme has been implemented in accordance with the recommendations presented in the approved EIA Report and the EM&A Manual. A summary of implementation status of the environmental mitigation measures for the construction phase of the Contract during the reporting period is provided in Appendix C.
Monitoring Requirements
2.1. To ensure no adverse noise impact, noise monitoring is recommended to be carried out within 300m radius from the nearby noise sensitive receivers (NSRs), during construction phase. The NSRs selected as monitoring station are (i) NSR4 - Creative Secondary School, (ii) NSR24 - PLK Laws Foundation College, and (iii) NSR31 - School of Continuing and Professional Studies - CUHK respectively.
2.2. Construction noise level were measured in terms of the A-weighted equivalent continuous sound pressure level (LAeq). Leq 30min was used as the monitoring parameter for the time period between 0700 and 1900 on normal weekdays. Construction works would follow stipulations of the valid Construction Noise Permits if works had to be conducted during restricted hours or public holidays. Table 2.1 summarizes the monitoring parameters, frequency, and duration of the impact noise monitoring.
Table 2.1 Noise Monitoring Parameters, Time, Frequency and Duration
Time |
Duration |
Interval |
Parameters |
Daytime: 0700-1900 |
Day
time: 0700-1900 (during normal weekdays) |
Continuously in Leq
5min/Leq 30min (average of 6 consecutive
Leq 5min) |
Leq 30min L10 30min & L90
30min |
Monitoring Locations
2.3. The monitoring locations were normally made at a point 1m from the exterior of the NSRs building façade and be at a position 1.2m above the ground. A correction of +3dB(A) should be made to the free-field measurements.
2.4. According to the environmental findings detailed in the EIA report and Baseline Monitoring Report, the designated locations for the construction noise monitoring are listed in Table 2.2 below.
Table 2.2 Noise Sensitive Receivers
NSR ID |
Noise Sensitive Receivers |
Monitoring
Location |
Position |
NSR 4 |
Creative Secondary School |
Roof
Floor |
1 m from
facade |
NSR 24 |
PLK Laws
Foundation College |
Pedestrian Road on Ground Floor |
Free-field |
NSR 31 |
School
of Continuing and Professional Studies - CUHK |
Roof
Floor |
1 m from
facade |
2.5. Three noise monitoring locations for impact monitoring at the nearby sensitive receivers are shown in Figure 2.1-2.3.
|

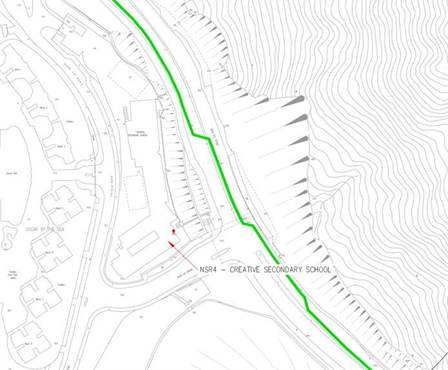

Figure 2.1 NSR4 Creative Secondary School |
|
Figure 2.2 NSR24 PLK Laws Foundation College |
|
Figure 2.3 NSR31
School of Continuing and Professional Studies - CUHK |
Impact Monitoring Methodology
2.6. Integrated sound level meter will be used for the noise monitoring. The meter will be in compliance with the International Electrotechnical Commission Publications 651: 1979 (Type 1) and 804: 1985 (Type 1) specifications. Immediately prior to and following each noise measurement the accuracy of the sound level meter will be checked using an acoustic calibrator generating a known sound pressure level at a known frequency. Measurements will be accepted as valid only if the calibration levels before and after the noise measurements agree to within 1.0 dB(A).
2.7. Noise measurements were not made in the presence of fog, rain, wind with a steady speed exceeding 5 m/s or wind with gusts exceeding 10 m/s. The wind speed shall be checked with a portable wind speed meter capable of measuring the wind speed in m/s.
Action and Limit Levels
2.8. The Action/Limit Levels are in line with the criteria of Practice Note for Professional Persons (ProPECC PN 2/93) ¡§Noise from Construction Activities - Non-statutory Controls¡¨ and Technical Memorandum on Environmental Impact Assessment Process issued by HKSAR Environmental Protection Department [¡§EPD¡¨] under the Environmental Impact Assessment Ordinance, Cap 499, S.16 are presented in Table 2.3.
Table 2.3 Action and Limit Levels for Noise per EM&A Manual
Time Period |
Action |
Limit (dB(A)) |
0700-1900 on normal
weekdays |
When
one documented complaint is received from any one of the
noise sensitive receivers |
-
70 dB(A)
for school and -
65 dB(A)
during examination period |
Note: Limits specified in the GW-TM
and IND-TM for construction and operation noise,
respectively.
2.9.
If exceedances were found
during noise monitoring, the actions in accordance with the Event and Action
Plan shall be carried out according to Appendix
D.
Monitoring Results and Observations
2.10. Referring to EM&A Manual Section 4.1.2, the impact noise monitoring should be carried out when there are Contract-related construction activities undertaken within a radius of 300m from the monitoring stations. As no Contract-related construction activities were undertaken in the reporting month within a radius of 300m from the monitoring stations as shown in Figure 2.4, no impact noise monitoring was conducted in the reporting period.
Figure 2.4 Site Layout Plan with Noise Sensitive Receivers and Desalination Plant
3.1. In accordance with the recommendations of the EIA, water quality monitoring is required during dredging for the submarine pipelines and, during operation phase. The following Section provides details of the water quality monitoring to be undertaken by the Environmental Team (ET) to verify the distance of sediment and brine plume dispersion and to identify whether the potential exists for any indirect impacts to occur to ecological sensitive receivers.
3.2. The water quality monitoring programme was be carried out to allow any deteriorating water quality to be readily detected and timely action taken to rectify the situation.
3.3. Water quality monitoring for the Contract can be divided into the following stages:
- Dredging activities during construction phase;
- Discharge of effluent from main disinfection during construction phase; and
- Operation activities during operation phase.
Water Quality Parameters
3.4. The parameters that have been selected for measurement in situ and in the laboratory are those that were either determined in the EIA to be those with the most potential to be affected by the construction works or are a standard check on water quality conditions. Parameters to be measured in the impact monitoring are listed in Table 3.1.
Table 3.1 Parameters measured in the Impact Marine Water Quality Monitoring
Parameters |
Unit |
Abbreviation |
In-situ measurements |
||
Dissolved oxygen |
mg/L |
DO |
Temperature |
oC |
- |
pH |
- |
- |
Turbidity |
NTU |
- |
Salinity |
0/00 |
- |
Total Residual Chlorine NOTE1 |
mg/L |
TRC |
Laboratory measurements |
||
Suspended Solids |
mg/L |
SS |
Iron-Soluble |
mg/L |
Fe |
Anti-scalant as Reactive Phosphorus |
mg/L |
PO4
as P- |
NOTE 1: Monitoring of Total Residual
Chlorine will be conducted
when cleaning and sterilization of the
new freshwater main is carried out.
3.5. In addition to the water quality parameters, other relevant data were also being measured and recorded in Water Quality Monitoring Logs, including the location of the sampling stations, water depth, time, weather conditions, sea conditions, tidal stage, current direction and velocity, special phenomena and work activities undertaken around the monitoring and works area that may influence the monitoring results.
Monitoring Equipment
3.6. For water quality monitoring, the following equipment were used:
Dissolved Oxygen and Temperature Measuring Equipment - The instrument was a portable, weatherproof dissolved oxygen measuring instrument complete with cable, sensor, comprehensive operation manuals, and was operable from a DC power source. It was capable of measuring: dissolved oxygen levels in the range of 0 - 20 mg/L and 0 - 200% saturation; and a temperature of 0 - 45 degrees Celsius. It has a membrane electrode with automatic temperature compensation complete with a cable of not less than 35 m in length. Sufficient stocks of spare electrodes and cables were available for replacement where necessary (e.g. YSI model 59 DO meter, YSI 5739 probe, YSI 5795A submersible stirrer with reel and cable or an approved similar instrument).
Turbidity Measurement Equipment - The instrument was a portable, weatherproof turbidity-measuring unit complete with cable, sensor and comprehensive operation manuals. The equipment was operated from a DC power source, it has a photoelectric sensor capable of measuring turbidity between 0 - 1000 NTU and complete with a cable with at least 35 m in length (for example Hach 2100P or an approved similar instrument).
Salinity Measurement Instrument - A portable salinometer capable of measuring salinity in the range of 0 - 40 ppt was provided for measuring salinity of the water at each monitoring location.
Water Depth Gauge - A portable, battery-operated echo sounder (for example Seafarer 700 or a similar approved instrument) was used for the determination of water depth at each designated monitoring station. This unit will preferably be affixed to the bottom of the work boat if the same vessel is to be used throughout the monitoring programme. The echo sounder was suitably calibrated.
Positioning Device - A Global Positioning System (GPS) was used during monitoring to allow accurate recording of the position of the monitoring vessel before taking measurements. The Differential GPS, or equivalent instrument, was suitably calibrated at appropriate checkpoint (e.g. Quarry Bay Survey Nail) to verify that the monitoring station is at the correct position before the water quality monitoring commence.
Water Sampling Equipment - A water sampler, consisting of a PVC or glass cylinder of not less than two litres, which can be effectively sealed with cups at both ends, was used. The water sampler has a positive latching system to keep it open and prevent premature closure until released by a messenger when the sampler is at the selected water depth.
Total Residual Chlorine -Total residual chlorine (TRC) shall be measured in-situ using approved test kit.
Sampling / Testing Protocols
3.7. All in situ monitoring instruments were checked, calibrated, and certified by a laboratory accredited under HOKLAS or any other international accreditation scheme before use, and subsequently re-calibrated at monthly intervals throughout the stages of the water quality monitoring. Responses of sensors and electrodes were checked with certified standard solutions before each use.
3.8. On-site calibration of field equipment was following the ¡§Guide to On-Site Test Methods for the Analysis of Waters¡¨, BS 1427: 2009. Sufficient stocks of spare parts were maintained for replacements when necessary. Backup monitoring equipment was made available so that monitoring can proceed uninterrupted even when equipment is under maintenance, calibration etc.
Laboratory Measurement and Analysis
3.9. Sufficient volume of each water sample was collected for carrying out the laboratory analyses. Using chain of custody forms, collected water samples were transferred to a HOKLAS accredited laboratory (Acumen Laboratory and Testing Limit - HOKLAS 241) for immediate processing. The determination work was start within the next working day after collection of the water samples. Analytical methodology and sample preservation of other parameters were based on the latest edition of Standard Methods for the Examination of Waste and Wastewater published by APHA, AWWA and WPCF and methods by USEPA, or suitable method in accordance with requirements of HOKLAS or another internationally accredited scheme. The QA/QC details were in accordance with the requirements of HOKLAS or another internationally accredited scheme.
3.10. Parameters for laboratory measurements, standard methods and detection limits are presented in Table 3.2.
Table 3.2 Laboratory measurements, standard methods, and corresponding detection limits of marine water quality monitoring
Parameters |
Standard Methods |
Detection Limit |
Reporting Limit |
Precision |
Dissolved
oxygen |
Instrumental, CTD |
0.1 |
- |
+-25% |
Temperature |
Instrumental, CTD |
0.1 |
- |
+-25% |
pH |
Instrumental, CTD |
0.1 |
- |
+-25% |
Turbidity |
Instrumental, CTD |
0.1 |
- |
+-25% |
Salinity |
Instrumental, CTD |
0.1 |
- |
+-25% |
Suspended
Solids |
APHA 23rd Ed
2540D |
1.0 |
2.5 |
+-17% |
Iron |
APHA 3111 B |
0.2 |
- |
+-25% |
Total residual chlorine |
Test
Kit (Lovibond MD200) |
Lowest limit
= 0.01mg/L; Upper limit = 6
mg/L |
- |
+-25% |
Monitoring Location
Construction Phase
3.11. The Impact water quality monitoring was ceased from 1 September 2023 due to the completion of marine-related construction works.
Operation phase
3.12. The operation phase impact water quality monitoring locations are in accordance with the EM&A Manual and detailed in Table 3.3 below. A schedule for water quality monitoring was prepared by the ET and submitted to IEC and EPD prior to the commencement of the monitoring.
Table 3.3 Location of Impact Water Quality Monitoring Stations
Station |
Easting |
Northing |
Description |
CE |
843550 |
815243 |
Upstream
control station at ebb tide |
CF |
846843 |
810193 |
Upstream
control station at flood tide |
WSR1 |
846864 |
812014 |
Ecological
sensitive receiver at Tung Lung Chau |
WSR2 |
847645 |
812993 |
Fisheries
sensitive receiver at Tung Lung Chau |
WSR3 |
848023 |
813262 |
Ecological
sensitive receiver at Tung Lung Chau |
WSR4 |
847886 |
814154 |
Ecological
sensitive receiver at Tai Miu
Wan |
WSR16 |
845039 |
815287 |
Ecological
sensitive receiver at Fat Tong Chau |
WSR33 |
847159 |
814488 |
Ecological
sensitive receiver at Tai Miu
Wan |
WSR36 |
846878 |
814081 |
Ecological
sensitive receiver at Kwun Tsai |
WSR37 |
846655 |
813810 |
Ecological
sensitive receiver at Tit Cham Chau |
NF1 |
846542 |
813614 |
Edge of Mixing zone, ~ 200m west of outfall diffuser |
NF2 |
846942 |
813614 |
Edge of Mixing zone, ~ 200m east of outfall diffuser |
NF3 |
846742 |
813414 |
Edge of Mixing zone, ~ 200m south of outfall diffuser |
3.13. WSR1 to WSR37 were identified in accordance with Annex 14 of the EIAO-TM as well as Clause 3.4.4.2 of the Environmental Impact Assessment Study Brief for Desalination Plant at Tseung Kwan O (No. ESB-266/2013). WSR1 to WSR3 are sited near the Tung Lung Chau Fish Culture Zone; WSR16 and WSR36 are sited near the coral assemblages along the coastlines of Fat Tong Chau and Kwun Tsai respectively; WSR 4 and WSR33 are sited near the Coastal Protection Area and coral assemblages in waters of Tai Miu Wan; WSR37 is sited near the fisheries resource including spawning and nursery grounds at the coastal water of Tit Cham Chau. NF1 to NF3 are the Edge of Mixing zone.
Figure 3.1 Impact water quality monitoring locations under EM&A Manual
Sampling Frequency
Operation phase
3.14. Impact water quality monitoring were carried out three days per week during the commission phase. Monitoring at each station was undertaken once per day. The interval between two sets of monitoring was not less than 36 hours. The monitoring frequency would be increased in the case of exceedances of Action/Limit Levels if considered necessary by ET. Monitoring frequency would be maintained as far as practicable.
Sampling Depths & Replication
3.15. During impact water quality monitoring, each station was sampled, and measurements/ water samples were taken at three depths, 1 m below the sea surface, mid-depth, and 1 m above the seabed. For in situ measurements, duplicate readings were made at each water depth at each station. Duplicate water samples were collected at each water depth at each station.
Action and Limit Levels
Operation phase
3.16. The Action and Limit Levels have been set based on the derivation criteria specified in the EM&A Manual. The Action/Limit Levels have been derived and are presented in Table 3.4.
Table 3.4 Derived Action and Limit Levels for Water Quality
Parameters |
Action |
Limit |
Operation phase Impact
Monitoring |
||
DO
in mg/L |
Surface and Middle 7.30 mg L-1 Bottom 7.31 mg L-1 Tung Lung Chau Fish
Culture Zone 5.1
mgL-1 or
level at control station (Whichever the lower) |
Surface and Middle 4
mg L-1 Bottom 2 mg L-1 Tung Lung Chau Fish
Culture Zone 5.0 mgL-1 or level at control station (Whichever the lower) |
SS in mg/L
(Depth- averaged) |
5.00 mg
L-1 or 20% exceedance of value at any impact station compared with
corresponding data from
control station |
6.00 mg L-1 or 30% exceedance of value at any
impact station compared with corresponding data from control station |
Turbidity in NTU (Depth- averaged) |
2.41 NTU or 20% exceedance of value
at any impact station compared with corresponding data from control station |
2.84 NTU or 30% exceedance of value
at any impact station compared with corresponding data from control station |
Salinity in PSU (Depth- averaged) |
34.25 PSU or 9% exceedance of value
at any impact station compared with corresponding data from control station |
34.56 PSU or 10% exceedance of value
at any impact station compared with corresponding data from control station |
Iron in mg/L
(Depth- averaged) |
0.3 mg/L |
0.3 mg/L |
Total residual chlorine in mg/L |
0.01 mg/L |
0.01 mg/L |
Notes:
i.
"Depth-averaged" is calculated by taking the arithmetic means
of reading of all three
depths.
ii. For DO, non-compliance of the water
quality limits occurs
when monitoring result is lower than the limits.
iii. For Turbidity, SS,
iron and Salinity, non-compliance of the water quality limits occurs when
monitoring result is higher than the
limits.
iv. Monitoring of Total Residual
Chlorine (Disinfection) will be conducted
when cleaning and sterilization of the new freshwater
main is carried out.
Monitoring Results and Observations
Construction Phase
3.17. Referring to EM&A Manual, the general water quality monitoring should be carried out when there are marine-related construction activities undertaken. General water quality monitoring at the ten monitoring stations (CE, CF, WSR1, WSR2, WSR3, WSR4, WSR16, WSR33, WSR36 and WSR37) was ceased from 1 September 2023 due to the completion of marine-related construction works.
Operation phase
3.18. According to the contractor¡¦s information, the operation phase of TKODP commenced on
1 July 2024. Details of the operation phase marine water quality monitoring and continuous monitoring of effluent quality will be presented in the Operation Monthly EM&A Report.
4.1. The waste generated from this Contract includes inert construction and demolition (C&D) materials, and non-inert C&D materials. Non-inert C&D materials are made up of general refuse, vegetative wastes and recyclable wastes such as plastics and paper/cardboard packaging waste. Steel materials generated from the Contract are also grouped into non-inert C&D materials as the materials were not disposed of with other inert C&D materials. With reference to relevant handling records and trip tickets of this Contract, the quantities of different types of waste generated in the reporting month are summarized in Table 4.1. Details of cumulative waste management data are presented as a waste flow table in Appendix G.
Table 4.1 Quantities of Waste Generated from the Contract during the reporting period
Reporting Month |
Actual Quantities of Inert C&D Materials Generated Monthly |
Actual Quantities of C&D Wastes
Generated Monthly |
|||||||||
Total Quantity Generated |
Hard Rock and Large Broken Concrete |
Reused in the Contract |
Reused in other
Projects |
Disposed as Public Fill |
Imported
Fill |
Metals |
Paper / cardboard
packaging |
Plastics (1) |
Chemical
Waste |
Others, e.g., general refuse |
|
(in ¡¦000kg) |
(in ¡¦000kg) |
(in ¡¦000kg) |
(in ¡¦000kg) |
(in ¡¦000kg) |
(in ¡¦000kg) |
(in ¡¦000kg) |
(in ¡¦000kg) |
(in ¡¦000kg) |
(in ¡¦000kg) |
(in ¡¦000kg) |
|
Oct 2024 |
78.140 |
0.000 |
0.000 |
0.000 |
78.140 |
0.000 |
0.000 |
0.000 |
0.000 |
0.000 |
71.810 |
Notes: (1) Plastics
refer to plastic
bottles / containers, plastic sheets / foam from packaging material
Monitoring Requirement
5.1. In accordance with Section 11 of the EM&A Manual, monitoring of landfill gas is required for construction works within the 250m Consultation Zone. Part of the desalination plant and the indicative area of natural slope mitigation works fall within the SENT Landfill Extension Consultation Zone; and part of the 1,200 mm diameter fresh water mains along Wan Po Road falls within the SENT Landfill and SENT Landfill Extension Consultation Zones, TKO Stage II/III Restored Landfill and TKO Stage I Restored Landfill Consultation Zones.
Monitoring Programme
5.2. Since part of the desalination plant (Wan Po Road and MIC compound/Basketball Court) and the indicative area of natural slope mitigation works fall within the SENT Landfill Extension Consultation Zone in this contract (Figure 5.1), landfill gas monitoring would be required for Wan Po Road and MIC compound/Basketball Court (Figure 5.2) if excavations were conducted at more than 300mm deep. Although SENT Landfill Extension has commenced operation since November 2021, no excavation works were conducted at MIC compound/Basketball Court. Hence no landfill gas monitoring would be scheduled for MIC compound/Basketball Court at the current stage.
Monitoring Location
5.3. Monitoring of oxygen, methane, carbon dioxide and barometric pressure would be performed for excavations at 1m depth or more within the consultation Zone.
5.4. During construction of works within the consultation zones, excavations of 1m depth or more was monitored:
- At the ground surface before excavation commences;
- Immediately before any worker enters the excavation;
- At the beginning of each working day for the entire period the excavation remains open; and
- Periodically through the working day whilst workers are in the excavation.
5.5. For excavations between 300mm and 1m deep, measurements were carried out:
- Directly after the excavation has been completed; and
- Periodically whilst the excavation remains open.
5.6. The area required to be monitored for landfill gas in the reporting period is shown in Figure 5.1.
Figure 5.1 Overview of the SENT Extension Consultation Zone and the Contract Site Area
MONITORING PARAMETERS
5.7. The landfill gas monitoring parameters and the action and limit level are summarized in Table 5.1.
Table 5.1 Action and Limit Level
for Landfill Gas Monitoring Equipment
Parameters |
Action Level |
Limit Level |
Oxygen (O2) |
<19% O2 |
<19% O2 |
Methane (CH4) |
>10%
LEL |
>20%
LEL |
Carbon Dioxide (CO2) |
>0.5% CO2 |
>1.5% CO2 |
MONITORING EQUIPMENT
5.8. Landfill Gas monitoring was carried out using intrinsically-safe, portable multi-gas monitoring instruments. The gas monitoring equipment is:
- Complying with the Landfill Gas Hazard Assessment Guidance Note as intrinsically safe;
- Capable of continuous barometric pressure and gas pressure measurements;
- Normally operated in diffusion mode unless required for spot sampling, when it should be capable of operating by means of an aspirator or pump;
- Having low battery, fault and over range indication incorporated;
- Capable of storing monitoring data, and shall be capable of being downloaded directly;
- Measure in the following ranges:
methane |
0-100% Lower Explosion Limit (LEL) and 0-100% v/v; |
oxygen |
0-25% V/V; |
carbon dioxide |
0-5% v/v; and |
barometric pressure |
mBar (absolute) |
- alarm (both audibly
