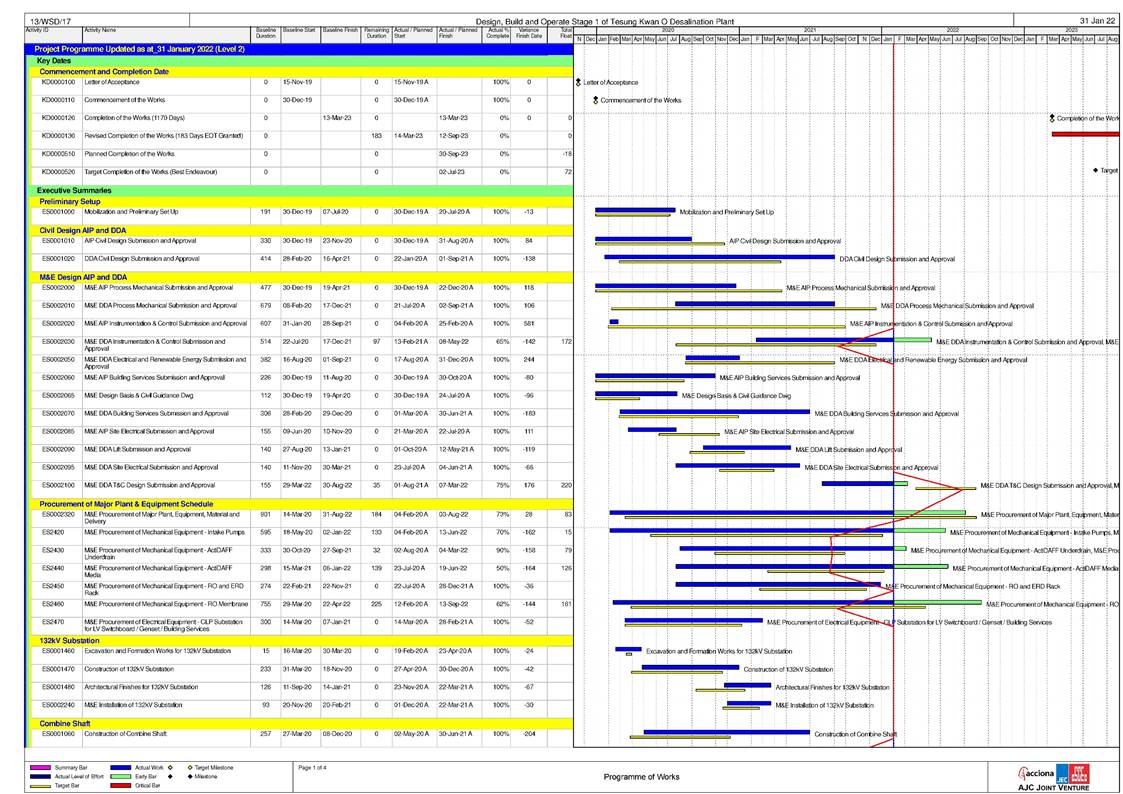

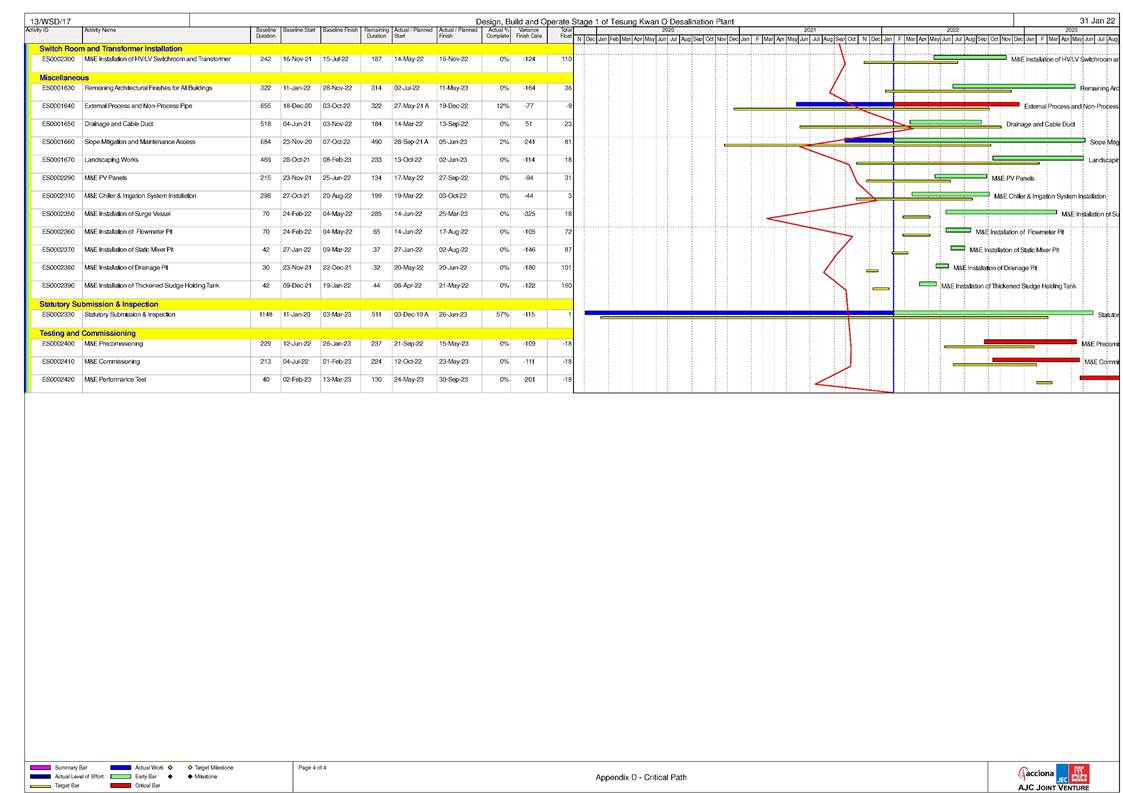

Appendix A Master Programme
Appendix B Overview of Desalination Plant in Tseung Kwan O
Appendix C Summary of Implementation Status of Environmental Mitigation
Appendix D Water Quality Monitoring Graphical Presentation
Appendix E Summary of Exceedances

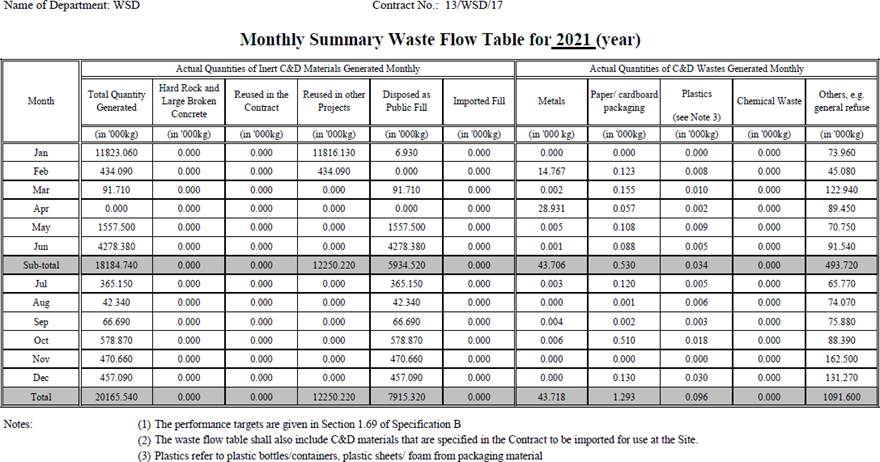

Appendix F Waste Flow Table
Appendix G Complaint Log

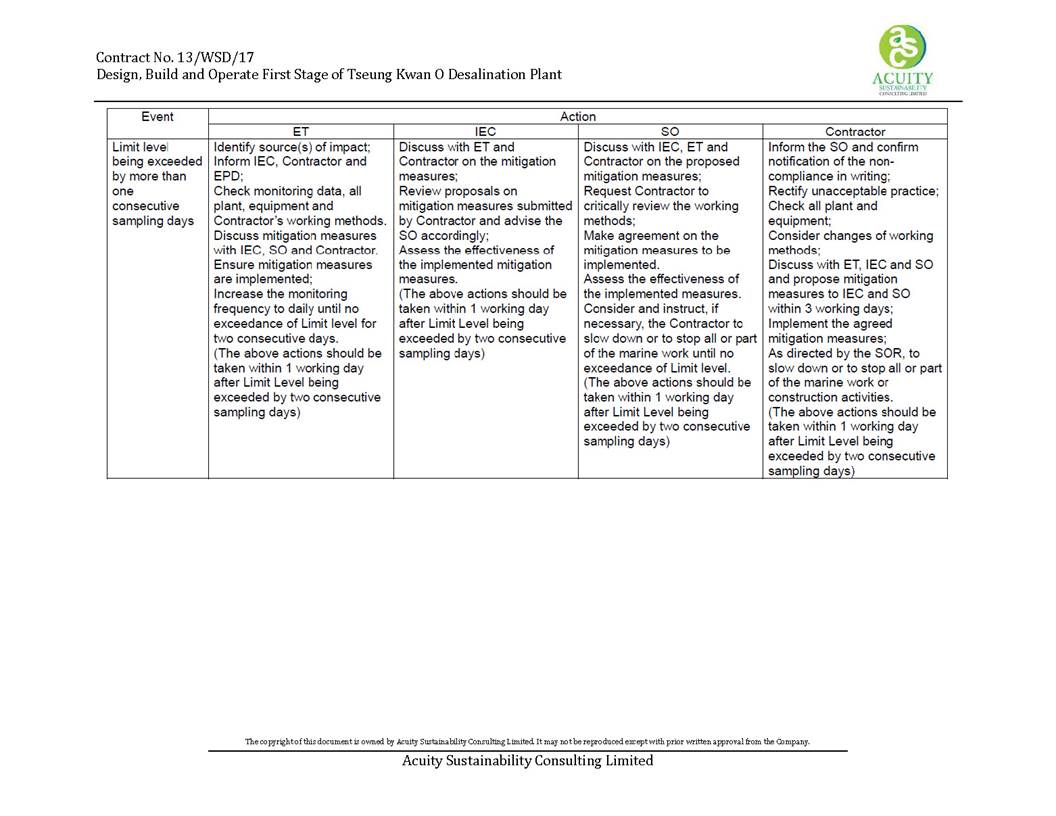

Appendix H Event/Action Plan for Water Quality Monitoring

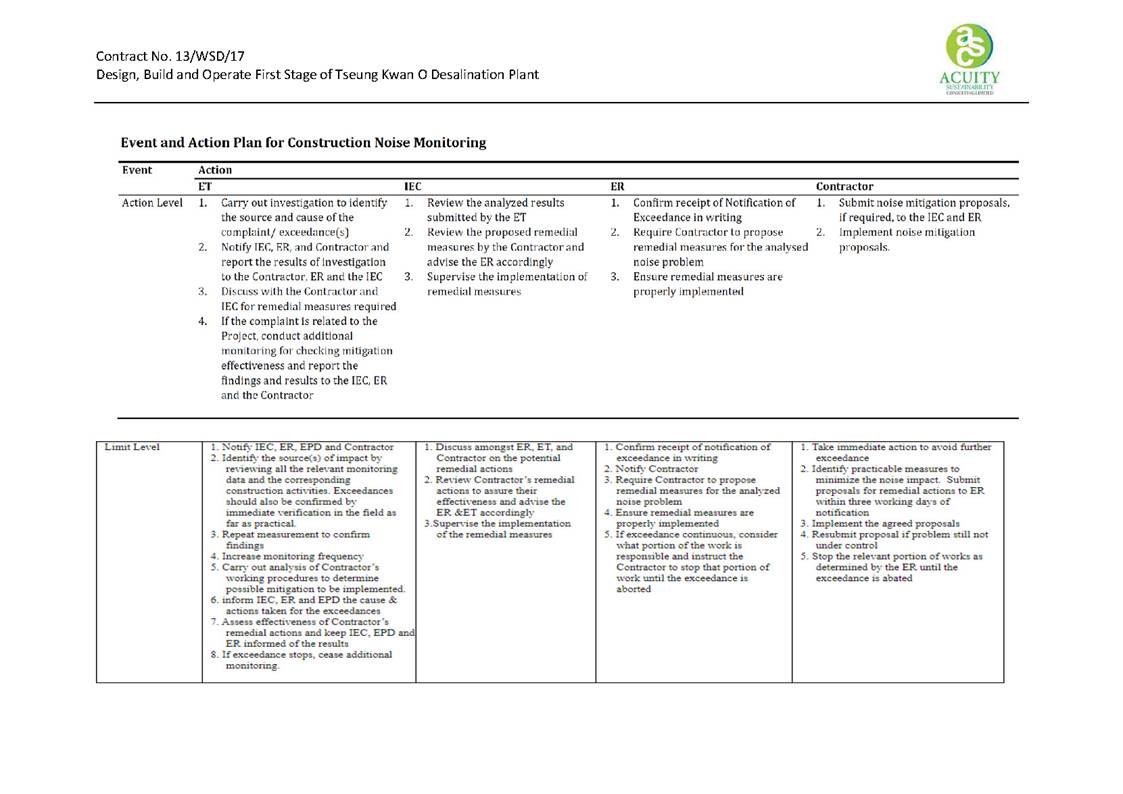

Appendix I Event/Action Plan for Construction Noise Exceedance
INTRODUCTION
A1. The Project, Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (TKODP), is a Designated Project under the Environmental Impact Assessment Ordinance (Cap. 499) (EIAO) and is currently governed by a Further Environmental Permit (EP No. FEP- 01/503/2015/A) for the construction and operation of the Contract.
A2. In accordance with the Environmental Monitoring and Audit (EM&A) Manual for the Contract, EM&A works for marine water quality, noise, waste management and ecology should be carried out by Environmental Team (ET), Acuity Sustainability Consulting Limited (ASCL), during the construction phase of the Contract.
A3. This is the 8th Quarterly EM&A Report, prepared by ASCL, for the Contract summarizing the monitoring results and audit findings of the EM&A programme at and around Tseung Kwan O Area 137 (TKO 137) during the reporting period from 1 December 2021 to 28 February 2022.
A4. The EM&A programme for this contract has covered environmental monitoring on construction noise level at selected NSRs and Contractor¡¦s environmental performance auditing in the aspects of construction dust, construction noise, water quality, waste management, Landscape and Visual and Ecology.
SUMMARY OF MAIN WORKS UNDERTAKEN & KEY MITIGATION MEASURES IMPLEMENTED
A5. Key activities carried out in this reporting period for the Project included the followings:
- Land Survey;
- Construction of ActiDAFF Roof Slab;
- Construction of Reverse Osmosis (RO) Building - staircases; water tank; Electrical Building roof and internal finishing works;
- Construction of Product Water Storage Tank (PWST) perimeter wall and Electrical Building¡¦s roof slab;
- Construction of sludge thickener, Post Treatment Building (PTB);
- Construction of On-Site Chlorine Generation Building (OSCG Bldg);
- Manhole construction and Glass Reinforced Plastic (GRP) pipe installation;
- Commence construction of manholes no. 8 and no. 9 adjacent to PWST;
- Construction of manholes no.15 and no.16 adjacent to ActiDAFF and RO;
- Construction of 1/F to 2/F walls and columns of Administration Building
- Construction of Post Treatment Building 1/F;
- Construction of first floor columns and walls of Administration Building;
- Construction of structural wall and Roof of Chemical Building;
- Construction of reinforced concrete (R.C) footing and support of Inspection Corridor;
- Internal finishing work in Product Water Storage Tank (PWST), Main Electrical & Central Chiller Plant Building;
- Outfall Shaft ‐ dewatering; rock cutting and excavation works;
- Outfall Shaft - works inside the caisson to check and grout/welding water leaking spots;
- Outfall Shaft - welding works of working platform atop the caisson;
- Outfall Shaft - material lifting for rock coring and pumping clean seepage water within silt curtain area;
- Intake tunnel - Demobilize the pipe jacking system and commencement of grouting works;
- Excavation & Lateral Support (ELS) erection and marine dredging commencement and disposal at Intake Shaft;
- Installation of brackets and welding works of the waling at Intake Shaft;
- Pipe jacking at Combined Shaft for Intake & Outfall pipelines;
- Cable drawpit construction;
- Glass Reinforced Plastic (GRP) pipe lamination and laying;
- Construction of 1st floor structural wall of Chemical Building;
- Wan Po Road Sewage Rising Main Works - Temporary Traffic Arrangement (TTA), excavation and laying High-Density Polyethylene (HDPE) pipe;
- Construction of On-Site Chlorine Generation (OSCG) Building footing and roof floor;
- Construction of base slab of Pump house;
- Dismantling of tower crane TC03;
- Construction of carbon dioxide (CO2) tank footing
- E&M works - ActiDAFF - scaffolding, installation of E&M piping; and
- E&M works - Reverse Osmosis (RO) Building - Fire services installation;
A6. The major environmental impacts brought by the above construction works include:
- Construction dust and noise generation from marine construction works, excavation works, ELS installation works, breaking of concrete surface and construction works; rock cutting works and pipe piling driving works
- Waste generation from the construction activities
- Impact on water quality from marine construction works and inland construction works
A7. The key environmental mitigation measures implemented for the Project in this reporting period associated with the above construction works include:
- Dust suppression by regular wetting and water spraying for construction works
- Reduction of noise from equipment and machinery on-site and regularly inspection to machinery and plants/vehicles on-site to ensure proper functioning
- Sorting and storage of general refuse and construction waste
- Deployment of temporary silt curtain in the area where marine construction works were conducted and deployment of water sedimentation tanks for treatment of wastewater at inland areas before discharge
SUMMARY OF EXCEEDANCE & INVESTIGATION & FOLLOW-UP
A8. No noise monitoring was conducted during the reporting period since there are no project- related construction activities undertaken within a radius of 300m from the monitoring locations. No exceedance of the Action Level was recorded during the reporting period.
A9. The EM&A works for water quality were conducted during the reporting period in accordance with the EM&A Manual.

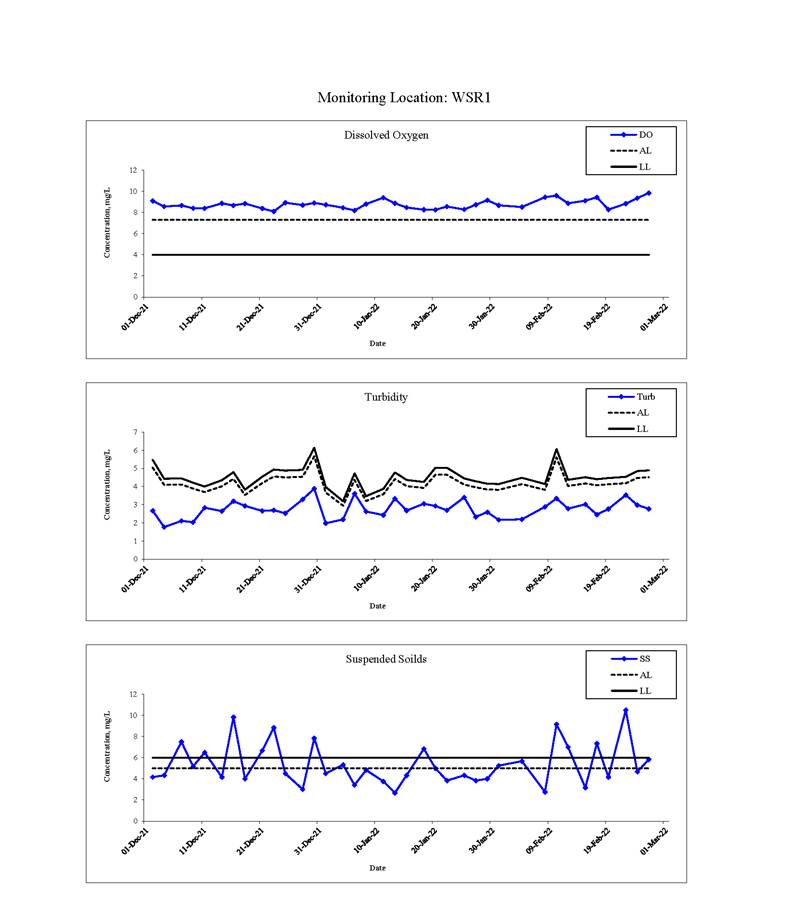

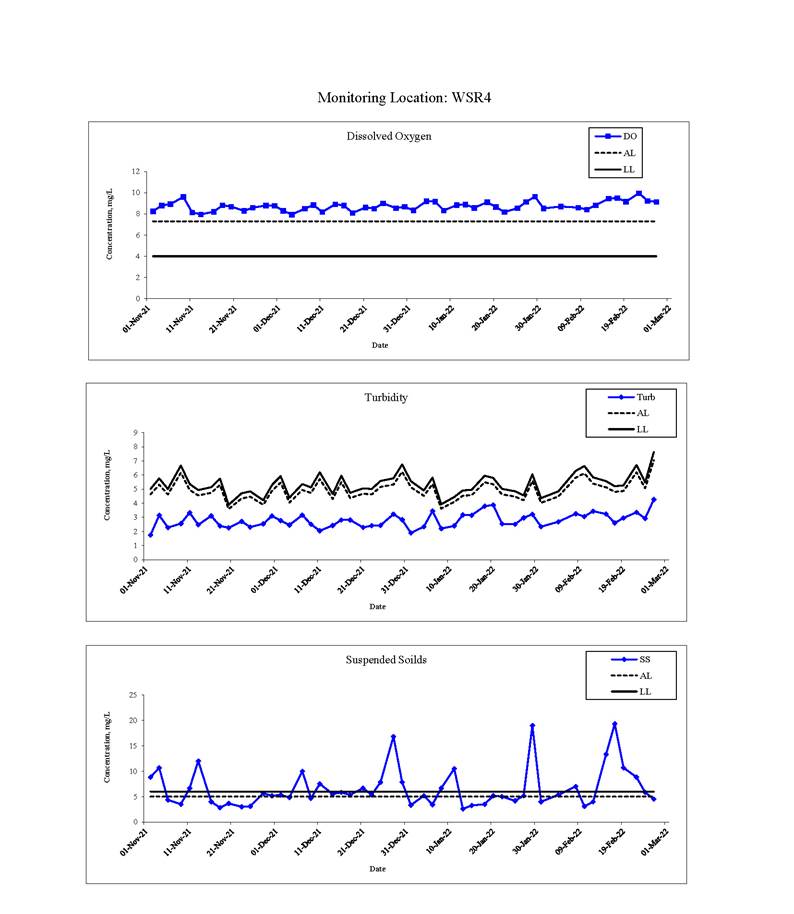

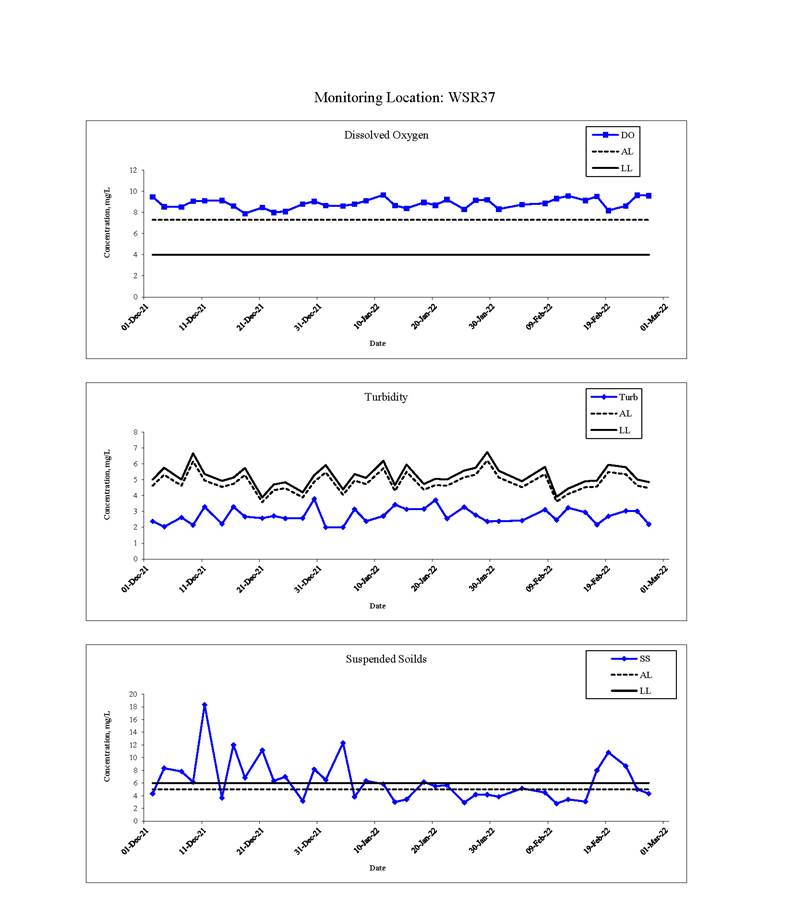

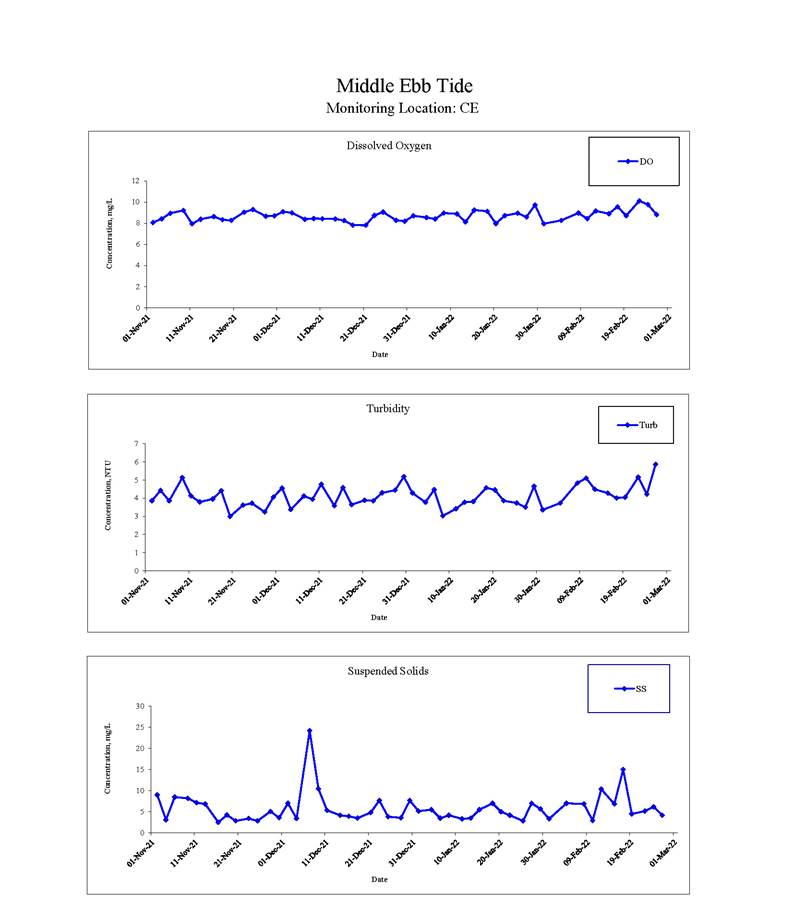

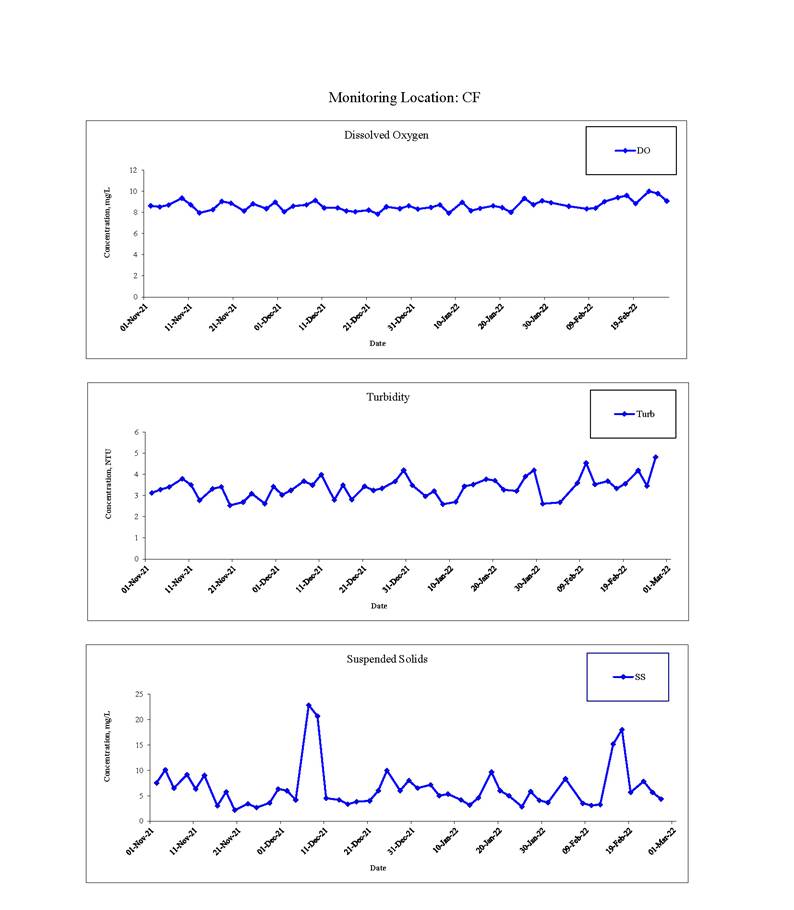

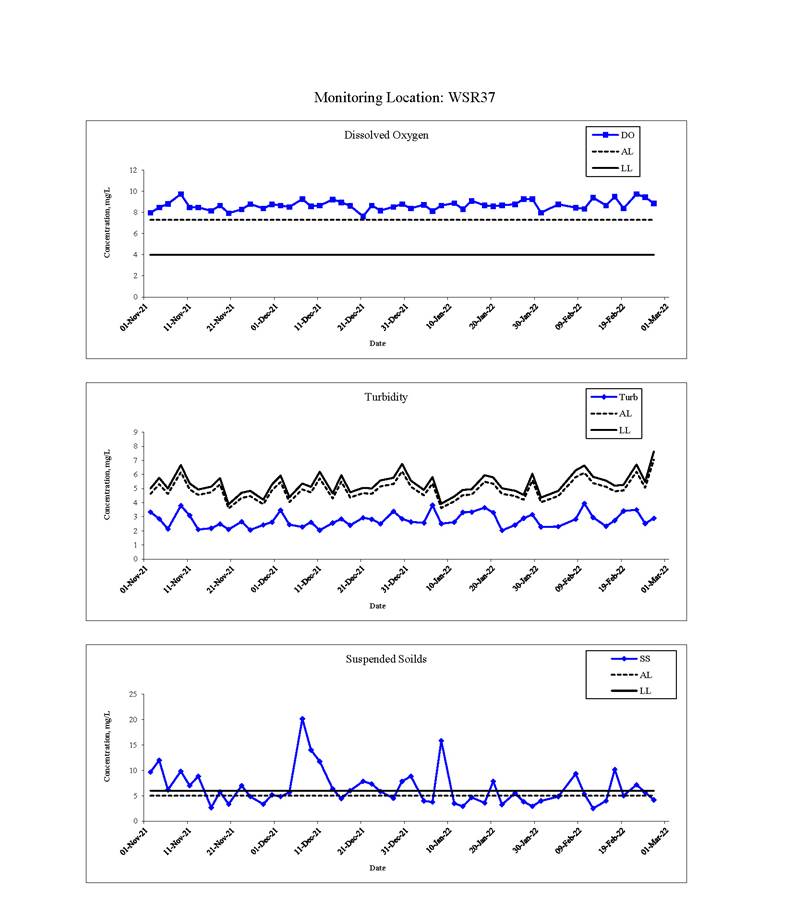

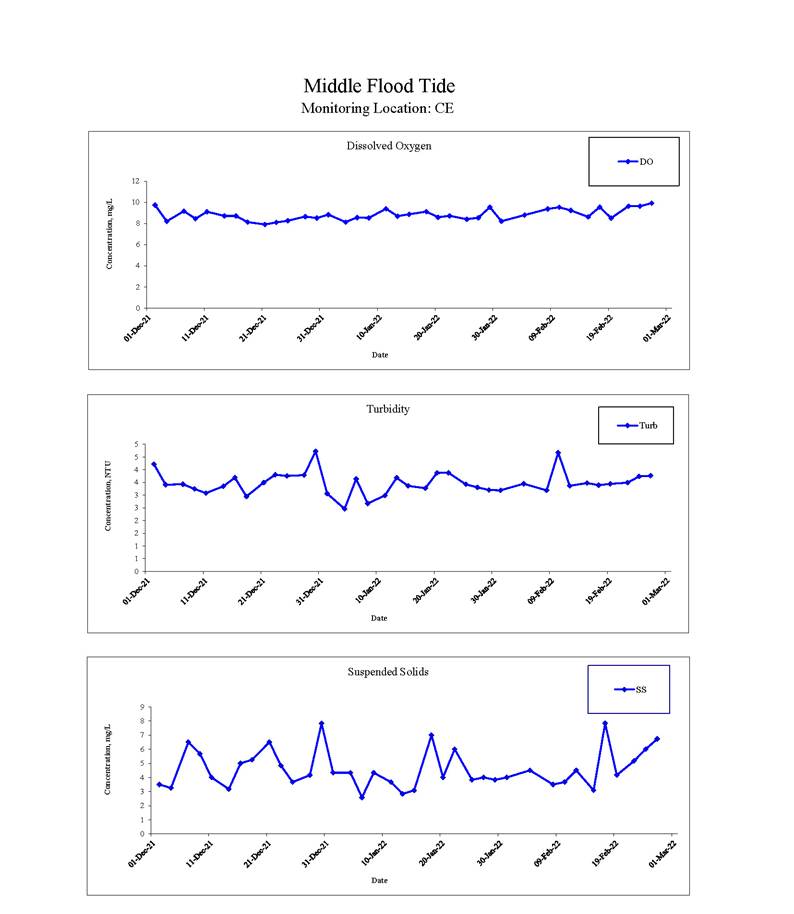

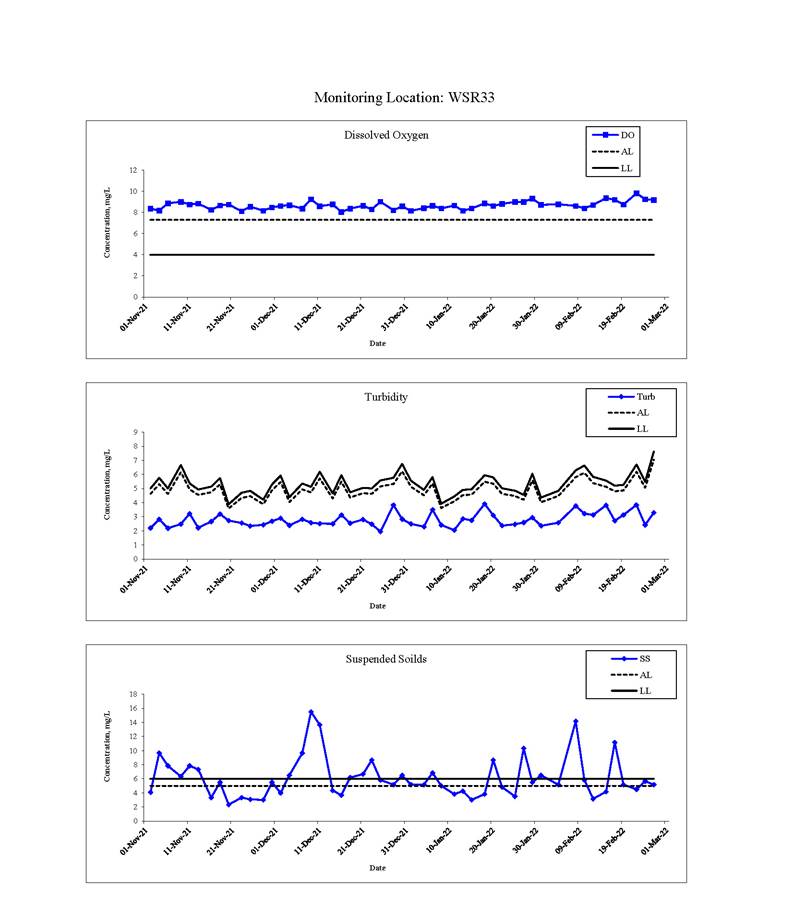

A10. Water quality monitoring was conducted as schedule in the reporting period. One hundred and ninety-three (193) action level exceedances and One hundred and thirty-two (132) limit level exceedances for suspended solids (SS) of impact water quality monitoring were recorded.
A11. In this reporting period, 66 times of landfill gas monitoring were recorded at Wan Po Road (Ch1+360 - Ch1+513). No action and limit level exceedance for methane, oxygen and carbon dioxide was recorded. Monitoring was conducted during excavations at 1m depth or more within the consultation zone and whenever workers entered the excavation on the day.
A12. Weekly site inspections of the construction works were also carried out by ET to audit the mitigation measures implementation status. 13 times of weekly Joint site inspections were carried out by ET and IEC.
A13. A summary of the EM&A activities in this reporting period is listed in Table I and summary of the environmental exceedance of the reporting period is tabulated in Table II.
EM&A Activities |
December 2021 |
January 2022 |
February 2022 |
Noise Monitoring |
N/A |
N/A |
N/A |

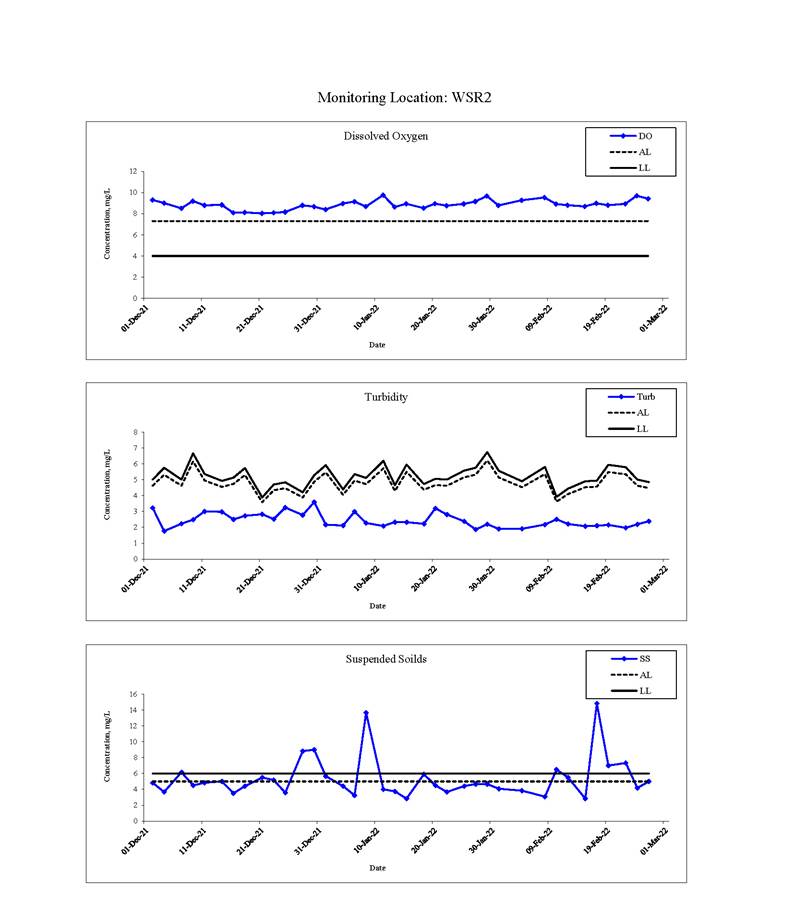

Water Quality Monitoring |

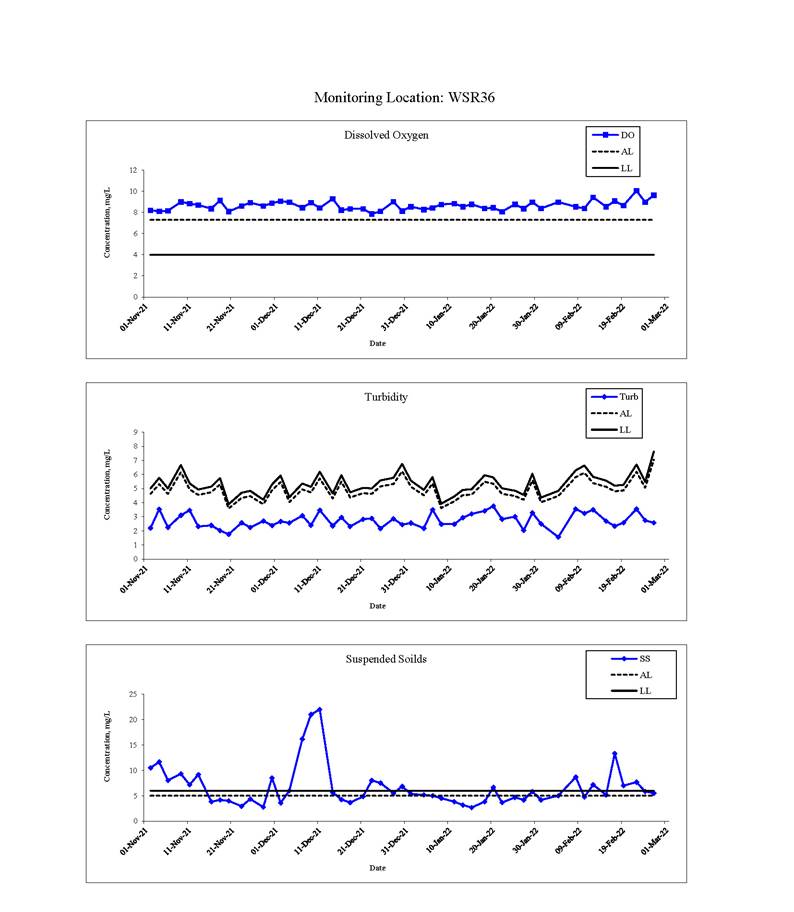

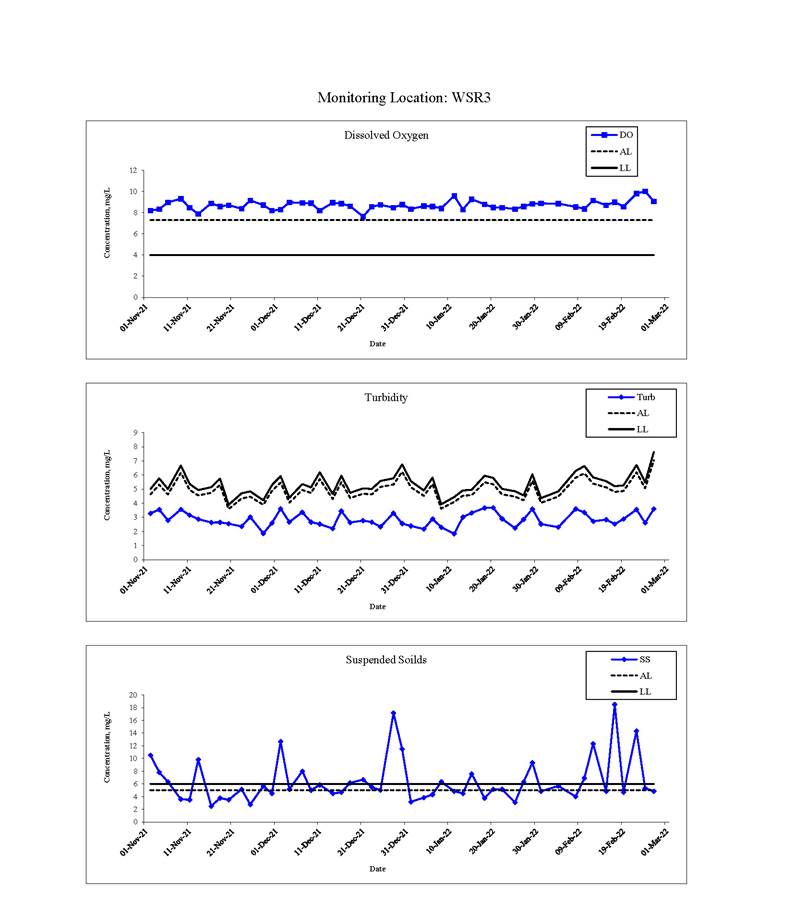

2, 4, 7, 9, 11, 14, 16, 18, 21, 23, 25, 28 and 30 Dec 2021 |
1, 4, 6, 8, 11, 13, 15, 18 ,20, 22, 25, 27, 29 and 31 Jan2022 |
4, 8, 10, 12, 15, 17, 19, 22, 24 and 26 Feb 2022. |
Landfill Gas monitoring |
31 Dec 2021 |
1, 4, 5, 6, 7, 8, 10, 11, 12, 13, 14, 15, 17, 18, 19, 20, 21, 22, 24, 25, 26, 27, 28, 29 and 31 Jan 2022 |
8, 9, 10, 11, 12, 14, 15, 16 and 17 Feb 2022 |
Environmental Site Inspection |
7, 15, 22 and 31 Dec 2021 |
4, 11, 18, 26 and 31 Jan 2022 |
8, 17, 23 and 28 Feb 2022 |
Table II Summary Table
for Exceedance in the Reporting Period
Environmental Monitoring |
Parameter |
No of non- Project related exceedance |
Total
No. of non-Project related exceedance |
No of Project
related exceedance |
Total No. of
Project related exceedance |
||
AL |
LL |
AL |
LL |
||||
Noise |
Leq (30min) |
N/A |
N/A |
N/A |
N/A |
N/A |
N/A |
Water |
DO |
0 |
0 |
0 |
0 |
0 |
0 |
Turbidity |
0 |
0 |
0 |
0 |
0 |
0 |
|
SS |
193 |
132 |
325 |
0 |
0 |
0 |
|
pH |
0 |
0 |
0 |
0 |
0 |
0 |
|
Salinity |
0 |
0 |
0 |
0 |
0 |
0 |
|
Landfill Gas |
O2 |
0 |
0 |
0 |
0 |
0 |
0 |
CH4 |
0 |
0 |
0 |
0 |
0 |
0 |
|
CO2 |
0 |
0 |
0 |
0 |
0 |
0 |
COMPLAINT HANDLING AND PROSECUTION
A14. No environmental complaint was received during the reporting period.
A15. Neither notifications of summons nor prosecution was received for the Project.
REPORTING CHANGE
A16. There was no change to be reported that may affect the on-going EM&A programme.
1.1. BACKGROUND
The Acciona Agua, S.A. Trading, Jardine Engineering Corporation Limited and China State Construction Engineering (Hong Kong) Limited and as AJC Joint Venture (AJCJV) is contracted to carry out the Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (DPTKO) under Contract No. 13/WSD/17 (the Contract).
Acuity Sustainability Consulting Limited (ASCL) is commissioned by AJCJV to undertake the Environmental Team (ET) services as required and/or implied, both explicitly and implicitly, in the Environmental Permit (EP), Environmental Impact Assessment Report (EIA Report) (Register No. AEIAR-192/2015) and Environmental Monitoring and Audit Manual (EM&A Manual) for the Contract; and to carry out the Environmental Monitoring and Audit (EM&A) programme in fulfillment of the EIA Report¡¦s EM&A requirements and Contract No. 13/WSD/17 Specification requirements.
Pursuant to the Environmental Impact Assessment Ordinance (EIAO), the Director of Environmental Protection granted the Environmental Permit (No. EP-01/503/2015) and Variation of Environmental Permit (No. EP-01/503/2015/A) to Water Supplies Department (WSD); and granted the Further Environmental Permit (No. FEP-01/503/2015/A) to AJCJV for the Contract.
1.2. THE REPORTING SCOPE
This is the 8th Quarterly EM&A Report for the Project which summarizes the key findings of the EM&A programme during the reporting period from 1 December 2021 to 28 February 2022.
1.3. PROJECT ORGANIZATION-

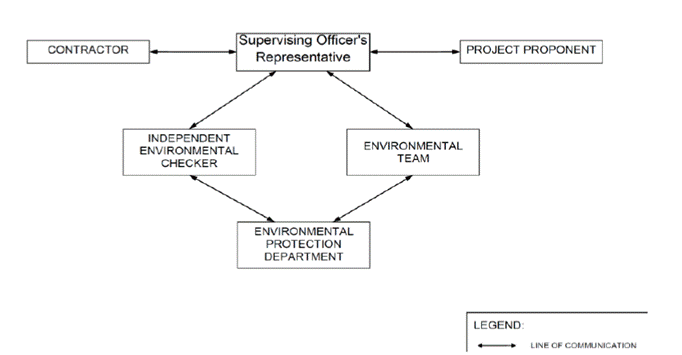

The Project Organization structure for Construction Phase is presented in Figure 1.1.
Contact details of the key personnel are presented in Table 1.1 below:
Party |
Position |
Name |
Telephone no. |
Project Proponent |
SE/CM2 |
Benny Lam |
2634-3573 |
Supervising
Officer (Binnies Hong Kong
Limited) |
Project Manager |
Christina Ko |
2608-7302 |
Chief Resident Engineer |
Roger Wu |
6343-1002 |
|
The Jardine
Engineering Corporation, Limited, China State Construction Engineering (Hong
Kong) Limited and Acciona Agua, S.A. Trading |
Project Manager |
Stephen Yeung |
2807-4665 |
Environmental Monitoring Manager |
Brian
Kam |
9456-9541 |
|
Acuity
Sustainability Consulting Limited |
Environmental Team Leader |
Jacky
Leung |
2698-6833 |
ANewR
Consulting Limited |
Independent Environmental Checker (IEC) |
Louis
Kwan |
2618-2831 |
1.4. SUMMARY OF CONSTRUCTION WORKS
Details of the major construction activities undertaken in this reporting period are shown as below. The construction programme is presented in Appendix A.
Key activities carried out in this reporting period for the Project included the following:
- Land Survey;
- Construction of ActiDAFF parapet and solar panel supports at roof
- Construction of Reverse Osmosis (RO) Building - staircases and internal finishing;
- Construction of Sludge tank, sludge thickener and Post treatment building (PTB);
- Construction of On-Site Chlorine Generation (OSCG) Building and carbon dioxide (CO2) tank area;
- Internal finishing works at Product Water Storage Tank (PWST) and Main Electrical & Central Chiller Plant Building
- Construction of manhole and Glass Reinforced Plastic (GRP) pipe installation;
- Commence construction of Manholes no.15 and no.16 adjacent to ActiDAFF and Reverse Osmosis Area (RO);
- Construction of first and second floor walls and columns of Administration Building;
- Construction of reinforced concrete (RC) support of Inspection Corridor;
- Construction of floor structural wall and roof of Chemical Building;
- Dewatering, predrill, rock cutting and excavations at Outfall Shaft;
- Excavation & Lateral Support (ELS) erection and commencement of marine dredging and disposal at Intake Shaft;
- Retrieval of DN 2500 Tunnel Boring Machine (TBM) underwater at Intake Shaft;
- Demobilize the pipe jacking system and commencement of grouting works at Intake Shaft;
- Concrete blinding laying and backfill with aggregate at Intake Shaft;
- Pipe jacking works at Combined Shaft for Intake & Outfall pipelines;
- Construction of base slab of Pump house
- E&M works - ActiDAFF - scaffolding, installation of E&M piping;
- E&M works - RO- Fire services installation;
- E&M works - CO2 tank area - installation of Silos; and
- E&M works - Chiller Building - installation of chillers;
1.5.
SUMMARY OF ENVIRONMENTAL STATUS
A summary of the valid permits, licences, and /or notifications on environmental protection for this Project is presented in Table 1.2.
Table 1.2 Summary
of the Status of Valid Environmental Licence,
Notification, Permit and Documentations
Permit/ Licenses/ Notification |
Reference |
Validity Period |
Environmental Permit |
FEP - 01/503/2015/A |
Throughout the Contract |
Notification of Construction Works under the Air Pollution Control (Construction Dust) Regulation (Form NA) |
Ref. No.: 451539 |
- |
Wastewater Discharge Licence (Land and Marine works) |
WT00035775-2020 |
24/07/2020 -31/07/2025 |
Chemical Waste Producer Registration |
5213-839-A2987-01 |
Throughout the Contract |
Billing Account for Disposal of Construction Waste |
7036276 |
Throughout the Contract |
Construction Noise Permit (24 hours) - CNP for general works, TBM at Combined Shaft and marine works |
GW-RE1041-21 |
01/11/2021 - 30/04/2022 |
Vessel CHITs for fill disposal |
7039300 |
20/01/2022 - 20/04/2022 |
Dumping at Sea Ordinance (DASO) Permit (Category L) |
EP/MD/22‐028 |
02/08/2021 - 01/02/2022 |
Dumping at Sea Ordinance (DASO) Permit (Category M) |
EP/MD/22-083 |
03/12/2021 - 02/01/2022 |
The status for all environmental aspects is presented in Table 1.3.
Parameters |
Status |
Water Quality |
|
Baseline Monitoring under EM&A Manual |
The baseline water quality monitoring was conducted between 12 May 2020 and 6 June 2020 |
Impact Monitoring |
On-going |
Noise |
|
Baseline Monitoring |
The baseline noise monitoring result has been reported in Baseline Monitoring Report and submitted to EPD under EP Condition 3.4 |
Impact Monitoring |
On-going |
Waste Management |
|
Mitigation Measures in Waste Management Plan |
On-going |
Landfill Gas |
|
Regular Monitoring when Construction Works are within the 250m Consultation Zone |
In this reporting period, 66 times of landfill gas monitoring were recorded at Wan Po Road (Ch1+360 - Ch1+513). No exceedance of action and limit level for methane, oxygen and carbon dioxide was observed. Monitoring was conducted during excavations at 1m depth or more within the consultation zone and whenever workers entered the excavation on the day. |
Environmental Audit |
|
Site Inspection covering Measures of Air Quality, Noise Impact, Water Quality, Waste, Ecological Quality, Fisheries, Landscape and Visual |
On-going |
Other than the EM&A work by ET, environmental briefings, trainings and regular environmental management meetings were conducted, in order to enhance environmental awareness and closely monitor the environmental performance of the contractors.
The EM&A programme has been implemented in accordance with the recommendations presented in the approved EIA Report and the EM&A Manual. A summary of implementation status of the environmental mitigation measures for the construction phase of the Project during the reporting period is provided in Appendix C.
2.1. MONITORING REQUIREMENTS
To ensure no adverse noise impact, construction noise monitoring is recommended to be carried out within 300m radius from the nearby noise sensitive receivers (NSRs), during construction phase. The NSRs selected as monitoring station are (i) NSR4 - Creative Secondary School, (ii) NSR24 - PLK Laws Foundation College, and (iii) NSR31 - School of Continuing and Professional Studies - CUHK respectively.
No impact construction noise monitoring was conducted in the reporting period due to the overly distant monitoring station from the works location, where they were farther than 1 km from the closet monitoring station NSR4 to the works location.
2.2. MONITORING PARAMETERS, FREQUENCY AND DURATION
Construction noise level would be measured in terms of the A-weighted equivalent continuous sound pressure level (LAeq). Leq 30min was used as the monitoring parameter for the time period between 0700 and 1900 on normal weekdays. Table 2.1 summarizes the monitoring parameters, frequency and duration of the impact noise monitoring.
Time |
Duration |
Interval |
Parameters |
Daytime: 0700-1900 |
Day time: 0700-1900 (during normal weekdays) |
Continuously in Leq 5min/Leq 30min (average of 6 consecutive Leq 5min) |
Leq 30min L10 30min & L90 30min |
2.3. MONITORING LOCATIONS
The monitoring locations should normally be made at a point 1m from the exterior of the NSRs building façade and be at a position 1.2m above the ground. A correction of +3dB(A) should be made to the free-field measurements.
According to the environmental findings detailed in the EIA report and Baseline Monitoring Report, the designated locations for the construction noise monitoring are listed in Table 2.2 below.
NSR ID |
Noise Sensitive Receivers |
Monitoring Location |
Position |
NSR 4 |
Creative Secondary School |
Roof Floor |
1 m from facade |
NSR 24 |
PLK Laws Foundation College |
Pedestrian Road
on Ground Floor |
Free-field |
NSR 31 |
School of Continuing and Professional
Studies - CUHK |
Roof Floor |
1 m from facade |
The monitoring locations should normally be made at a point 1m from the exterior of the NSRs building façade and be at a position 1.2m above the ground. A correction of +3dB(A) should be made to the free-field measurements. Three noise monitoring locations for impact monitoring at the nearby sensitive receivers are shown in Figure 2.1-2.3.
|
Figure 2.1 NSR4
Creative Secondary School |
|
Figure 2.2
NSR24 PLK Laws
Foundation College |
|
Figure 2.3 NSR31
School of Continuing and Professional Studies - CUHK |
2.4.
ACTION
AND LIMIT LEVELS
The Action/Limit Levels are in line with the criteria of Practice Note for Professional Persons (ProPECC PN 2/93) ¡§Noise from Construction Activities - Non-statutory Controls¡¨ and Technical Memorandum on Environmental Impact Assessment Process issued by HKSAR Environmental Protection Department [¡§EPD¡¨] under the Environmental Impact Assessment Ordinance, Cap 499,
S.16 are presented in Table 2.3.
Time Period |
Action Level |
Limit Level (dB(A)) |
0700-1900 on normal weekdays |
When one documented complaint is received from any one of the noise sensitive receivers |
- 70 dB(A) for school and - 65 dB(A) during examination period |
Notes: Limits specified in the GW-TM and IND-TM
for construction and operation noise,
respectively.

If exceedances were found during noise monitoring, the actions in accordance with the Event and Action Plan shall be carried out according to Appendix E.
2.5. MONITORING RESULTS AND OBSERVATIONS
Referring to EM&A manual Section 4.1.2, the impact noise monitoring should be carried out when there are project-related construction activities undertaken within a radius of 300m from the monitoring stations. No noise monitoring station was located within a radius of 300m of the Project site as shown in Figure 2.4, no impact monitoring for noise impact was conducted in the reporting period.
In accordance with the recommendations of the EIA, water quality monitoring is required during dredging for the submarine pipelines and, during operation phase. In addition, baseline water quality monitoring was conducted prior to the commencement of marine construction activities.
The following Section provides details of the water quality monitoring to be undertaken by the Environmental Team (ET) to verify the distance of sediment and brine plume dispersion and to identify whether the potential exists for any indirect impacts to occur to ecological sensitive receivers. The water quality monitoring programme was carried out to allow any deteriorating water quality to be readily detected and timely action taken to rectify the situation.
Water quality monitoring for the Project can be divided into the following stages:
- Dredging activities during construction phase;
- Discharge of effluent from main disinfection during construction phase;
- Operation phase - first year upon commissioning; and,
- Continuous monitoring of effluent quality.
In addition, the marine works contractor is required to complete a silt curtain efficiency test for the combined use of floating silt curtain type and cage type silt curtain for dredging at seawater intake to confirm the silt curtain reduction efficiency assumptions of the assessment. The details of testing plan together with the silt curtain deployment plan shall be submitted by the ET to seek approval from the IEC and EPD.
With the onset of marine dredging activities in late April at Outfall Shaft Area, a silt curtain efficiency test has been conducted at the Outfall Shaft Area on 16t April 2021 at 6 monitoring intervals (08:00, 10:00, 12:00, 14:00, 16:00, 18:00). The baseline monitoring event has been conducted on 10 April 2021 at 5 monitoring locations. Testing protocols and methodologies had followed the guidelines as presented in the EM&A Manual Annex C. Detailed analysis of in-situ and laboratory data was presented in a separate report which has been submitted to EPD after approval by IEC on 31 May 2021. The overall Silt Removal Effectiveness at Outfall Shaft Area for the combined used of cage and floating type silt curtains was 95.28%.
3.1. WATER QUALITY PARAMETERS
The parameters that have been selected for measurement in situ and in the laboratory are those that were either determined in the EIA to be those with the most potential to be affected by the construction works or are a standard check on water quality conditions. Parameters measured in the impact monitoring are listed in Table 3.1.
Parameters |
Unit |
Abbreviation |
In-situ
measurements |
||
Dissolved oxygen |
mg/L |
DO |
Temperature |
oC |
- |
pH |
- |
- |
Turbidity |
NTU |
- |
Salinity |
0/00 |
- |
Total Residual Chlorine NOTE1 |
mg/L |
TRC |
Laboratory measurements |
||
Suspended Solids |
mg/L |
SS |
Iron-Soluble NOTE2 |
mg/L |
Fe |
Anti-scalant as Reactive Phosphorus NOTE2 |
mg/L |
PO4 as P- |
NOTE 1: Monitoring of TRC will be conducted
when cleaning and sterilization of the new freshwater main is carried
out.
In addition to the water quality parameters, other relevant data were measured and recorded in Water Quality Monitoring Logs, including the location of the sampling stations, water depth, time, weather conditions, sea conditions, tidal stage, current direction and velocity, special phenomena and work activities undertaken around the monitoring and works area that may influence the monitoring results.
3.1.1.
MONITORING LOCATIONS

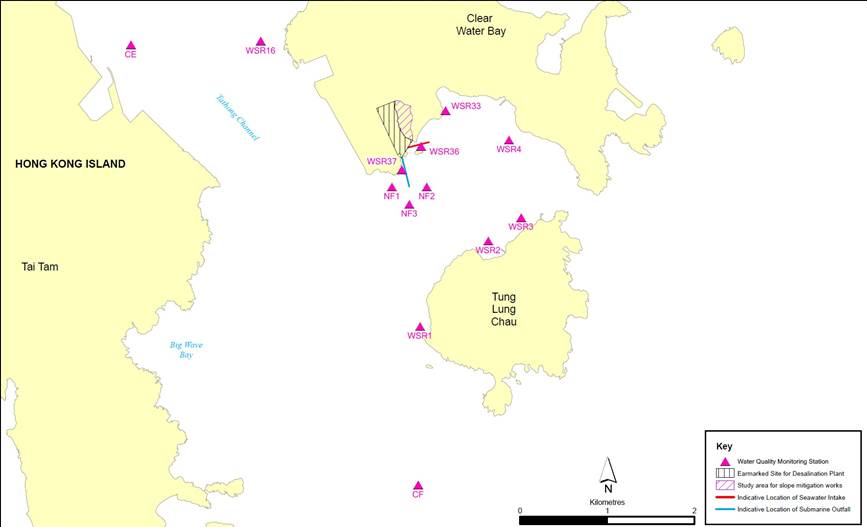

The impact water quality monitoring locations in accordance to the EM&A Manual and detailed in
Table 3.2 below.
Station |
Easting |
Northing |
Description |
CE |
843550 |
815243 |
Upstream control station at ebb tide |
CF |
846843 |
810193 |
Upstream control station at flood tide |
WSR1 |
846864 |
812014 |
Ecological sensitive receiver at Tung Lung Chau |
WSR2 |
847645 |
812993 |
Fisheries sensitive receiver at Tung Lung Chau |
WSR3 |
848023 |
813262 |
Ecological sensitive receiver at Tung Lung Chau |
WSR4 |
847886 |
814154 |
Ecological sensitive receiver at Tai Miu Wan |
WSR16 |
845039 |
815287 |
Ecological sensitive receiver at Fat Tong Chau |
WSR33 |
847159 |
814488 |
Ecological sensitive receiver at Tai Miu Wan |
WSR36 |
846878 |
814081 |
Ecological sensitive receiver at Kwun Tsai |
WSR37 |
846655 |
813810 |
Ecological sensitive receiver at Tit Cham Chau |
NF1 |
846542 |
813614 |
Edge of mixing zone, ~ 200m west of outfall diffuser |
NF2 |
846942 |
813614 |
Edge of mixing zone, ~ 200m east of outfall diffuser |
NF3 |
846742 |
813414 |
Edge of mixing zone, ~ 200m south of outfall diffuser |
3.2. MONITORING EQUIPMENT, METHODOLOGY AND QA/QC PROCEDURES
The monitoring methodology, equipment used and QA/QC procedures could be referring to Section 3.1.2 -3.1.4, 3.1.6-3.1.7 and 3.2 of the Monthly EM&A Report.
3.3. ACTION AND LIMIT LEVELS
The Action and Limit Levels have been set based on the derivation criteria specified in the EM&A Manual and based on the baseline water quality monitoring data and the derivation criteria, the Action/Limit Levels have been derived and are presented in Table 3.3.
Parameters |
Action |
Limit |
Construction Phase Impact
Monitoring |
||
DO in mg/L |
Surface and Middle 7.30 mg L-1 Bottom 7.31
mg L-1 Tung Lung Chau Fish Culture Zone 5.1 mgL-1 or level at control station (whichever the lower) |
Surface and Middle 4 mg
L-1 Bottom 2 mg L-1 Tung Lung Chau Fish Culture Zone 5.0 mgL-1 or level at control station (whichever the lower) |
SS in mg/L (Depth-averaged) |
5.00 mg L-1 or 20% exceedance of value at any impact station compared with corresponding data from control station |
6.00 mg L-1 or 30% exceedance of value at any impact station compared with corresponding data from control station |
Turbidity in NTU (Depth-averaged) |
2.41 NTU or 20% exceedance of value at any impact station compared with corresponding data from control station |
2.84 NTU or 30% exceedance of value at any impact station compared with corresponding data from control station |
First-year Operation Phase
Monitoring iv |
||
DO in mg/L |
Surface and Middle 7.30 mg L-1 Bottom 7.31
mg L-1 Tung Lung Chau Fish Culture Zone |
Surface and Middle 4 mg
L-1 Bottom 2 mg L-1 Tung Lung Chau Fish Culture Zone |
|
5.1 mgL-1 or level at control station (whichever the lower) |
5.0 mgL-1 or level at control station (whichever the lower) |
SS in mg/L (Depth-averaged) |
5.00 mg L-1 or 20% exceedance of value at any impact station compared with corresponding data from control station |
6.00 mg L-1 or 30% exceedance of value at any impact station compared with corresponding data from control station |
Turbidity in NTU (Depth-averaged) |
2.41 NTU or 20% exceedance of value at any impact station compared with corresponding data from control station |
2.84 NTU or 30% exceedance of value at any impact station compared with corresponding data from control station |
Salinity in PSU (Depth-averaged) |
34.28 PSU or 9% exceedance of value at any impact station compared with corresponding data from control station |
34.60 PSU or 10% exceedance of value at any impact station compared with corresponding data from control station |
Iron in mg/L (Depth-averaged) |
0.3 mgL-1 |
0.3 mgL-1 |
Notes:
i.
"Depth-averaged" is calculated by taking the arithmetic
means of reading of all three depths.
ii.
For DO, non-compliance of the water quality limits
occurs when monitoring result
is lower than the limits.
iii.
For Turbidity,
SS, iron and Salinity,
non-compliance of the water quality
limits occurs when monitoring result is higher than the limits.
iv.
For the Action and Limit Levels adopted
during First-year Operation Phase Monitoring, further review would be made
according to the EM&A Manual during Operation Phase.
3.4. MONITORING RESULTS AND OBSERVATIONS
General water quality monitoring at the ten monitoring stations (CE, CF, WSR1, WSR2, WSR3, WSR4, WSR16, WSR33, WSR36 and WSR37) were conducted on 2/12, 4/12, 7/12, 9/12, 11/12, 14/12, 16/12, 18/12, 21/12, 23/12, 25/12, 28/12, 30/12 and 1/1, 4/1, 6/1, 8/1, 11/1, 13/1, 15/1, 18/1 ,20/1, 22/1, 21/1, 27/1, 29/1, 31/1 and 4/2, 8/2, 10/2, 12/2, 15/2, 17/2, 19/2, 22/02, 24/2 and 26/2.
During the impact water quality monitoring period between December 2021 to February 2022, one hundred and ninety-three (193) of the general water quality monitoring results of suspended solids (SS) obtained had exceeded the Action Level. One hundred and thirty-two (132) of the general water quality monitoring results of SS obtained during the reporting quarter had exceeded the Limit Level.
Investigation on the reason of exceedance has been carried out, where the exceedances of SS on 2/12, 4/12, 9/12, 11/12, 14/12, 16/12, 18/12, 21/12, 23/12, 25/12, 28/12 and 30/12, 1/01, 4/1, 6/1, 8/1, 11/1, 15/1, 18/1, 20/1, 22/1, 25/1, 27/1, 29/1 and 31/1, 4/2, 8/2, 10/2, 12/2, 15/2, 17/2, 19/2, 22/2, 24/2 and 26/2 were concluded to be unrelated to the project. Details of the instigation could be referring to Monthly EM&A Report Appendix O.
Location |
Parameter |
|||||||||||||||||||||
Salinity (ppt) |
Dissolved Oxygen
(mg/L) |
pH |
Turbidity (NTU) |
Suspended Solids (mg/L) |
Temp. (oC) |
|||||||||||||||||
Surface &
Middle |
Bottom |
|||||||||||||||||||||
Dec |
Jan |
Feb |
Dec |
Jan |
Feb |
Dec |
Jan |
Feb |
Dec |
Jan |
Feb |
Dec |
Jan |
Feb |
Dec |
Jan |
Feb |
Dec |
Jan |
Feb |
||
CE |
Avg. |
32.3 |
32.8 |
32.9 |
8.58 |
8.8 |
9.1 |
8.8 |
8.8 |
9.1 |
8.27 |
8.2 |
8.3 |
3.6 |
3.3 |
4.6 |
4.87 |
4.1 |
6.9 |
23.5 |
21.1 |
18.4 |
Min. |
30.6 |
30.1 |
30.6 |
7.89 |
8.1 |
8.3 |
8.1 |
8.1 |
8.2 |
8.05 |
8.0 |
8.0 |
2.7 |
2.3 |
3.5 |
2.50 |
2.5 |
2.5 |
22.1 |
19.7 |
16.6 |
|
Max |
33.4 |
35.1 |
34.0 |
9.82 |
9.6 |
10.1 |
9.6 |
9.6 |
10.2 |
8.42 |
8.5 |
8.4 |
5.2 |
4.3 |
6.1 |
12.0 |
12.0 |
20.0 |
25.8 |
23.1 |
20.4 |
|
CF |
Avg. |
32.3 |
32.8 |
32.9 |
8.49 |
8.7 |
9.1 |
8.7 |
8.7 |
9.1 |
8.34 |
8.3 |
8.3 |
4.2 |
3.9 |
3.7 |
5.25 |
5.4 |
7.5 |
23.5 |
21.2 |
18.5 |
Min. |
30.8 |
30.3 |
31.6 |
7.80 |
8.2 |
8.3 |
8.2 |
8.2 |
8.3 |
8.08 |
8.0 |
8.1 |
3.1 |
2.2 |
2.5 |
2.50 |
2.5 |
2.5 |
21.7 |
20.1 |
16.4 |
|
Max |
33.5 |
34.9 |
34.2 |
9.72 |
9.0 |
10.0 |
9.1 |
9.1 |
10.1 |
8.56 |
8.5 |
8.4 |
6.4 |
5.7 |
5.0 |
14.0 |
22.0 |
27.0 |
25.9 |
22.9 |
20.2 |
|
WSR1 |
Avg. |
32.3 |
32.8 |
32.8 |
8.69 |
8.7 |
9.2 |
8.6 |
8.6 |
9.2 |
8.25 |
8.2 |
8.3 |
2.7 |
2.7 |
3.0 |
5.88 |
4.4 |
6.3 |
23.5 |
21.1 |
18.4 |
Min. |
30.2 |
30.3 |
30.8 |
8.16 |
8.2 |
8.4 |
8.2 |
8.2 |
8.4 |
8.08 |
8.0 |
8.0 |
1.3 |
1.6 |
1.6 |
2.50 |
2.5 |
2.5 |
21.7 |
19.6 |
16.4 |
|
Max |
33.7 |
35.0 |
34.2 |
9.16 |
9.4 |
10.1 |
9.4 |
9.4 |
10.1 |
8.47 |
8.5 |
8.4 |
4.1 |
4.0 |
4.2 |
13.0 |
8.0 |
19.0 |
25.5 |
22.7 |
20.4 |
|
WSR2 |
Avg. |
32.3 |
33.0 |
32.8 |
8.59 |
9.0 |
9.1 |
8.9 |
8.9 |
9.1 |
8.28 |
8.3 |
8.3 |
2.8 |
2.3 |
2.2 |
5.31 |
5.0 |
7.9 |
23.6 |
21.2 |
18.3 |
Min. |
30.4 |
31.1 |
30.9 |
8.01 |
8.3 |
8.3 |
8.4 |
8.4 |
8.3 |
8.11 |
8.0 |
8.1 |
1.4 |
1.5 |
1.8 |
2.50 |
2.5 |
2.5 |
22.3 |
19.7 |
16.6 |
|
Max |
34.0 |
35.0 |
34.0 |
9.34 |
9.8 |
10.1 |
9.9 |
9.9 |
10.2 |
8.47 |
8.5 |
8.5 |
4.0 |
3.4 |
2.9 |
12.0 |
21.0 |
23.0 |
25.6 |
23.2 |
19.9 |
|
WSR3 |
Avg. |
32.3 |
32.4 |
32.8 |
8.66 |
8.7 |
9.0 |
8.7 |
8.7 |
9.0 |
8.31 |
8.3 |
8.2 |
2.7 |
2.7 |
3.0 |
6.51 |
6.5 |
8.1 |
23.5 |
23.5 |
18.3 |
Min. |
31.0 |
31.1 |
31.2 |
7.67 |
7.7 |
8.4 |
7.7 |
7.7 |
8.3 |
8.10 |
8.1 |
8.0 |
1.6 |
1.6 |
1.8 |
2.50 |
2.5 |
2.5 |
21.9 |
21.9 |
16.4 |
|
Max |
33.2 |
33.3 |
33.7 |
9.39 |
9.4 |
10.1 |
9.4 |
9.4 |
10.0 |
8.52 |
8.5 |
8.5 |
4.6 |
4.6 |
4.1 |
23.0 |
23.0 |
21.0 |
25.8 |
25.8 |
19.9 |
|
WSR4 |
Avg. |
32.1 |
32.7 |
32.9 |
8.47 |
8.8 |
9.1 |
8.8 |
8.8 |
9.1 |
8.29 |
8.2 |
8.3 |
2.7 |
2.7 |
3.2 |
6.86 |
6.4 |
8.2 |
23.6 |
21.2 |
18.4 |
Min. |
30.9 |
30.6 |
31.0 |
7.72 |
8.3 |
8.4 |
8.0 |
8.0 |
8.4 |
8.06 |
8.0 |
8.1 |
1.6 |
1.8 |
2.1 |
2.50 |
2.5 |
2.5 |
22.1 |
20.0 |
16.5 |
|
Max |
33.4 |
35.3 |
34.4 |
9.11 |
9.6 |
10.0 |
9.6 |
9.6 |
10.0 |
8.50 |
8.4 |
8.5 |
4.2 |
3.8 |
4.6 |
26.0 |
36.0 |
22.0 |
25.9 |
22.5 |
20.1 |
|
WSR16 |
Avg. |
32.2 |
32.2 |
33.1 |
8.75 |
8.8 |
8.9 |
8.8 |
8.8 |
8.9 |
8.29 |
8.3 |
8.3 |
2.9 |
2.9 |
3.1 |
6.42 |
6.4 |
7.0 |
23.6 |
23.6 |
18.4 |
Min. |
30.9 |
31.0 |
30.8 |
8.08 |
8.1 |
8.4 |
8.0 |
8.0 |
8.4 |
8.06 |
8.1 |
8.1 |
1.7 |
1.7 |
1.5 |
3.00 |
3.0 |
2.5 |
22.0 |
22.0 |
16.6 |
|
Max |
33.8 |
33.8 |
34.2 |
9.52 |
9.5 |
9.7 |
9.5 |
9.5 |
9.8 |
8.45 |
8.5 |
8.5 |
4.3 |
4.3 |
4.0 |
26.0 |
26.0 |
21.0 |
25.6 |
25.6 |
20.4 |
|
WSR33 |
Avg. |
32.0 |
32.7 |
33.0 |
8.63 |
8.6 |
9.0 |
8.6 |
8.6 |
9.0 |
8.29 |
8.3 |
8.3 |
2.6 |
2.9 |
3.2 |
6.92 |
4.3 |
6.4 |
23.6 |
21.1 |
18.4 |
Min. |
30.5 |
30.6 |
31.0 |
8.02 |
8.0 |
8.3 |
8.0 |
8.0 |
8.4 |
8.09 |
8.0 |
8.1 |
1.8 |
1.8 |
2.0 |
3.00 |
2.5 |
2.5 |
22.0 |
19.9 |
16.5 |
|
Max |
33.1 |
34.3 |
34.2 |
9.28 |
9.0 |
9.8 |
9.1 |
9.1 |
9.9 |
8.57 |
8.5 |
8.4 |
3.6 |
4.3 |
4.3 |
24.0 |
8.0 |
21.0 |
26.1 |
22.6 |
20.0 |
|
WSR36 |
Avg. |
32.4 |
32.7 |
32.8 |
8.61 |
8.9 |
9.0 |
8.8 |
8.8 |
9.0 |
8.29 |
8.3 |
8.3 |
2.9 |
2.7 |
2.8 |
7.03 |
4.9 |
7.0 |
23.6 |
21.1 |
18.4 |
Min. |
31.1 |
30.9 |
31.2 |
8.00 |
8.3 |
8.4 |
8.2 |
8.2 |
8.3 |
8.11 |
8.1 |
8.1 |
1.6 |
1.3 |
1.2 |
2.50 |
2.5 |
2.5 |
22.1 |
19.9 |
16.3 |
|
Max |
33.7 |
35.2 |
33.8 |
9.17 |
9.7 |
10.0 |
9.8 |
9.8 |
10.1 |
8.56 |
8.5 |
8.5 |
4.4 |
4.0 |
4.0 |
24.0 |
13.0 |
25.0 |
26.2 |
22.6 |
20.2 |
|
WSR37 |
Avg. |
32.2 |
32.8 |
32.9 |
8.68 |
8.8 |
9.0 |
8.8 |
8.8 |
9.0 |
8.29 |
8.3 |
8.2 |
2.7 |
2.8 |
2.9 |
7.95 |
5.3 |
5.8 |
23.6 |
21.1 |
18.3 |
Min. |
31.1 |
30.6 |
31.4 |
7.85 |
8.3 |
8.3 |
8.3 |
8.3 |
8.3 |
8.10 |
8.0 |
8.0 |
1.7 |
1.8 |
2.1 |
3.00 |
2.5 |
2.5 |
21.9 |
19.8 |
16.5 |
|
Max |
33.5 |
35.2 |
34.3 |
9.50 |
9.8 |
9.8 |
9.7 |
9.7 |
9.8 |
8.49 |
8.5 |
8.4 |
4.3 |
4.4 |
4.3 |
25.0 |
23.0 |
13.0 |
26.0 |
22.8 |
20.2 |
Location |
Parameter |
|||||||||||||||||||||
Salinity (ppt) |
Dissolved Oxygen
(mg/L) |
pH |
Turbidity (NTU) |
Suspended Solids (mg/L) |
Temp. (oC) |
|||||||||||||||||
Surface &
Middle |
Bottom |
|||||||||||||||||||||
Dec |
Jan |
Feb |
Dec |
Jan |
Feb |
Dec |
Jan |
Feb |
Dec |
Jan |
Feb |
Dec |
Jan |
Feb |
Dec |
Jan |
Feb |
Dec |
Jan |
Feb |
||
CE |
Avg. |
32.0 |
32.8 |
32.8 |
8.46 |
8.7 |
9.2 |
8.45 |
8.7 |
9.2 |
8.26 |
8.2 |
8.3 |
4.2 |
3.9 |
3.4 |
6.88 |
4.7 |
7.4 |
23.7 |
21.2 |
18.1 |
Min. |
30.4 |
30.9 |
30.6 |
7.67 |
7.9 |
8.4 |
7.78 |
7.9 |
8.5 |
8.05 |
8.1 |
8.0 |
3.1 |
2.8 |
1.8 |
2.50 |
2.5 |
2.5 |
21.7 |
19.8 |
16.3 |
|
Max |
33.6 |
34.8 |
34.2 |
9.17 |
9.8 |
10.1 |
9.15 |
9.7 |
10.2 |
8.45 |
8.4 |
8.5 |
5.6 |
5.2 |
6.1 |
25.0 |
11.0 |
27.0 |
25.8 |
22.8 |
19.7 |
|
CF |
Avg. |
32.0 |
32.6 |
32.8 |
8.39 |
8.6 |
9.1 |
8.39 |
8.6 |
9.2 |
8.23 |
8.2 |
8.3 |
3.4 |
3.3 |
3.9 |
7.96 |
5.2 |
7.4 |
23.7 |
21.2 |
18.3 |
Min. |
30.4 |
30.6 |
31.6 |
7.80 |
7.9 |
8.3 |
7.66 |
7.9 |
8.3 |
7.89 |
8.0 |
8.1 |
2.3 |
2.3 |
2.9 |
2.50 |
2.5 |
2.5 |
21.7 |
20.2 |
16.4 |
|
Max |
33.7 |
34.4 |
33.6 |
9.23 |
9.4 |
10.0 |
9.23 |
9.4 |
10.1 |
8.47 |
8.5 |
8.4 |
4.4 |
4.7 |
5.0 |
27.0 |
17.0 |
27.0 |
25.8 |
22.9 |
19.6 |
|
WSR1 |
Avg. |
31.8 |
32.9 |
32.8 |
8.64 |
8.6 |
9.1 |
8.63 |
8.6 |
9.1 |
8.26 |
8.2 |
8.3 |
2.6 |
2.8 |
3.2 |
8.23 |
5.4 |
6.2 |
23.8 |
21.2 |
18.2 |
Min. |
29.7 |
30.1 |
30.8 |
8.08 |
8.1 |
8.4 |
8.05 |
8.1 |
8.4 |
7.86 |
7.9 |
8.0 |
1.7 |
1.6 |
2.1 |
2.50 |
2.5 |
2.5 |
22.0 |
19.8 |
16.4 |
|
Max |
33.3 |
35.1 |
34.2 |
9.24 |
9.3 |
10.1 |
9.18 |
9.3 |
10.1 |
8.44 |
8.4 |
8.4 |
3.7 |
4.1 |
4.2 |
29.0 |
13.0 |
19.0 |
26.2 |
23.0 |
19.5 |
|
WSR2 |
Avg. |
32.1 |
32.8 |
32.8 |
8.62 |
8.7 |
9.2 |
8.62 |
8.7 |
9.2 |
8.27 |
8.3 |
8.3 |
2.6 |
2.4 |
2.3 |
6.07 |
4.5 |
8.3 |
23.7 |
21.1 |
18.2 |
Min. |
30.5 |
30.5 |
30.9 |
7.43 |
8.0 |
8.3 |
7.78 |
8.1 |
8.3 |
8.01 |
8.0 |
8.1 |
1.6 |
1.5 |
1.8 |
2.50 |
2.5 |
2.5 |
21.8 |
19.8 |
16.6 |
|
Max |
33.8 |
34.6 |
34.0 |
9.19 |
9.2 |
10.1 |
9.18 |
9.2 |
10.2 |
8.43 |
8.5 |
8.5 |
4.0 |
3.8 |
2.9 |
13.0 |
8.0 |
23.0 |
26.3 |
22.9 |
19.5 |
|
WSR3 |
Avg. |
32.1 |
32.6 |
32.8 |
8.61 |
8.7 |
9.0 |
8.60 |
8.7 |
9.0 |
8.25 |
8.2 |
8.2 |
2.8 |
2.8 |
3.1 |
7.53 |
5.2 |
8.4 |
23.7 |
21.1 |
18.1 |
Min. |
30.5 |
29.9 |
31.2 |
7.65 |
8.2 |
8.4 |
7.59 |
8.3 |
8.3 |
7.86 |
7.9 |
8.0 |
1.8 |
1.4 |
1.9 |
3.00 |
2.5 |
2.5 |
22.1 |
20.1 |
16.4 |
|
Max |
33.2 |
34.6 |
33.7 |
9.20 |
9.6 |
10.1 |
9.06 |
9.6 |
10.0 |
8.44 |
8.4 |
8.5 |
4.0 |
4.5 |
4.1 |
25.0 |
20.0 |
21.0 |
26.1 |
22.9 |
19.6 |
|
WSR4 |
Avg. |
32.0 |
32.7 |
32.8 |
8.51 |
8.8 |
9.1 |
8.53 |
8.8 |
9.1 |
8.29 |
8.2 |
8.3 |
2.6 |
2.8 |
3.2 |
7.19 |
5.8 |
8.5 |
23.7 |
21.2 |
18.2 |
Min. |
30.1 |
30.3 |
31.0 |
7.50 |
8.1 |
8.4 |
7.37 |
8.1 |
8.4 |
8.03 |
8.0 |
8.1 |
1.8 |
1.6 |
2.1 |
3.00 |
2.5 |
2.5 |
21.9 |
19.9 |
16.5 |
|
Max |
33.5 |
34.8 |
33.9 |
9.07 |
9.7 |
10.0 |
8.97 |
9.7 |
10.0 |
8.44 |
8.5 |
8.5 |
3.8 |
4.4 |
4.6 |
22.0 |
28.0 |
22.0 |
26.0 |
23.5 |
19.4 |
|
WSR16 |
Avg. |
32.0 |
32.9 |
33.0 |
8.61 |
8.7 |
8.9 |
8.60 |
8.7 |
8.9 |
8.28 |
8.3 |
8.3 |
2.8 |
2.8 |
3.2 |
6.63 |
4.9 |
7.4 |
23.7 |
21.1 |
18.2 |
Min. |
30.6 |
30.0 |
30.8 |
8.09 |
7.9 |
8.4 |
8.12 |
8.0 |
8.4 |
8.09 |
7.9 |
8.1 |
1.6 |
1.8 |
2.4 |
2.50 |
2.5 |
2.5 |
21.8 |
19.8 |
16.6 |
|
Max |
33.6 |
34.8 |
34.2 |
9.18 |
9.4 |
9.7 |
9.18 |
9.3 |
9.8 |
8.47 |
8.4 |
8.4 |
4.1 |
4.0 |
4.0 |
29.0 |
13.0 |
21.0 |
26.0 |
23.0 |
19.7 |
|
WSR33 |
Avg. |
32.1 |
32.7 |
33.0 |
8.57 |
8.6 |
9.0 |
8.57 |
8.7 |
9.0 |
8.31 |
8.2 |
8.3 |
2.7 |
2.7 |
3.3 |
7.41 |
5.5 |
6.5 |
23.7 |
21.2 |
18.2 |
Min. |
30.5 |
30.4 |
31.0 |
8.02 |
8.1 |
8.3 |
8.00 |
8.0 |
8.4 |
8.10 |
7.9 |
8.1 |
1.7 |
1.8 |
2.0 |
3.00 |
2.5 |
2.5 |
21.8 |
19.9 |
16.5 |
|
Max |
33.5 |
34.3 |
34.2 |
9.38 |
9.4 |
9.8 |
9.19 |
9.3 |
9.9 |
8.46 |
8.4 |
8.4 |
4.0 |
4.2 |
4.3 |
26.0 |
16.0 |
21.0 |
26.1 |
23.3 |
19.6 |
|
WSR36 |
Avg. |
32.0 |
32.7 |
32.7 |
8.53 |
8.5 |
9.0 |
8.55 |
8.5 |
9.0 |
8.31 |
8.2 |
8.3 |
2.7 |
2.9 |
3.0 |
8.85 |
4.5 |
7.2 |
23.8 |
21.2 |
18.1 |
Min. |
30.1 |
29.9 |
31.2 |
7.77 |
8.1 |
8.4 |
7.87 |
8.1 |
8.3 |
7.91 |
7.9 |
8.1 |
1.8 |
1.8 |
1.9 |
2.50 |
2.5 |
2.5 |
21.8 |
19.8 |
16.3 |
|
Max |
33.1 |
34.7 |
33.8 |
9.19 |
9.0 |
10.0 |
9.49 |
9.0 |
10.1 |
8.48 |
8.4 |
8.5 |
3.7 |
4.0 |
4.0 |
28.0 |
9.0 |
25.0 |
26.1 |
23.1 |
19.6 |
|
WSR37 |
Avg. |
31.9 |
32.7 |
32.7 |
8.63 |
8.7 |
9.0 |
8.65 |
8.7 |
9.0 |
8.29 |
8.2 |
8.2 |
2.7 |
2.9 |
3.0 |
8.19 |
5.3 |
6.0 |
23.6 |
21.2 |
18.1 |
Min. |
30.7 |
30.1 |
31.4 |
7.59 |
8.0 |
8.3 |
7.54 |
7.9 |
8.3 |
8.04 |
7.9 |
8.0 |
1.8 |
1.6 |
2.1 |
2.50 |
2.5 |
2.5 |
22.0 |
20.0 |
16.5 |
|
Max |
33.0 |
34.3 |
33.7 |
9.40 |
9.3 |
9.8 |
9.27 |
9.3 |
9.8 |
8.47 |
8.4 |
8.4 |
3.9 |
4.0 |
4.3 |
27.0 |
27.0 |
13.0 |
26.2 |
23.4 |
19.6 |
Notes:
i.
"Avg", ¡§Min¡¨ and ¡§Max¡¨ is the average, minimum and maximum respectively of the data from measurements conducted under mid-flood and mid-ebb
tides at three water depths, except that of
DO where the data for ¡§Surface & Middle¡¨ and ¡§Bottom¡¨ are calculated
separately.
ii.
Measurement data of Suspending Solids would be rounding to 2.5mg/L if the value was less than 2.5mg/L
to facilitate data
analysing.
The waste generated from
this Project includes inert construction and demolition (C&D) materials,
and non-inert C&D materials. Non- inert C&D materials are made up of
general refuse, vegetative wastes and recyclable wastes such as plastics and
paper/cardboard packaging waste. Steel materials generated from the project are
also grouped into non-inert C&D materials as the materials were not
disposed of with other inert C&D materials. With reference to relevant
handling records and trip tickets of this Project, the quantities of different types of waste
generated in the reporting period
are summarized in Table 4.1.
Details of cumulative waste management data are
presented as a waste flow table in Appendix
G.

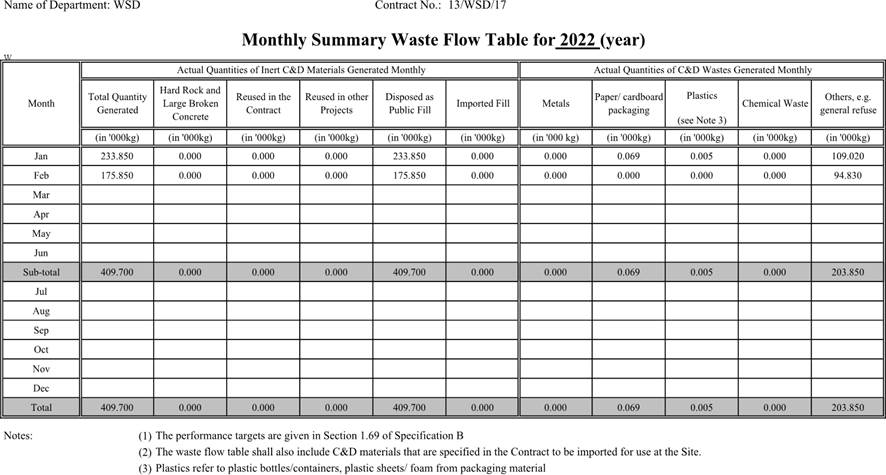

Reporting Months |
Actual Quantities of Inert C&D Materials Generated Monthly |
Actual Quantities of C&D Wastes
Generated Monthly |
|||||||||
Total Quantity Generated |
Hard Rock and Large Broken Concrete |
Reused in the Contract |
Reused in other Projects |
Disposed as Public Fill |
Imported Fill |
Metals |
Paper / cardboard packaging |
Plastics (see Note) |
Chemical Waste |
Others, e.g. general refuse |
|
(in ,000kg) |
(in ,000kg) |
(in ,000kg) |
(in ,000kg) |
(in ,000kg) |
(in ,000kg) |
(in ,000kg) |
(in ,000kg) |
(in ,000kg) |
(in ,000kg) |
(in ,000kg) |
|
December 2021 |
457.090 |
0.000 |
0.000 |
0.000 |
457.090 |
0.000 |
0.000 |
0.130 |
0.030 |
0.000 |
131.270 |
January 2022 |
233.850 |
0.000 |
0.000 |
0.000 |
233.850 |
0.000 |
0.000 |
0.069 |
0.005 |
0.000 |
109.02 |
February 2022 |
175.850 |
0.000 |
0.000 |
0.000 |
175.850 |
0.000 |
0.000 |
0.000 |
0.000 |
0.000 |
94.830 |
Notes: (1) Plastics
refer to plastic
bottles / containers, plastic sheets / foam from packaging material
5.1. MONITORING REQUIREMENT
In accordance with Section 11 of the EM&A Manual, monitoring of landfill gas is required for construction works within the 250m Consultation Zone. Part of the desalination plant and the indicative area of natural slope mitigation works fall within the SENT Landfill Extension Consultation Zone; and part of the 1,200 mm diameter fresh water mains along Wan Po Road falls within the SENT Landfill and SENT Landfill Extension Consultation Zones, TKO Stage II/III Restored Landfill and TKO Stage I Restored Landfill Consultation Zones.
5.2. MONITORING LOCATION
Monitoring of oxygen, methane, carbon dioxide and barometric pressure was performed for excavations at 1m depth or more within the consultation Zone.
During construction of works within the consultation zones, excavations of 1m depth or more was monitored:
-
At the ground surface before
excavation commences;
-
Immediately before any worker enters
the excavation;
-
At the beginning
of each working
day for the entire period the excavation remains open; and
-
Periodically through the working day whilst workers
are in the excavation.
For excavations between 300mm and 1m deep, measurements should be carried out:
-
Directly after the excavation has been completed; and
-
Periodically whilst the excavation remains
open.
5.3. MONITORING PARAMETERS
LFG monitoring was carried out to identify any migration between the landfill and the Project and to ensure the safety of the construction, operation and maintenance personnel working on-site, visitors and any other person within the Project area.
The following parameters were monitored:
- Methane.
- Oxygen.
- Carbon Dioxide.
- Barometric Pressure.
The area required to be monitored for landfill gas in the reporting period is shown in Figure 5.1.
Figure 5.1 Overview of the SENT Extension Consultation Zone and the Project Site Area
5.5.
ACTION
AND LIMIT LEVEL
Action and Limit Level are provided in Table 5.1.
Table 5.1 Action and Limit Level for Landfill Gas Monitoring
Parameters |
Action Level |
Limit Level |
Oxygen (O2) |
<19% O2 |
<19% O2 |
Methane (CH4) |
>10% LEL |
>20% LEL |
Carbon Dioxide (CO2) |
>0.5% CO2 |
>1.5% CO2 |
The monitoring equipment used in the reporting period could be referring to Section 5.6 of the Monthly EM&A Report.
In this reporting period, 66 times of landfill gas monitoring were recorded at Wan Po Road (Ch1+625 - Ch1+513). No exceedance of action and limit levels for methane, oxygen and carbon dioxide was observed. Monitoring was conducted during excavations at 1m depth or more within the consultation zone and whenever workers entered the excavation on the day.

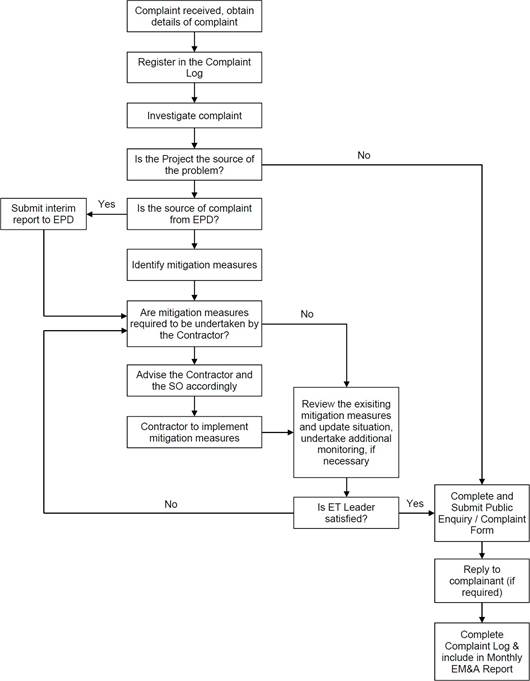

The Environmental Complaint Handling Procedure is shown in below Figure 6.1:
No noise monitoring was conducted during the reporting period since there are no Contract-related construction activities undertaken within a radius of 300m from the monitoring locations. No Action Level exceedance was recorded during the reporting period.
The EM&A works for water quality were conducted during the reporting period in accordance with the EM&A Manual.
During the impact monitoring period between December 2021 to February 2022, one hundred and ninety-three (193) of the general water quality monitoring results of SS obtained had exceeded the Action Level. One hundred and thirty-two (132) of the general water quality monitoring results of SS obtained during the reporting quarter had exceeded the Limit Level.
After investigation, all exceedances were considered non-project related.
In this reporting period, 66 times of landfill gas monitoring were recorded at Wan Po Road (Ch1+625 - Ch1+513). No exceedance of action and limit levels for methane, oxygen and carbon dioxide was observed. Monitoring was conducted during excavations at 1m depth or more within the consultation zone and whenever workers entered the excavation on the day.
ACJCJ¡¦s Environmental Office received a text message on 14 January 2022 from EPD inspector claiming that susceptible oil spillage at the water surface nearby to Outfall Shaft was observed during their routine drone check on 13 January 2022. The message from EPD was relayed to ET by AJCJV on 15 January 2022. Immediate investigation by AJCJV has been made after the acknowledgement of the incident, whilst implementing emergency clean up measure on any residue oil spillage. After investigation, the oil spillage was unlikely originated from the Outfall Shaft. The incident may therefore be considered as non-project related. Detail of the incident could be referring to Monthly EM&A Report Appendix O.
Moreover, oil stains were also observed at CEDD pier after leaving of Explosives Vessel on 28 January, 9 and 23 February 2022 by Supervising Officer¡¦s Representative (SOR) during site inspection. ET will keep closely monitoring the performance of Contractor, implementation of water quality mitigation measure and other contamination issue around the Project site, to ensure the EM&A requirement is properly implemented.
No notification of summons and prosecution was received in the reporting period. Statistics on complaints and regulatory compliance are summarized in Appendix H.
Site inspections were carried out on a weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures under the Contract.
Joint site inspections were also carried out by ET and IEC on 7, 15, 22 and 31 December 2021, 4, 11, 18, 26 and 31 January 2022, 8, 17, 23 and 28 February 2022.
Minor deficiencies were observed during weekly site inspection. Key observations during the site inspections are summarized below:
- Storage of chemicals and construction materials on-site was not conducted properly
- Housekeeping of drainage channel
- Underground seepage marine water was not by-pass through an uncontaminated isolation system.
The Contractor has rectified the observations identified during environmental site inspections in the reporting period.
According to the EIA Study Report, Environmental Permit, contract documents and EM&A Manual, the mitigation measures detailed in the documents should be implemented as much as practical during the reporting period. An updated Implementation Status of Environmental Mitigation Measures (EMIS) is provided in Appendix C.
This is the 8th Quarterly EM&A Report for the Project which summarizes the key findings of the EM&A programme during the reporting period from 1 December 2021 to 28 February 2022, in accordance with the EM&A Manual and the requirement under FEP-01/503/2015/A.
No noise monitoring was conducted in the reporting period due to the over distant monitoring station from the works location.
During the impact monitoring period between December 2021 to February 2022, one hundred and ninety-three (193) of the general water quality monitoring results of SS obtained had exceeded the Action Level. One hundred and thirty-two (132) of the general water quality monitoring results of SS obtained during the reporting quarter had exceeded the Limit Level.
After investigation, all exceedances were considered non-project related.
In this reporting period, 66 times of landfill gas monitoring were recorded at Wan Po Road (Ch1+625 - Ch1+513). No exceedance of action and limit levels for methane, oxygen and carbon dioxide was observed. Monitoring was conducted during excavations at 1m depth or more within the consultation zone and whenever workers entered the excavation on the day.
ACJCJ¡¦s Environmental Office received a text message on 14 January 2022 from EPD inspector claiming that susceptible oil spillage at the water surface nearby to Outfall Shaft was observed during their routine drone check on 13 January 2022. The message from EPD was relayed to ET by AJCJV on 15 January 2022. Immediate investigation by AJCJV has been made after the acknowledgement of the incident, whilst implementing emergency clean up measure on any residue oil spillage. After investigation, the oil spillage was unlikely originated from the Outfall Shaft. The incident may therefore be considered as non-project related. Detail of the incident could be referring to Monthly EM&A Report Appendix O.
Moreover, oil stains were also observed at CEDD pier after leaving of Explosives Vessel on 28 January, 9 and 23 February 2022 by Supervising Officer¡¦s Representative (SOR) during site inspection. ET will keep closely monitoring the performance of Contractor, implementation of water quality mitigation measure and other contamination issue around the Project site, to ensure the EM&A requirement is properly implemented.
Weekly environmental site inspection was conducted during the reporting period. Minor deficiency was observed during site inspection and was rectified. The environmental performance of the project was therefore considered satisfactory.
According to the environmental site inspections performed in the reporting period, the Contractor is reminded to pay attention on maintaining proper materials storage.
No environmental complaint was received in the reporting period.
No notification of summons or prosecution was received since commencement of the Contract.
The ET will keep track on the construction works to confirm compliance of environmental requirements and the proper implementation of all necessary mitigation measures.

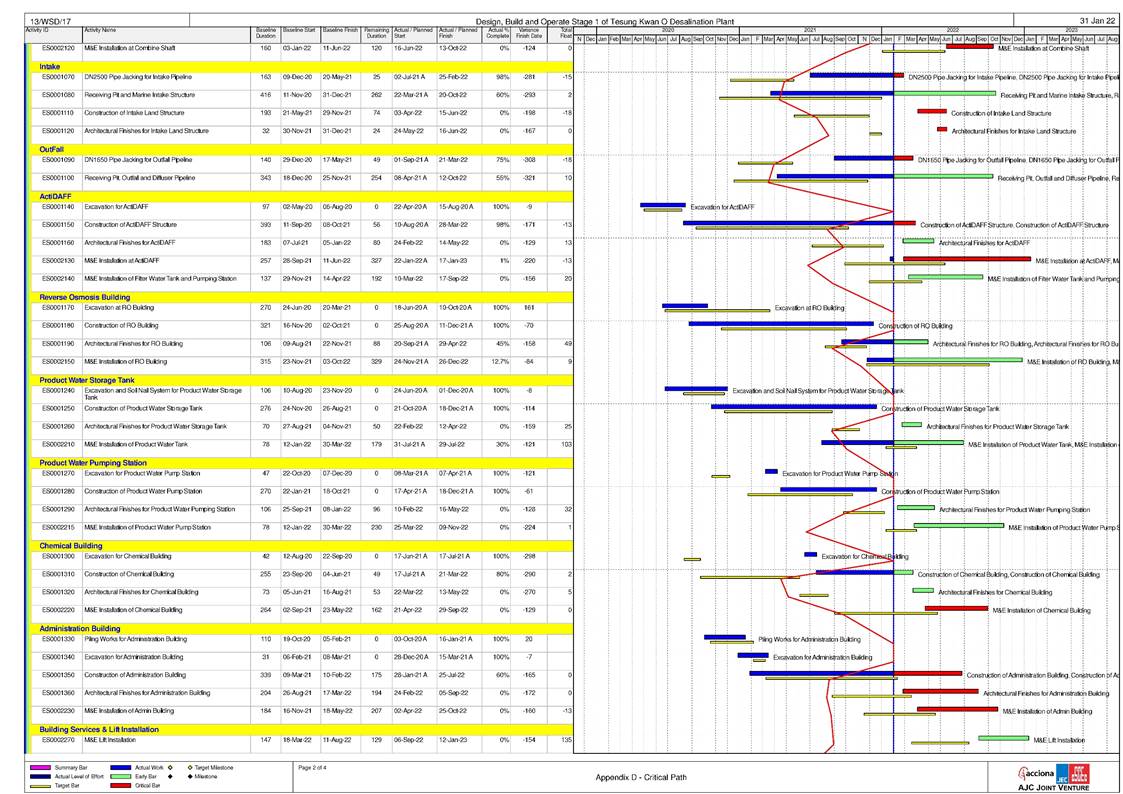

Appendix A
Master Programme
Appendix B
Overview of Desalination Plant
in Tseung Kwan O
Appendix C
Summary of Implementation Status
of Environmental Mitigation
EIA Reference |
Recommended Environmental Protection Measures/ Mitigation Measures |
Objectives of the
recommended measures & main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
Air Quality |
|
|||||||
S4.8.1 |
Impervious dust screen or sheeting will be provided to enclose
scaffolding from the ground floor
level of building for construction of
superstructure of the new buildings. |
Land site/ During
Construction |
Contractor(s) |
|
ü |
|
Implemented |
Air Pollution Control (Construction Dust) |
S4.8.1 |
Impervious sheet
will be provided for skip hoist
for material transport. |
Land site/ During Construction, particularly dry season |
Contractor(s) |
|
ü |
|
NA |
|
S4.8.1 |
The area where
dusty work takes
place should be sprayed with water or a dust suppression
chemical immediately prior to, during and immediately after dusty activities as far as
practicable. |
Land site/ During Construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.8.1 |
All dusty materials should be sprayed with water or a dust suppression chemical immediately prior
to any loading, unloading or transfer operation. |
Land site/ During Construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.8.1 |
Dropping heights for excavated materials should be controlled to a practical height to minimize the fugitive dust arising from unloading. |
Land site/ During Construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.8.1 |
During transportation by truck, materials should
not be loaded to a level higher than the side and tail boards, and should be dampened or covered before transport. |
Land site/ During
Construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.8.1 |
Wheel washing device
should be provided at the exits
of the work sites. Immediately before leaving a construction site, every
vehicle shall be washed to remove any dusty material from its body and wheels as
far as practicable. |
Land site/ During Construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.8.1 |
Road sections between vehicle-wash areas and vehicular entrance will be paved. |
Land site/ During Construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.8.1 |
Hoarding of not less
than 2.4m high from ground
level will be provided
along the length of the Project Site boundary. |
Land site/ During construction |
Contractor(s) |
ü |
ü |
|
N/A |
|
S4.8.1 |
Haul roads will be kept clear of dusty materials and will be
sprayed with water
so as to maintain the
entire road surface wet at all times. |
Land site/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
|
EIA Reference |
Recommended Environmental Protection Measures/ Mitigation Measures |
Objectives of the
recommended measures & main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
S4.8.1 |
Temporary stockpiles of dusty materials will be either covered
entirely by impervious sheets or sprayed
with water to maintain the entire surface wet all
the time. |
Land site/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.8.1 |
Stockpiles of
more than 20 bags of cement, dry pulverised fuel ash
and dusty construction materials will be covered entirely by impervious sheeting sheltered on top and 3- sides. |
Land site/ During construction |
Contractor(s) |
|
ü |
|
N/A |
|
S4.8.1 |
All exposed areas will be
kept wet always to minimise dust emission. |
Land site/ During
construction |
Contractor(s) |
|
ü |
|
Reminder issued. |
|
S4.8.1 |
Ultra-low-sulphur diesel (ULSD) will be used for all construction plant on-site, as defined as diesel fuel containing not more than 0.005% sulphur by weight) as stipulated in Environment, Transport and Works Bureau Technical Circular
(ETWB-TC(W)) No 19/2005 on Environmental Management on Construction Sites. |
Land site/ During construction/ During
Operation |
Contractor(s) |
|
ü |
ü |
Implemented |
Environment, Transport and Works Bureau Technical Circular (ETWB- TC(W)) No 19/2005 on Environmental Management on Construction Sites |
S4.8.1 |
The engine of the construction equipment during idling will be switched off. |
Land site/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.8.1 |
Concrete
batching plant will be required on site. control measures recommended in the Guidance Note on a Best Practicable Means for Cement Works
(Concrete Batching Plant)
(BPM 3/2 (93)) will be implemented. The control measures recommended in the Guidance Note on a Best Practicable Means for Cement Works
(Concrete Batching Plant)
(BPM 3/2 (93)) will be implemented. |
Land site/ During construction |
Contractor(s) |
|
ü |
|
N/A |
|
S4.8.1 |
Regular maintenance of construction equipment deployed on-site
will be conducted to prevent black smoke emission. |
Land site/ During
construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.10 |
To ensure proper implementation of the recommended dust mitigation
measures and good construction site practices during the construction phase,
environmental site audits on weekly basis is recommended throughout the construction period. |
Land site/ During construction |
Contractor(s)/ Environmental Team (ET) & Independent Environmental Checker (IEC) |
|
ü |
|
Implemented |
|
Note: D - Design stage
C - Construction O - Operation
EIA Reference |
Recommended
Environmental Protection Measures/ Mitigation Measures |
Objectives of the recommended measures & main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
Noise |
||||||||
S5.7 |
Only well-maintained plant will
be operated on-site and plant will be serviced regularly during the construction phase. |
All area/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
A Practical Guide for the Reduction of Noise from Construction Works, |
S5.7 |
Silencers or mufflers
on construction equipment will be utilised and will be properly maintained during the construction phase. |
Noise control/ During construction |
Contractor(s) |
|
ü |
|
N/A |
A Practical Guide for the Reduction of Noise from Construction Works, |
S5.7 |
Mobile plant,
if any, will be sited
as far away from NSRs
as possible. |
Noise control/ During construction |
Contractor(s) |
|
ü |
|
N/A |
A Practical Guide for the Reduction of Noise from Construction Works, |
S5.7 |
Machines and plant (such as trucks) that may be in intermittent use will be shut down between work periods or will be throttled down to a minimum. |
Noise control/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
A Practical Guide
for the Reduction of Noise from
Construction Works, |
S5.7 |
Plants known to emit noise
strongly in one direction will,
wherever possible, be orientated so that the noise is directed
away from the nearby NSRs. |
Noise control/ During construction |
Contractor(s) |
|
ü |
|
N/A |
A Practical Guide
for the Reduction of Noise from
Construction Works, |
S5.7 |
Material stockpiles and other structures will be effectively utilised, wherever practicable, in screening noise from on-site
construction activities. |
Noise control/ During construction |
Contractor(s) |
|
ü |
|
N/A |
A Practical Guide
for the Reduction of Noise from
Construction Works, |
S5.7 |
Use of Quite Powered
Mechanical Equipment (QPME). |
Noise control/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
A Practical Guide
for the Reduction of Noise from
Construction Works, |
S5.7 |
Movable noise barriers of 3m in height with skid footing
should be used and located within a few metres of stationary
plant and mobile plant such that the
line of sight to the NSR is blocked by the barriers. The
length of the barrier should be at
least five times greater than its height. The noise barrier material should have a superficial surface density
of at least 7 kg m-2 and have no o
or gappeningss. |
Noise control/ During construction |
Contractor(s) |
|
ü |
|
N/A |
A Practical Guide
for the Reduction of Noise from Construction Works, |
S5.7 |
The noise insulating sheet
should be deployed such that there would be no opening or gaps on the
joints. |
Noise control/ During construction |
Contractor(s) |
|
ü |
|
N/A |
A Practical Guide for the Reduction of Noise from Construction Works, |
EIA Reference |
Recommended
Environmental Protection Measures/ Mitigation Measures |
Objectives of the recommended measures & main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
S5.7 |
Construction activities (e.g. excavation/shoring, reinstatement (asphalt), and pipe jacking) will be planned
and carried out in sequence, such that items of PME proposed for these activities will not be operated simultaneously. |
Noise control/ During construction |
Contractor(s) |
ü |
ü |
|
Implemented |
A Practical Guide for the Reduction of Noise from Construction Works |
S5.7 |
PMEs will not be used at the works areas
near educational institutions with residual impact (ie
the ¡§influence area¡¨ within a radius of 40m) during
school hours in order to reduce impact
to the educational institutions. |
Noise control / During construction |
Contractor(s) |
|
ü |
|
N/A |
A Practical Guide for the Reduction of Noise from Construction Works |
S5.7 |
Noise enclosures or acoustic sheds would be used to cover stationary PME such as generators. Portable/Movable noise enclosure made of material with superficial surface
density of at least 7 kg m-2 may be used for screening the noise from operation of the saw/groover, concrete. |
Noise control/ Pre- construction/ During construction |
Contractor(s) |
ü |
ü |
|
N/A |
|
S5.9 |
Sawcutting pavement, breaking up of pavement, excavation /shoring, pipe laying, backfilling, reinstatement (concrete) and pipe jacking shall be scheduled outside the examination period. |
Noise control/ Pre- construction/ During construction |
Contractor(s) |
ü |
ü |
|
N/A |
|
S5.9 |
In view the duration of noise exceedance at Creative Secondary School, PLK Laws Foundation
College, TKO Kei Tak Primary School
and School of Continuing and Professional Studies-CUHK is limited to
8 weeks, the construction work in the influence areas near the four schools shall
be scheduled during
long school holidays (eg summer holiday,
Easter holiday or Christmas
holiday, etc) as far as practicable. Scheduling the construction work for the four
schools. |
Noise control/ Pre- construction/ During construction |
Contractor(s) |
ü |
ü |
|
N/A |
|
S5.10 |
A noise monitoring programme shall be implemented for the
construction phase. |
Designated monitoring stations as defined in EM&A Manual/During construction phase |
Environmental Team (ET) |
|
ü |
|
N/A |
|
S5.10 |
The effectiveness of on-site
control measures could
also be evaluated through the regular site
audits. |
All facilities/ During construction |
Contractor(s)/ Environmental Team (ET) & Independent Environmental Checker (IEC) |
|
ü |
|
Implemented |
- |
Note: D - Design stage
C - Construction O -
Operation
EIA Reference |
Recommended Environmental Protection Measures/ Mitigation
Measures |
Objectives of the recommended measures & main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
Water Quality |
||||||||
S6.9 |
Dredged marine sediment will be disposed of in a gazetted marine disposal area in accordance with marine dumping permit conditions of the Dumping
at Sea Ordinance (DASO). |
Marine Dredging/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
Dumping at Sea Ordinance (DASO) |
S6.9 |
Disposal vessels
will be fitted
with tight bottom
seals in order to prevent leakage of material
during transport. |
Marine Dredging/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S6.9 |
Barges will be filled to a level, which ensures that material does not spill over during
transport to the disposal site and that adequate freeboard is maintained to ensure that the decks
are not washed
by wave action. |
Marine Dredging/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S6.9 |
After dredging, any excess materials will be cleaned from decks and exposed fittings before the
vessel is moved from the dredging
area. |
Marine Dredging/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S6.9 |
All vessels should be well maintained and inspected before use to limit any potential
discharges to the marine environment. |
Marine Dredging/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S6.9 |
All vessels must have a clean ballast system. |
Marine Dredging/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S6.9 |
No discharge of sewage/grey wastewater should be allowed. Waste water from potentially
contaminated area on working
vessels should be minimized and collected. These
kinds of wastewater should be brought back to port and discharged at
appropriate collection and treatment system. |
Marine Dredging/ During construction |
Contractor(s) |
|
ü |
|
Observation issued. Rectified after observation |
- |
S6.9 |
No soil waste is allowed to be disposed overboard. |
Marine Dredging/ During construction |
Contractor(s) |
|
ü |
|
N/A |
- |
EIA Reference |
Recommended Environmental Protection Measures/ Mitigation
Measures |
Objectives of the recommended measures & main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
S6.9 |
Silt removal
facilities such as silt traps
or sedimentation facilities will be provided to
remove silt particles from runoff to meet the requirements of the TM standard under the WPCO.
The design of silt removal
facilities will be based on the guidelines provided in ProPECC PN 1/94.
All drainage facilities and erosion and sediment control structures will be inspected on a regular basis and maintained to confirm proper and efficient |
Land site & drainage/ During construction |
Contractor(s) |
|
ü |
|
Implemented, reminder issued. |
ProPECC PN 1/94 TM Standard under the WPCO |
S6.9 |
Earthworks to form
the final surfaces will be followed up with surface protection and drainage works to prevent erosion caused by rainstorms. |
Land site & drainage/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S6.9 |
Appropriate
surface drainage will be
designed and provided where necessary. |
Land site & drainage/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S6.9 |
The precautions to be taken at any time of year when rainstorms are likely together with the
actions to be taken when a rainstorm is imminent or forecasted and actions
to be taken during or after rainstorms are
summarised in Appendix A2 of ProPECC PN 1/94. |
Land site & drainage/ During construction |
Contractor(s) |
ü |
ü |
|
Implemented |
ProPECC PN 1/94 |
S6.9 |
Oil interceptors will be provided in the drainage system where necessary and regularly
emptied to prevent the release of
oil and grease into the storm water
drainage system after accidental spillages. |
Land site & drainage/ During construction |
Contractor(s) |
|
ü |
|
N/A |
- |
S6.9 |
Temporary and permanent drainage pipes and culverts provided to facilitate runoff discharge, if any, will be adequately designed for the controlled release
of storm flows. |
Land site & drainage/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S6.9 |
The temporary diverted drainage, if any, will be reinstated to the original condition
when the construction work has finished
or when the temporary diversion is no longer required. |
Land site & drainage/ During construction |
Contractor(s) |
|
ü |
|
N/A |
- |
S6.9 |
Appropriate numbers of portable toilets shall be provided by a licensed contractor to
serve the construction workers over
the construction site to prevent
direct disposal of sewage into the water environment. |
Land site & drainage/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
EIA Reference |
Recommended Environmental Protection Measures/ Mitigation
Measures |
Objectives of the recommended measures & main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
S6.9 and S6.12 |
The sterilization water should be dechlorinated with total
residual chlorine (TRC)
level below 1 mg/L before
discharge to public
sewer. In situ
testing of TRC should also be conducted for the discharge of chlorinated water
for pipeline disinfection to ensure sufficient dechlorination before discharge to public sewer. |
Sterilization of water mains prior to commissioning |
Contractor(s) |
|
ü |
ü |
N/A |
Technical Memorandum for Effluents Discharged into Drainage and Sewerage Systems Inland
and Coastal Waters |
S6.9 |
The cleaning and flushing water should also be treated and desilted to the relevant discharge
requirement stipulated in TM-DSS
before discharging. |
Sterilization of water mains prior to commissioning |
Contractor(s) |
|
ü |
ü |
N/A |
Technical Memorandum for Effluents Discharged into Drainage and Sewerage Systems Inland
and Coastal Waters |
S6.9 |
Site drainage should be well maintained and good construction practices should be observed
to ensure that oil, fuels,
solvents and other chemicals are managed, stored
and handled properly and do not enter the nearby water streams. |
Land site & drainage/ During construction/ During operation |
Contractor(s) |
|
ü |
ü |
Implemented, reminder and observation issued.
Rectified after observation. |
- |
S6.12 |
Regular site inspections will be carried out in order to confirm
that regulatory requirements are being met and that contractors are implementing the
standard site practice and mitigation measures as proposed to reduce potential impacts to water quality. |
During construction |
Contractor(s)/ Environmental Team (ET) & Independent Environmental Checker
(IEC) |
|
ü |
|
Implemented |
- |
Note: D - Design
stage C - Construction O - Operation
EIA Reference |
Recommended Environmental Protection Measures/ Mitigation Measures |
Objectives of the recommended measures & main concerns
to address |
Implementation Agent |
Implementation Stage |
Implementation Status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
Waste Management |
||||||||
S8.5 |
Nomination of approved personnel to be responsible for standard site practices, arrangements for collection and effective disposal
to an appropriate facility of all wastes generated at the site. |
Contract mobilisation/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S8.5 |
Training of site personnel in proper waste management and chemical handling procedures. Training will be provided to workers on the concepts of site
cleanliness and appropriate waste management procedures, including waste reduction, reuse and recycling at the beginning of the
construction works. |
Contract mobilisation/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S8.5 |
Provision of sufficient waste
disposal points and regular collection for disposal. |
All area/ During construction/ During operation |
Contractor(s) |
|
ü |
ü |
Implemented, reminder issued |
DEVB TC(W) No. 8/2010, Enhanced Specification for Site
Cleanliness and Tidiness. |
S8.5 |
Appropriate measures to reduce windblown litter and dust transportation of waste by either covering trucks or by transporting wastes in enclosed
containers. |
All area/
During construction |
Contractor(s) |
|
ü |
|
Implemented |
DEVB TC(W) No. 8/2010, Enhanced Specification for Site Cleanliness and Tidiness. |
S8.5 |
A waste management plan (WMP) as stated in the ¡§ETWB
TC(W) No. 19/2005, Environmental Management on Construction Sites¡¨ for the
amount of waste generated, recycled and disposed of
(including the disposal
sites) will be established and implemented during the construction phase as part of
the Environmental Management Plan
(EMP). The Contractor
will be required to prepare the EMP and submits it to the Architect/ Engineer under the Contract for approval prior to implementation. |
All area/
During construction |
Contractor(s) |
|
ü |
|
Implemented |
ETWB TC(W) No. 19/2005, Environmental Management on Construction Sites |
S8.5 |
Separation of chemical wastes
for special handling and appropriate
treatment at the Chemical Waste Treatment
Centre at Tsing Yi. |
All area/
During construction |
Contractor(s) |
|
ü |
|
Implemented, reminder and observation issued.
Rectified after observation. |
Chapters 2 & 3 Code of Practice on the Packaging, Labelling & Storage of Chemical Wastes published under the Waste Disposal Ordinance (Cap 354), Section 35 |
S8.5 |
Regular cleaning and maintenance programme for drainage
systems, sumps and oil interceptors. |
Land site/
During construction |
Contractor(s) |
|
ü |
|
Implemented, reminder issued. |
Waste Disposal Ordinance (Cap 354) |
EIA Reference |
Recommended Environmental Protection Measures/ Mitigation Measures |
Objectives of the recommended measures & main concerns
to address |
Implementation Agent |
Implementation Stage |
Implementation Status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
S8.5 |
A recording system for the amount of wastes generated/ recycled and disposal sites. The trip- ticket
system will be included as one of the contractual requirements and implemented by the contractor(s). |
Land site/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
DEVB TC(W) No. 6/2010, Trip Ticket System for Disposal of Construction & Demolition Materials |
S8.5 |
Segregation and storage of different types of waste in different containers, skips or stockpiles to enhance
reuse or recycling of material and their proper
disposal. |
Land site/ During construction/ During
operation |
Contractor(s) |
|
ü |
|
Implemented, reminder issued. |
WBTC 32/92,
The Use of Tropical
Hard Wood on Construction Site |
S8.5 |
Encourage collection of aluminium cans and waste paper
by individual collectors during construction with
separate labelled bins provided to segregate these wastes from other general refuse by the
workforce. |
Land site/
During construction |
Contractor(s) |
|
ü |
|
Implemented |
ETWB TCW No. 33/2002, Management of Construction and Demolition Material Including Rock |
S8.5 |
Any unused chemicals and those with remaining functional capacity will be recycled as
far as possible. |
Land site/ During construction |
Contractor(s) |
|
ü |
|
N/A |
- |
S8.5 |
Use of reusable non-timber formwork to reduce
the amount of C&D materials. |
All areas/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
WBTC 32/92,
The Use of Tropical
Hard Wood on Construction Site |
S8.5 |
Prior to disposal of construction waste,
wood, steel and other metals
will be separated to the extent practical, for re-use
and/or recycling to reduce the quantity of
waste to be disposed of to landfill. |
All
areas/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
DEVB TC(W) No. 6/2010, Trip Ticket
System for Disposal of Construction & Demolition Materials |
S8.5 |
Proper storage and site practices to reduce the potential for damage or contamination of construction materials. |
All areas/ During construction |
Contractor(s) |
|
ü |
|
Implemented, reminder and observation issued.
Rectified after observation. |
- |
S8.5 |
Plan and stock construction materials carefully to reduce amount of waste generated and
avoid unnecessary generation of
waste. |
All areas/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S8.5 |
A Sediment Quality Report (SQR) for sampling and chemical testing of the sediment will be
prepared and submitted to the EPD
for approval. The approved detailed sampling and chemical testing
will be carried out prior to the commencement of the dredging activities to confirm the sediment
disposal method. |
Marine works/ During construction |
Contractor(s) |
|
ü |
|
N/A |
ETWB TC(W) No. 34/2002 and Dumping at Sea Ordinance (DASO) |
S8.5 |
The management
of dredged/ excavated sediment management
requirement from ETWB TC(W) No. 34/2002
will be incorporated in the Specification of the Contract Documents. |
Marine works/ During construction |
WSD/ Contractor(s) |
|
ü |
|
Implemented |
ETWB TC(W) No. 34/2002 and Dumping
at Sea Ordinance (DASO) |
EIA Reference |
Recommended Environmental Protection Measures/ Mitigation Measures |
Objectives of the recommended measures & main concerns
to address |
Implementation Agent |
Implementation Stage |
Implementation Status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
S8.5 |
The contractor will open a billing account with EPD in accordance with the Waste Disposal
(Charges for Disposal of
Construction Waste) Regulation for the payment
of disposal charges. |
Contract mobilisation/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
Cap 354N Waste Disposal (Charges for Disposal of Construction Waste) Regulation |
S8.5 |
A trip-ticket system will be established in accordance with DEVB TC(W) No. 6/2010 to monitor
the reuse of surplus excavated
materials off-site and disposal of construction
waste and general refuse at transfer facilities/
landfills, and to control fly-tipping. |
Contract mobilisation/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
DEVB TC(W) No. 6/2010, Trip Ticket System for Disposal of Construction &
Demolition Materials |
S8.5 |
The project proponent will also conduct regular inspection of the waste management
measures implemented on site as
described in the Waste Management Plan. |
All area/
During construction |
Contractor(s)/ Environmental Team (ET) & Independent Environmental Checker (IEC) |
|
ü |
|
Implemented |
ETWB TC(W) No. 19/2005, Environmental Management on Construction Sites |
S8.5 |
A recording system
(similar to summary
table as shown in
Annex 5 and Annex 6 of Appendix G of ETWB TC(W) No. 19/2005) for the amount of waste generated, recycled and disposed of (including
the disposal sites) will be established during the construction phase. |
All area/
During construction |
Contractor(s) |
|
ü |
|
Implemented |
Annex 5 and Annex
6 of Appendix G of ETWB TC(W) No. 19/2005 |
S8.5 |
Inert C&D materials (public
fill) will be reused
within the Project as far as
practicable. |
All area/
During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S8.5 |
Public fill and
construction waste shall
be segregated and stored in different containers or skips to
facilitate reuse or recycling of materials and their proper disposal. |
All area/
During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S8.5 |
Specific areas
of the work
site will be designated for such segregation and storage if immediate use
is not practicable. |
All area/
During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S8.5 |
To reduce the potential dust
and water quality impacts of site formation works,
C&D materials will be wetted
as quickly as possible to
the extent practice after filling. |
All area/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
Air Pollution Control (Construction Dust) Regulation (Cap 311R); WPCO (Cap 358) |
S8.5 |
Open stockpiles of excavated/ fill
materials or construction wastes
on-site should be covered with tarpaulin
or similar fabric. |
Land site/ During Construction, particularly dry season |
Contractor(s) |
|
ü |
|
Implemented, reminder issued. |
Air
Pollution Control (Construction Dust)
Regulation (Cap 311R) |
S8.5 |
Chemical waste container shall be suitable for the substance they are holding, resistant to corrosion, |
All area/ During construction/ During operation |
Contractor(s)/ WSD |
|
ü |
ü |
Implemented |
Waste Disposal (Chemical Waste) (General) |
EIA Reference |
Recommended Environmental Protection Measures/ Mitigation Measures |
Objectives of the recommended measures & main concerns
to address |
Implementation Agent |
Implementation Stage |
Implementation Status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
|
maintained in a good condition, and securely closed. |
|
|
|
|
|
|
Regulation; Code of Practice on the Packaging, Handling and Storage
of Chemical Wastes |
S8.5 |
Chemical waste container shall have a capacity of less than 450 L unless the specifications have been approved by the EPD. |
All area/ During construction/ During
operation |
Contractor(s)/ WSD |
|
ü |
ü |
Implemented |
Waste Disposal (Chemical Waste) (General) Regulation; Code of Practice on the Packaging, Handling and Storage
of Chemical Wastes |
S8.5 |
A label in English and Chinese shall
be displayed on the chemical container in accordance with
instructions prescribed in Schedule
2 of the Regulations. |
All area/ During construction/ During operation |
Contractor(s)/ WSD |
|
ü |
ü |
Implemented |
Waste Disposal (Chemical Waste) (General) Regulation; Code of Practice on the Packaging, Handling and Storage
of Chemical Wastes |
S8.5 |
Storage areas
for chemical waste
shall be enclosed on at least 3 sides. |
All area/ During construction/ During operation |
Contractor(s)/ WSD |
|
ü |
ü |
Implemented |
Waste Disposal (Chemical Waste) (General) Regulation; Code of Practice on the Packaging, Handling and Storage
of Chemical Wastes |
S8.5 |
Storage areas for chemical waste shall have an impermeable floor and bunding, of capacity to accommodate 110% of the volume of the
largest container or 20% by volume
of the chemical waste stored in
that area, whichever is the greatest. |
All area/ During construction/ During operation |
Contractor(s)/ WSD |
|
ü |
ü |
Implemented |
Waste Disposal (Chemical Waste) (General) Regulation; Code of Practice on the Packaging, Handling and Storage
of Chemical Wastes |
S8.5 |
Storage areas
for chemical waste
shall have adequate ventilation. |
All area/ During construction/ During operation |
Contractor(s)/ WSD |
|
ü |
ü |
Implemented |
Waste Disposal (Chemical Waste) (General) Regulation; Code of Practice on the Packaging, Handling and Storage of Chemical Wastes |
S8.5 |
Storage areas for chemical waste shall be covered to prevent rainfall entering (water
collected within the bund must be tested
and disposed of as chemical waste, if necessary). |
All area/ During construction/ During operation |
Contractor(s)/ WSD |
|
ü |
ü |
Implemented |
Waste Disposal (Chemical Waste) (General) Regulation; Code of Practice on the Packaging, Handling and Storage
of Chemical Wastes |
EIA Reference |
Recommended Environmental Protection Measures/ Mitigation Measures |
Objectives of the recommended measures & main concerns
to address |
Implementation Agent |
Implementation Stage |
Implementation Status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
S8.5 |
Storage areas for chemical waste shall be arranged so that incompatible materials are
appropriately separated. |
All area/ During construction/ During operation |
Contractor(s)/ WSD |
|
ü |
ü |
Implemented |
Waste Disposal (Chemical Waste) (General) Regulation; Code of Practice on the Packaging, Handling and Storage
of Chemical Wastes |
S8.5 |
General refuse will be stored in enclosed bins or compaction units separately from
construction and chemical wastes. |
All area/ During construction/ During operation |
Contractor(s)/ WSD |
|
ü |
ü |
Implemented, reminder issued. |
Waste Disposal (Chemical Waste) (General) Regulation; Code of Practice on the Packaging, Handling and Storage
of Chemical Wastes |
S8.5 |
Adequate number of waste containers will be provided to avoid over-spillage of waste. |
All area/ During construction/ During operation |
Contractor(s)/ WSD |
|
ü |
ü |
Implemented |
DEVB TC(W) No. 8/2010 Enhanced Specification for Site Cleanliness
and Tidiness. |
S8.5 |
A reputable waste collector will be employed by the Contractor to remove general refuse from
the site, separately from construction and chemical wastes,
on a daily basis
to minimise odour,
pest and litter
impacts. |
All area/ During construction/ During operation |
Contractor(s)/ WSD |
|
ü |
ü |
Implemented |
- |
S8.5 |
Recycling bins will be provided at strategic locations within the Site to facilitate recovery
of recyclable materials (including aluminium can, waste
paper, glass bottles and plastic bottles) from the
Site. Materials recovered will be sold
for recycling. |
All area/ During construction/ During operation |
Contractor(s)/ WSD |
|
ü |
ü |
Implemented |
- |
S8.5 |
To avoid any odour and litter impact,
accurate number of portable toilets will be provided for workers on-site. |
All area/
During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S8.5 |
The burning of refuse on construction sites is prohibited by law. |
All area/
During construction |
Contractor(s) |
|
ü |
|
Implemented |
Air Pollution Control Ordinance (Cap 311) |
S8.7 |
To facilitate monitoring and control over the contractors¡¦ performance on waste management, a waste inspection and audit programme will be implemented throughout the construction phase. |
All facilities/ During construction |
ET/ IEC |
|
ü |
|
Implemented |
- |
Note: D - Design
stage C - Construction O - Operation
|
Recommended Environmental Protection Measures/ Mitigation Measures |
Objectives of the recommended measures & main concerns
to address |
Implementation Agent |
Implementation Stage |
Implementation Status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
|
Ecology |
|||||||
S9.7 |
For slope mitigation works within the Clear Water
Bay Country Park, to avoid tree
felling and damages to trees, the
exact locations of the flexible barrier foundation
plates, soil nails and rock dowels can be adjusted
during detailed design, and a setback distance from existing trees
is recommended to be maintained as far as practical. A detailed specification describing the
exact locations of the flexible
barrier foundation plates, soil
nails and rock dowels will be
prepared to illustrate how the setback
distance from existing trees would be implemented for tree avoidance. |
Slope mitigation works area/ During detailed design/ During construction |
Contractor(s) |
ü |
ü |
|
N/A |
- |
S9.7 |
Pruning of tree
canopies along the
alignment of the flexible barriers shall
be limited to a minimum. |
Slope mitigation works area/ During
construction |
Contractor(s) |
|
ü |
|
N/A |
|
S9.7 |
The alignment of flexible barriers shall be optimized to preserve all
species of conservation interest and minimize the impact to the existing vegetation as far as practicable. All individuals of Marsdenia
lachnostoma within the
slope mitigation areas shall be
retained in- situ, by positioning the
alignment of flexible
barrier at a minimum 1.5m in a radius away from these individuals. |
Slope mitigation works area/ During detailed design/ During construction |
Contractor(s) |
ü |
ü |
|
N/A |
- |
S9.7 and 9.10 |
At the detailed design stage prior to the commencement of the slope mitigation works, a vegetation survey shall be carried out
at the slope mitigation areas
within the Clear Water Bay Country Park to assess the condition and identify the location of each
individual of Marsdenia lachnostoma and
other flora species of conservation interest that may be directly affected by the construction works. |
Slope mitigation works area/ During detailed design/ During construction |
Contractor(s) |
ü |
|
|
Implemented |
- |
S9.7 |
Temporary fencing will be installed to fence off the concerned species either in groups of
individually within the works area
and in the close proximity to prevent
from being damaged and disturbed during construction. A sign identifying the site shall
be attached to the fence and flagging tape shall be attached to the individuals to visualize their
locations. |
Slope mitigation
works area/ During construction |
Contractor(s) |
|
ü |
|
N/A |
- |
S9.7 and S9.10 |
A specification for fencing and demarcating individuals of Marsdenai lachnostoma (or
other flora species of conservation interest, if found) adjacent to the |
Slope mitigation
works area/ During construction |
Contractor(s) |
|
ü |
|
N/A |
- |
|
Recommended Environmental Protection Measures/ Mitigation Measures |
Objectives of the recommended measures & main concerns
to address |
Implementation Agent |
Implementation Stage |
Implementation Status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
|
proposed alignment of the flexible barriers will be prepared to protect
the species. |
|
|
|
|
|
|
|
S9.7 |
Induction training shall also be provided to all site personnel in order to brief them on this
flora of conservation interest including the locations and their importance. |
Slope mitigation
works area/ During construction |
Contractor(s) |
|
ü |
|
N/A |
- |
S9.7 |
The resident site supervisory staff
will closely monitor the conditions of concerned individuals during construction of flexible barriers in the close
proximity. |
Slope mitigation
works area/ During construction |
Contractor(s) |
|
ü |
|
N/A |
- |
S9.7 |
Erect fences along the boundary of the works area before
the commencement of works to prevent vehicle
movements and encroachment of personnel onto adjacent areas. |
All area/
During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S9.7 |
Regularly check
the work site boundaries to ensure that
they are not breached and that damage does not occur to surrounding areas. |
All area/ During construction |
Contractor(s)/ Environmental Team (ET) |
|
ü |
|
Implemented. |
- |
S9.7 |
Avoid any damage and
disturbance, particularly those
caused by filling and illegal dumping, to the surrounding habitats through
proper management of waste disposal. |
All area/
During construction |
Contractor(s) |
|
ü |
|
Implemented |
- |
S9.7 |
Reinstate temporarily affected areas, particularly the habitats of plantation and
shrubland-grassland immediately
after completion of construction works, through
on-site tree/shrub planting. The
tree/shrub species will be chosen
with reference to those in the surrounding area. |
All area/
During construction |
Contractor(s) |
|
ü |
|
N/A |
- |
S9.7 |
Affected habitats within the Clear Water Bay Country Bay shall be reinstated by hydro-seeding and planting of climbers and native shrub
seedlings where practical upon completion of the slope mitigation works. |
All area/
During construction |
Contractor(s) |
|
ü |
|
N/A |
- |
Note: D - Design
stage C - Construction O - Operation
EIA Reference |
Recommended Environmental Protection Measures/ Mitigation Measures |
Objectives
of the recommended measures &
main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation Status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
|
Landscape & Visual |
|||||||
S11.10 &
11.11 |
The construction area
and area allowed
for temporary structures, such as the
contractor¡¦s office, will be minimized
to a practical minimum. (MM1) |
All area/ Detailed design/
During construction/ During operation |
WSD/ Contractor(s) |
ü |
ü |
ü |
Implemented |
- |
S11.10 &
11.11 |
At the detailed design stage, the design
team will seek to minimize the landscape footprint of the Project and above ground facilities, while satisfying all other requirements.
(MM2) |
All area/ Detailed design/
During construction/ During operation |
WSD/ Contractor(s) |
ü |
ü |
ü |
Implemented |
- |
S11.10 &
11.11 |
Design principles will
be adopted to take into account the surrounding area,
particularly Clear Water
Bay Country Park behind and the nearby
waterfront, with due
consideration given to: - green roofs
where practical (ie without equipment on the roof); - roadside planting; - aesthetic treatment of all structures; - vertical greening; - screen planting along application site; and - landscape enhancement with amenity planting where practical including planting along the edge (site boundary) fence with native
shrubs where feasible,
to reduce their
visual impact and blend
them into the surrounding landscape. (MM3) |
All area/ Detailed design/
During construction/ During operation |
WSD/ Contractor(s) |
ü |
ü |
ü |
Implemented |
- |
S11.10 &
11.11 |
All trees within
the Project Site or the potential slope
mitigation works area
will be carefully protected during construction according to DEVB
TCW No. 10/2013 - Tree Preservation (MM4) |
All area/ Detailed design/
During construction/ During operation |
WSD/ Contractor(s) |
ü |
ü |
ü |
Implemented |
ETWB TCW No. 3/2006
- Tree Preservation. |
S11.10 &
11.11 |
No tree within the Country Park will be felled. Trees within the Site unavoidably affected by the works will be transplanted where necessary and
practical. For trees
that need to be felled, compensatory planting
will be provided to the
satisfaction of relevant Government departments. A compensatory tree planting proposal including locations of tree compensation will be submitted to seek relevant government department¡¦s approval, in accordance with
DEVB TC(W) No.
10/2013. (MM5) |
All area/ Detailed design/
During construction/ During operation |
WSD/ Contractor(s) |
ü |
ü |
ü |
Implemented |
DEVB TC(W) No. 10/2013 |
S11.10 &
11.11 |
Any slope
mitigation works necessary to address natural
terrain hazards, will be minimized
to minimize any potential
environmental impact to the Country
Park e.g. soil nailing and rock stabilization will aim to avoid existing trees e.g. should
any restoration of vegetation be |
All
area/ Detailed design/ During
construction/ During operation |
WSD/ Contractor(s) |
ü |
ü |
ü |
N/A |
|
EIA Reference |
Recommended Environmental Protection Measures/ Mitigation Measures |
Objectives
of the recommended measures &
main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation Status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
|
necessary, the best planting matrix with native species
will be established, with the aim
of resembling the existing vegetation. (MM6) |
|
|
|
|
|
|
|
S11.10 &
11.11 |
Dredging works for the installation of intake structures and outfall diffusers should be minimized to avoid or reduce any potential environmental impacts to as low as reasonably practicable (ALARP). The intake
and outfall structures (e.g. intake
openings and diffuser heads) will be prefabricated and transferred to site
for installation. (MM7) |
All area/ Detailed design/
During construction/ During operation |
WSD/ Contractor(s) |
ü |
ü |
ü |
Implemented |
|
S11.10 &
11.11 |
All night-time lighting will
be reduced to a practical minimum both in terms of number of level and will be
hooded and directional. (MM8) units
and lux level
and will be hooded and directional. (MM8) |
All area/ Detailed design/
During construction/ During operation |
WSD/ Contractor(s) |
ü |
ü |
ü |
Implemented |
- |
Note: D - Design stage C
- Construction O - Operation
EIA Reference |
Recommended Environmental Protection Measures/ Mitigation Measures |
Objectives of the
recommended measures & main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation Status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
|
Landfill Gas Hazard |
|||||||
S12.7 |
During all works,
safety procedures should
be implemented to minimise the risks of fires and explosions, asphyxiation of workers and
toxicity effects resulting from contact with contaminated soil
and groundwater. |
All area/ Detailed design/ During construction/ During
operation |
Contractor(s) |
ü |
ü |
ü |
Implemented |
- |
S12.7 |
During trenching and excavation as well as creation of confined spaces
at near to or below ground
level, precautions should be
clearly laid down and rigidly Gas detection equipment and appropriate breathing apparatus should
be available and used when
entering confined spaces or trenches deeper than 1 metre. |
All area/ Detailed design/ During construction/ During
operation |
Contractor(s) |
ü |
ü |
ü |
Implemented |
|
S12.7 |
The Contractor should
make the workers are aware of potential hazards
of working in confined spaces
(any chamber, manhole or culvert which
is large enough to permit access to personnel). Such work
in confined spaces is controlled by
the Factories and Industrial Undertakings (Confined
Spaces) Regulations of the Factories
and Industrial Undertakings Ordinance. Following the
Safety Guide to Working in Confined Spaces
ensures compliance with the above
regulations. |
All area/ Detailed design/ During construction/ During
operation |
Contractor(s) |
ü |
ü |
ü |
Implemented |
|
S12.7 |
Safety officers, specifically trained with regard to landfill gas and leachate related hazards and the appropriate
actions to take in adverse circumstances, should be present on the site throughout
the works, in particular, when
works are undertaken below grade. |
All area/ Detailed design/ During construction/ During
operation |
Contractor(s) |
ü |
ü |
ü |
Implemented |
|
S12.7 |
All personnel who work on site and all visitors to the site
should be made aware of the possibility of ignition of gas
in the vicinity of the works,
the possible presence of contaminated water
and the need to avoid
physical contact with it. |
All area/ Detailed design/ During construction/ During
operation |
Contractor(s) |
ü |
ü |
ü |
Implemented |
|
S12.7 |
Monitoring for landfill gas should be undertaken in all excavations, manholes, chambers (particularly during pipe jacking) and any confined spaces through the use of an intrinsically safe portable
instrument, appropriately calibrated and capable of measuring the concentrations of methane. carbon
dioxide and oxygen. |
All area/ Detailed design/ During construction/ During
operation |
Contractor(s) |
ü |
ü |
ü |
Implemented |
|
S12.7 |
Monitoring frequency and areas
to be monitored should be specified prior
to commencement of groundwork, either
by the Safety
Officer, or by an
appropriately qualified person. All
measurements should be recorded and documented. |
All area/ Detailed design/ During construction/ During
operation |
Contractor(s) |
ü |
ü |
ü |
Implemented |
|
EIA Reference |
Recommended Environmental Protection Measures/ Mitigation Measures |
Objectives of the
recommended measures & main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation Status |
Relevant Legislation & Guidelines |
||
D |
C |
O |
||||||
S12.7 |
Proceed drilling with adequate care and precautions against the potential hazards which may be encountered. |
All area/ Detailed design/ During
construction/ During
operation |
Contractor(s) |
ü |
ü |
ü |
Implemented |
|
S12.7 |
Prior to the commencement of the site works, the drilling contractor should
devise a 'method-of- working' statement covering all normal and emergency
procedures (including but not limited to number
of operatives, experience and special skills of operatives, normal method
of operations, emergency procedures,
supervisors responsibilities, storage
and use of safety equipment, safety
procedures and signs, barriers and guarding). The site
supervisor and all
operatives must be familiar with this statement. |
All area/ During construction/ During operation |
Contractor(s) |
ü |
ü |
ü |
Implemented |
|
S12.7 |
Where below
ground service entries are necessary to the
Incoming Switchgear Room, 132 kV Substation and Chlorine Store (I) and (II), the entry
point should be sealed to prevent gas entry. In addition, any below grade
cable trenches entering the Incoming Switchgear Room and 132 kV Substation can become the pathway for landfill gas and hence grilled metal covers should be used. |
All area/ Detailed design/ During construction/ During
operation |
Contractor(s) |
ü |
ü |
ü |
N/A |
|
S12.7 |
It is recommended regular landfill gas monitoring should be carried out at the Incoming
Switchgear Room, 132 kV Substation
and Chlorine Store (I) and (II).
The monitoring frequency will be monthly
for the first
year of operation. If the monitoring results show no sign of landfill gas migration, reduce the monitoring frequency to once every six months. |
All area/ Detailed design/ During construction/ During
operation |
Contractor(s) |
ü |
ü |
ü |
N/A |
|
S12.7 |
The manholes and utility pits within the Project Site and along
the fresh water mains. Each manhole/ utility pit should be monitored with two measurements (at mid depth and base).
Each measurement should
be monitored for a minimum
of 10 minutes. A steady reading and
peak reading should be recorded at each manhole/ utility pit and for each measurement. The need
for venting the manhole/ utility pit and further monitoring will be reviewed after the initial monitoring. |
All area/ Detailed design/ During construction/ During
operation |
Contractor(s) |
ü |
ü |
ü |
Implemented |
|
S12.7 |
All construction, operation and maintenance personnel working on-site as well as visitors should
be made aware
of the hazards of landfill gas and its possible presence on-site. This should
be achieved through
a combination of posting warning signs in prominent places and also by access to detailed information on landfill gas hazards and the designs
and procedural means
by which these hazards are being minimized on-site. |
All area/ Detailed design/ During construction/ During
operation |
Contractor(s) |
ü |
ü |
ü |
Implemented |
|
Note: D - Design stage C
- Construction O - Operation
Appendix D
Water Quality Monitoring Graphical Presentation
Appendix E
Summary of Exceedances
Table E1 Summary of Exceedance in December 2021
Date |
Station |
Tide |
SS Level
(mg/L) |
Action Level |
Limit Level |
02/12/2021 |
WSR3 |
Mid-flood |
5.2 |
Y |
N |
WSR4 |
Mid-flood |
6.2 |
Y |
Y |
|
WSR16 |
Mid-flood |
6.5 |
Y |
Y |
|
WSR33 |
Mid-flood |
5.7 |
Y |
N |
|
WSR3 |
Mid-ebb |
5.2 |
Y |
Y |
|
04/12/2021 |
WSR3 |
Mid-flood |
5.3 |
Y |
N |
WSR37 |
Mid-flood |
8.3 |
Y |
Y |
|
WSR1 |
Mid-ebb |
5.8 |
Y |
N |
|
WSR2 |
Mid-ebb |
5.3 |
Y |
N |
|
WSR3 |
Mid-ebb |
5.2 |
Y |
N |
|
WSR33 |
Mid-ebb |
6.5 |
Y |
Y |
|
WSR36 |
Mid-ebb |
6.0 |
Y |
Y |
|
WSR37 |
Mid-ebb |
5.7 |
Y |
N |
|
09/12/2021 |
WSR16 |
Mid-flood |
7.0 |
Y |
Y |
WSR33 |
Mid-flood |
7.7 |
Y |
Y |
|
WSR36 |
Mid-flood |
5.8 |
Y |
N |
|
WSR37 |
Mid-flood |
6.2 |
Y |
N |
|
WSR1 |
Mid-ebb |
24.3 |
Y |
Y |
|
WSR33 |
Mid-ebb |
15.5 |
Y |
Y |
|
WSR36 |
Mid-ebb |
21.0 |
Y |
Y |
|
WSR37 |
Mid-ebb |
14.0 |
Y |
Y |
|
11/12/2021 |
WSR1 |
Mid-flood |
6.5 |
Y |
Y |
WSR4 |
Mid-flood |
5.7 |
Y |
Y |
|
WSR16 |
Mid-flood |
7.0 |
Y |
Y |
|
WSR33 |
Mid-flood |
14.0 |
Y |
Y |
|
WSR36 |
Mid-flood |
14.5 |
Y |
Y |
|
WSR37 |
Mid-flood |
18.3 |
Y |
Y |
|
WSR4 |
Mid-ebb |
7.5 |
Y |
Y |
|
WSR16 |
Mid-ebb |
9.7 |
Y |
Y |
|
WSR33 |
Mid-ebb |
13.7 |
Y |
Y |
|
WSR36 |
Mid-ebb |
22.0 |
Y |
Y |
|
WSR37 |
Mid-ebb |
11.8 |
Y |
Y |
|
14/12/2021 |
WSR4 |
Mid-ebb |
5.5 |
Y |
N |
WSR16 |
Mid-ebb |
5.2 |
Y |
N |
|
WSR36 |
Mid-ebb |
5.7 |
Y |
N |
Date |
Station |
Tide |
SS Level
(mg/L) |
Action Level |
Limit Level |
|
WSR37 |
Mid-ebb |
6.3 |
Y |
Y |
16/12/2021 |
WSR1 |
Mid-flood |
9.8 |
Y |
Y |
WSR3 |
Mid-flood |
9.0 |
Y |
Y |
|
WSR33 |
Mid-flood |
9.8 |
Y |
Y |
|
WSR36 |
Mid-flood |
10.0 |
Y |
Y |
|
WSR37 |
Mid-flood |
12.0 |
Y |
Y |
|
18/12/2021 |
WSR33 |
Mid-flood |
6.3 |
Y |
Y |
WSR36 |
Mid-flood |
6.3 |
Y |
Y |
|
WSR37 |
Mid-flood |
6.8 |
Y |
Y |
|
WSR2 |
Mid-ebb |
6.7 |
Y |
Y |
|
WSR3 |
Mid-ebb |
6.2 |
Y |
Y |
|
WSR4 |
Mid-ebb |
5.3 |
Y |
N |
|
WSR33 |
Mid-ebb |
6.2 |
Y |
Y |
|
WSR37 |
Mid-ebb |
6.0 |
Y |
N |
|
21/12/2021 |
WSR1 |
Mid-flood |
6.7 |
Y |
Y |
WSR3 |
Mid-flood |
6.3 |
Y |
N |
|
WSR4 |
Mid-flood |
9.0 |
Y |
Y |
|
WSR33 |
Mid-flood |
7.2 |
Y |
Y |
|
WSR36 |
Mid-flood |
9.0 |
Y |
Y |
|
WSR37 |
Mid-flood |
11.2 |
Y |
Y |
|
WSR2 |
Mid-ebb |
6.3 |
Y |
Y |
|
WSR3 |
Mid-ebb |
6.7 |
Y |
Y |
|
WSR4 |
Mid-ebb |
6.7 |
Y |
Y |
|
WSR33 |
Mid-ebb |
6.7 |
Y |
Y |
|
WSR37 |
Mid-ebb |
7.8 |
Y |
Y |
|
23/12/2021 |
WSR1 |
Mid-flood |
8.8 |
Y |
Y |
25/12/2021 |
WSR36 |
Mid-flood |
6.2 |
Y |
Y |
WSR37 |
Mid-flood |
7.0 |
Y |
Y |
|
WSR1 |
Mid-ebb |
14.2 |
Y |
Y |
|
WSR4 |
Mid-ebb |
7.8 |
Y |
Y |
|
WSR16 |
Mid-ebb |
7.0 |
Y |
Y |
|
WSR33 |
Mid-ebb |
5.8 |
Y |
N |
|
WSR36 |
Mid-ebb |
7.5 |
Y |
Y |
|
WSR37 |
Mid-ebb |
5.8 |
Y |
N |
|
28/12/2021 |
WSR2 |
Mid-flood |
8.8 |
Y |
Y |
WSR3 |
Mid-flood |
15.8 |
Y |
Y |
Date |
Station |
Tide |
SS Level
(mg/L) |
Action Level |
Limit Level |
|
WSR4 |
Mid-flood |
16.9 |
Y |
Y |
WSR16 |
Mid-flood |
14.3 |
Y |
Y |
|
WSR2 |
Mid-ebb |
10.3 |
Y |
Y |
|
WSR3 |
Mid-ebb |
17.2 |
Y |
Y |
|
WSR4 |
Mid-ebb |
16.8 |
Y |
Y |
|
WSR16 |
Mid-ebb |
15.8 |
Y |
Y |
|
WSR33 |
Mid-ebb |
5.2 |
Y |
N |
|
WSR36 |
Mid-ebb |
5.5 |
Y |
N |
|
30/12/2021 |
WSR2 |
Mid-flood |
9.0 |
Y |
N |
WSR3 |
Mid-flood |
9.0 |
Y |
N |
|
WSR4 |
Mid-flood |
10.0 |
Y |
Y |
|
WSR16 |
Mid-flood |
8.8 |
Y |
N |
|
WSR33 |
Mid-flood |
10.5 |
Y |
Y |
|
WSR36 |
Mid-flood |
8.8 |
Y |
N |
|
WSR1 |
Mid-ebb |
9.7 |
Y |
N |
|
WSR3 |
Mid-ebb |
11.5 |
Y |
Y |
Table E2 Summary of Exceedance in January 2022
Date |
Station |
Tide |
SS Level
(mg/L) |
Action Level |
Limit Level |
01/01/2022 |
WSR37 |
Mid-Flood |
8.8 |
Y |
Y |
WSR2 |
Mid-Ebb |
5.7 |
Y |
N |
|
WSR3 |
Mid-Ebb |
8.3 |
Y |
Y |
|
WSR4 |
Mid-Ebb |
6.2 |
Y |
Y |
|
WSR16 |
Mid-Ebb |
8.3 |
Y |
Y |
|
WSR37 |
Mid-Ebb |
6.5 |
Y |
Y |
|
04/01/2022 |
WSR1 |
Mid-Flood |
5.3 |
Y |
N |
WSR33 |
Mid-Flood |
6.3 |
Y |
Y |
|
WSR36 |
Mid-Flood |
5.7 |
Y |
N |
|
WSR37 |
Mid-Flood |
12.3 |
Y |
Y |
|
06/01/2022 |
WSR1 |
Mid-Ebb |
5.3 |
Y |
N |
WSR16 |
Mid-Ebb |
6.4 |
Y |
Y |
|
WSR33 |
Mid-Ebb |
6.8 |
Y |
Y |
|
08/01/2022 |
WSR2 |
Mid-Flood |
13.7 |
Y |
Y |
WSR3 |
Mid-Flood |
17.5 |
Y |
Y |
|
WSR4 |
Mid-Flood |
19.7 |
Y |
Y |
|
WSR16 |
Mid-Flood |
9.0 |
Y |
Y |
|
WSR36 |
Mid-Flood |
7.0 |
Y |
Y |
|
WSR37 |
Mid-Flood |
6.3 |
Y |
N |
|
WSR1 |
Mid-Ebb |
5.5 |
Y |
N |
|
WSR2 |
Mid-Ebb |
5.7 |
Y |
N |
|
WSR3 |
Mid-Ebb |
6.3 |
Y |
Y |
|
WSR4 |
Mid-Ebb |
6.7 |
Y |
Y |
|
WSR16 |
Mid-Ebb |
5.5 |
Y |
N |
|
WSR37 |
Mid-Ebb |
15.8 |
Y |
Y |
|
11/01/2022 |
WSR3 |
Mid-Flood |
7.2 |
Y |
N |
WSR36 |
Mid-Flood |
7.2 |
Y |
N |
|
WSR4 |
Mid-Ebb |
10.5 |
Y |
Y |
|
WSR16 |
Mid-Ebb |
5.5 |
Y |
N |
|
15/01/2022 |
WSR3 |
Mid-Ebb |
7.6 |
Y |
Y |
18/01/2022 |
WSR1 |
Mid-Ebb |
8.5 |
Y |
N |
20/01/2022 |
WSR16 |
Mid-Flood |
5.5 |
Y |
N |
WSR36 |
Mid-Flood |
7.0 |
Y |
Y |
|
WSR37 |
Mid-Flood |
5.5 |
Y |
N |
|
WSR16 |
Mid-Ebb |
7.2 |
Y |
Y |
|
WSR33 |
Mid-Ebb |
8.7 |
Y |
Y |
|
WSR36 |
Mid-Ebb |
6.7 |
Y |
Y |
|
WSR37 |
Mid-Ebb |
7.8 |
Y |
Y |
|
22/01/2022 |
WSR4 |
Mid-Flood |
10.7 |
Y |
Y |
WSR33 |
Mid-Flood |
5.3 |
Y |
N |
Date |
Station |
Tide |
SS Level
(mg/L) |
Action Level |
Limit Level |
|
WSR37 |
Mid-Flood |
5.7 |
Y |
N |
WSR3 |
Mid-Ebb |
5.2 |
Y |
N |
|
25/01/2022 |
WSR37 |
Mid-Ebb |
5.5 |
Y |
N |
27/01/2022 |
WSR1 |
Mid-Ebb |
10.3 |
Y |
Y |
WSR33 |
Mid-Ebb |
10.3 |
Y |
Y |
|
29/01/2022 |
WSR3 |
Mid-Ebb |
9.3 |
Y |
Y |
WSR4 |
Mid-Ebb |
19.0 |
Y |
Y |
|
31/01/2022 |
WSR1 |
Mid-Flood |
5.3 |
Y |
N |
WSR3 |
Mid-Flood |
11.3 |
Y |
Y |
|
WSR4 |
Mid-Flood |
6.2 |
Y |
Y |
|
WSR16 |
Mid-Flood |
6.1 |
Y |
Y |
|
WSR33 |
Mid-Ebb |
6.5 |
Y |
Y |
Table E3 Summary of Exceedance in February 2022
Date |
Station |
Tide |
SS Level
(mg/L) |
Action Level |
Limit Level |
04/02/2022 |
WSR3 |
Mid-Flood |
6.8 |
Y |
Y |
08/02/2022 |
WSR33 |
Mid-Flood |
5.8 |
Y |
N |
WSR36 |
Mid-Flood |
6.5 |
Y |
Y |
|
WSR16 |
Mid-Ebb |
8.8 |
Y |
N |
|
WSR33 |
Mid-Ebb |
14.2 |
Y |
Y |
|
WSR36 |
Mid-Ebb |
8.7 |
Y |
N |
|
WSR37 |
Mid-Ebb |
9.3 |
Y |
Y |
|
10/02/2022 |
WSR1 |
Mid-Flood |
9.2 |
Y |
Y |
WSR2 |
Mid-Flood |
6.5 |
Y |
Y |
|
WSR3 |
Mid-Flood |
6.8 |
Y |
Y |
|
WSR33 |
Mid-Flood |
5.6 |
Y |
N |
|
WSR3 |
Mid-Ebb |
6.9 |
Y |
Y |
|
WSR33 |
Mid-Ebb |
5.8 |
Y |
N |
|
WSR37 |
Mid-Ebb |
5.3 |
Y |
N |
|
12/02/2022 |
WSR2 |
Mid-Ebb |
17.0 |
Y |
Y |
15/02/2022 |
WSR4 |
Mid-Flood |
6.3 |
Y |
Y |
WSR33 |
Mid-Flood |
7.3 |
Y |
Y |
|
WSR36 |
Mid-Flood |
8.3 |
Y |
Y |
|
WSR4 |
Mid-Ebb |
13.3 |
Y |
Y |
|
17/02/2022 |
WSR1 |
Mid-Flood |
7.3 |
Y |
Y |
WSR2 |
Mid-Flood |
14.8 |
Y |
Y |
|
WSR3 |
Mid-Flood |
13.7 |
Y |
Y |
|
WSR4 |
Mid-Flood |
16.7 |
Y |
Y |
|
WSR16 |
Mid-Flood |
15.8 |
Y |
Y |
|
WSR33 |
Mid-Flood |
10.3 |
Y |
Y |
|
WSR36 |
Mid-Flood |
6.0 |
Y |
N |
|
WSR37 |
Mid-Flood |
8.0 |
Y |
Y |
|
WSR2 |
Mid-Ebb |
19.8 |
Y |
Y |
|
WSR3 |
Mid-Ebb |
18.5 |
Y |
N |
|
WSR4 |
Mid-Ebb |
19.3 |
Y |
N |
|
WSR16 |
Mid-Ebb |
18.3 |
Y |
N |
|
19/02/2022 |
WSR2 |
Mid-Flood |
7.0 |
Y |
Y |
WSR3 |
Mid-Flood |
5.8 |
Y |
N |
|
WSR4 |
Mid-Flood |
10.2 |
Y |
Y |
|
WSR16 |
Mid-Flood |
6.8 |
Y |
Y |
|
WSR33 |
Mid-Flood |
6.2 |
Y |
Y |
|
WSR36 |
Mid-Flood |
9.2 |
Y |
Y |
|
WSR37 |
Mid-Flood |
10.8 |
Y |
Y |
|
WSR2 |
Mid-Ebb |
6.0 |
Y |
N |
|
WSR4 |
Mid-Ebb |
10.7 |
Y |
Y |
Date |
Station |
Tide |
SS Level
(mg/L) |
Action Level |
Limit Level |
|
WSR16 |
Mid-Ebb |
6.5 |
Y |
Y |
WSR36 |
Mid-Ebb |
7.0 |
Y |
Y |
|
22/02/2022 |
WSR2 |
Mid-Ebb |
9.2 |
Y |
Y |
WSR3 |
Mid-Ebb |
14.3 |
Y |
Y |
|
WSR4 |
Mid-Ebb |
8.8 |
Y |
Y |
|
WSR16 |
Mid-Ebb |
8.7 |
Y |
Y |
|
WSR36 |
Mid-Ebb |
7.7 |
Y |
Y |
|
WSR37 |
Mid-Ebb |
7.2 |
Y |
Y |
|
24/02/2022 |
WSR4 |
Mid-Ebb |
6.8 |
Y |
Y |
WSR16 |
Mid-Ebb |
5.7 |
Y |
N |
|
WSR33 |
Mid-Ebb |
5.8 |
Y |
N |
|
WSR36 |
Mid-Ebb |
6.5 |
Y |
Y |
|
26/02/2022 |
WSR33 |
Mid-Ebb |
5.2 |
Y |
N |
WSR36 |
Mid-Ebb |
5.5 |
Y |
N |
Appendix F
Waste Flow Table
Appendix G
Complaint Log
Statistical Summary of Environmental Complaints
Reporting Period |
Environmental Complaint Statistics |
||
Frequency |
Cumulative |
Complaint Nature |
|
01 December 2021 - 28 February
2022 |
0 |
0 |
N/A |
Statistical Summary of Environmental Summons
Reporting Period |
Environmental Summons Statistics |
||
Frequency |
Cumulative |
Details |
|
01 December 2021 - 28 February
2022 |
0 |
0 |
N/A |
Statistical Summary of Environmental Prosecution
Reporting Period |
Environmental Prosecution Statistics |
||
Frequency |
Cumulative |
Details |
|
01 December 2021 - 28 February
2022 |
0 |
0 |
N/A |
Appendix H
Event/ Action Plan for Water Quality Exceedance
Appendix I
Event/
Action Plan for Construction Noise Exceedance
